Council Information Session/Workshop
Agenda
Notice of Information Session/Workshop Te Pānui o te Hui:
A Council Information Session/Workshop will be held on:
Date: Tuesday 29 April 2025
Time: 9.30 am – 3.15 pm
Venue: Council Chambers, Civic Offices,
53 Hereford Street, Christchurch
Membership Ngā Mema
Chairperson Deputy Chairperson Members |
Mayor Phil Mauger Deputy Mayor Pauline Cotter Councillor Kelly Barber Councillor Melanie Coker Councillor Celeste Donovan Councillor Tyrone Fields Councillor James Gough Councillor Tyla Harrison-Hunt Councillor Victoria Henstock Councillor Yani Johanson Councillor Aaron Keown Councillor Sam MacDonald Councillor Jake McLellan Councillor Andrei Moore Councillor Mark Peters Councillor Tim Scandrett Councillor Sara Templeton |
28 April 2025
|
|
Principal Advisor Mary Richardson Chief Executive Tel: 941 8999 |
![]() |
TABLE OF CONTENTS NGĀ IHIRANGI
1. Apologies Ngā Whakapāha.............................................. 3
Information Session/Workshop Items
2. Mass rapid transit update....................................... 5
10.30 am – 11.00 am
Presenters: Jane Cameron - Team Leader, Strategic Transport and Lynette Ellis - Head of Transport
Break: 11.00 am – 11.15 am
3. Subdivision Approval Process................................. 7
11.15 am – 12.15 pm
Presenters: Mark Stevenson – Head of Planning and Consents and Lynette Ellis – Head of Transport and Waste
Lunch: 12.15 pm – 1.15 pm

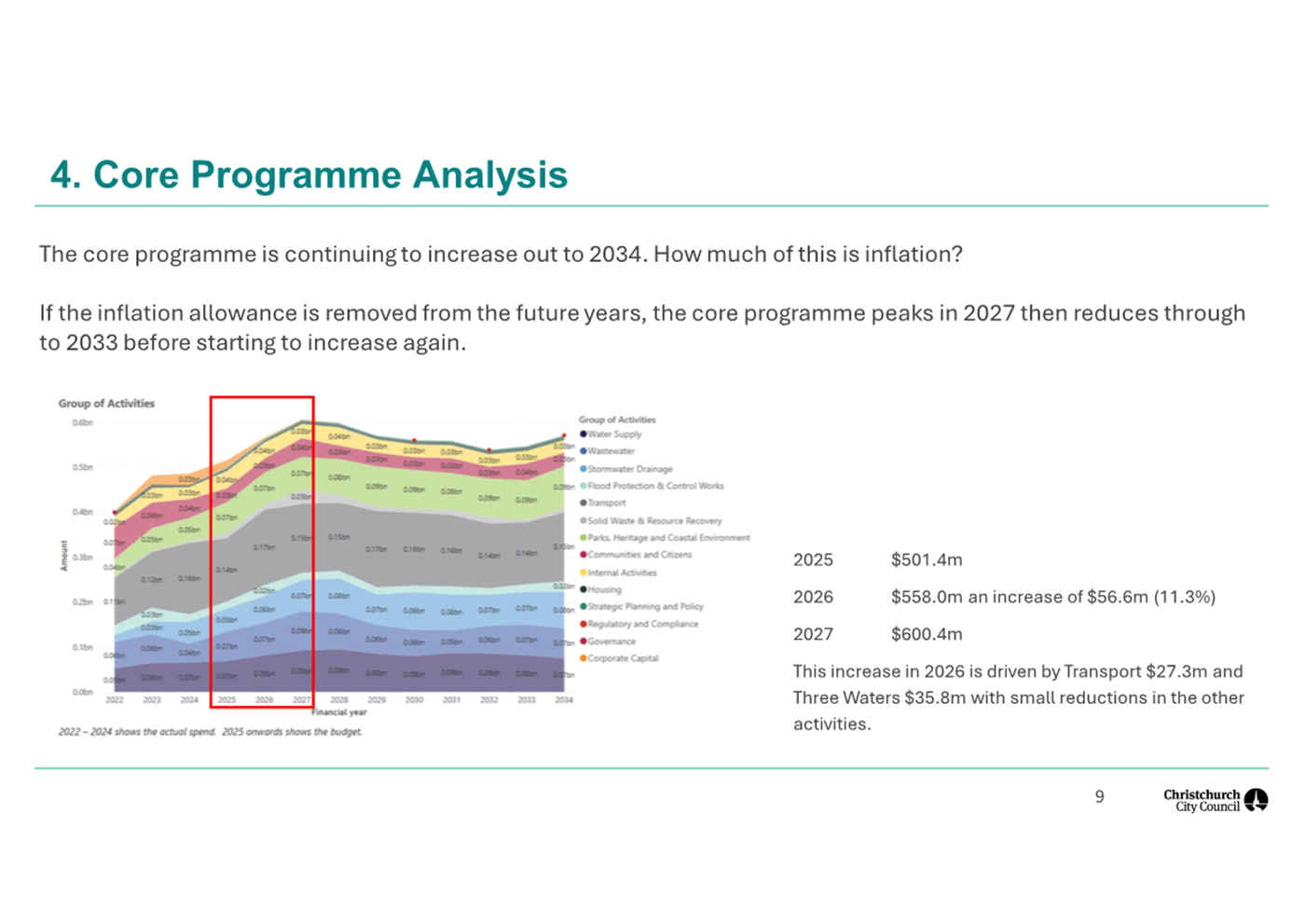

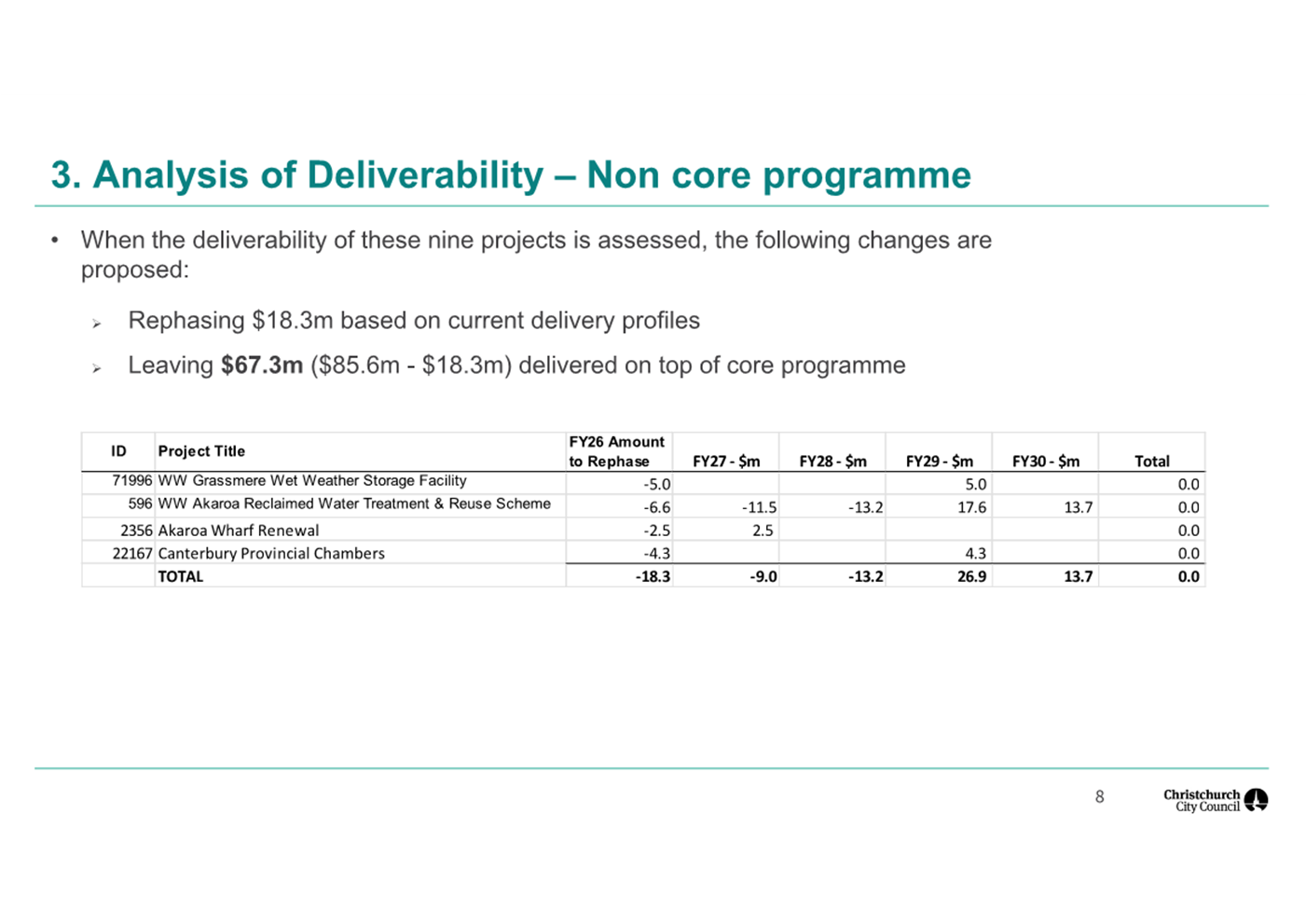

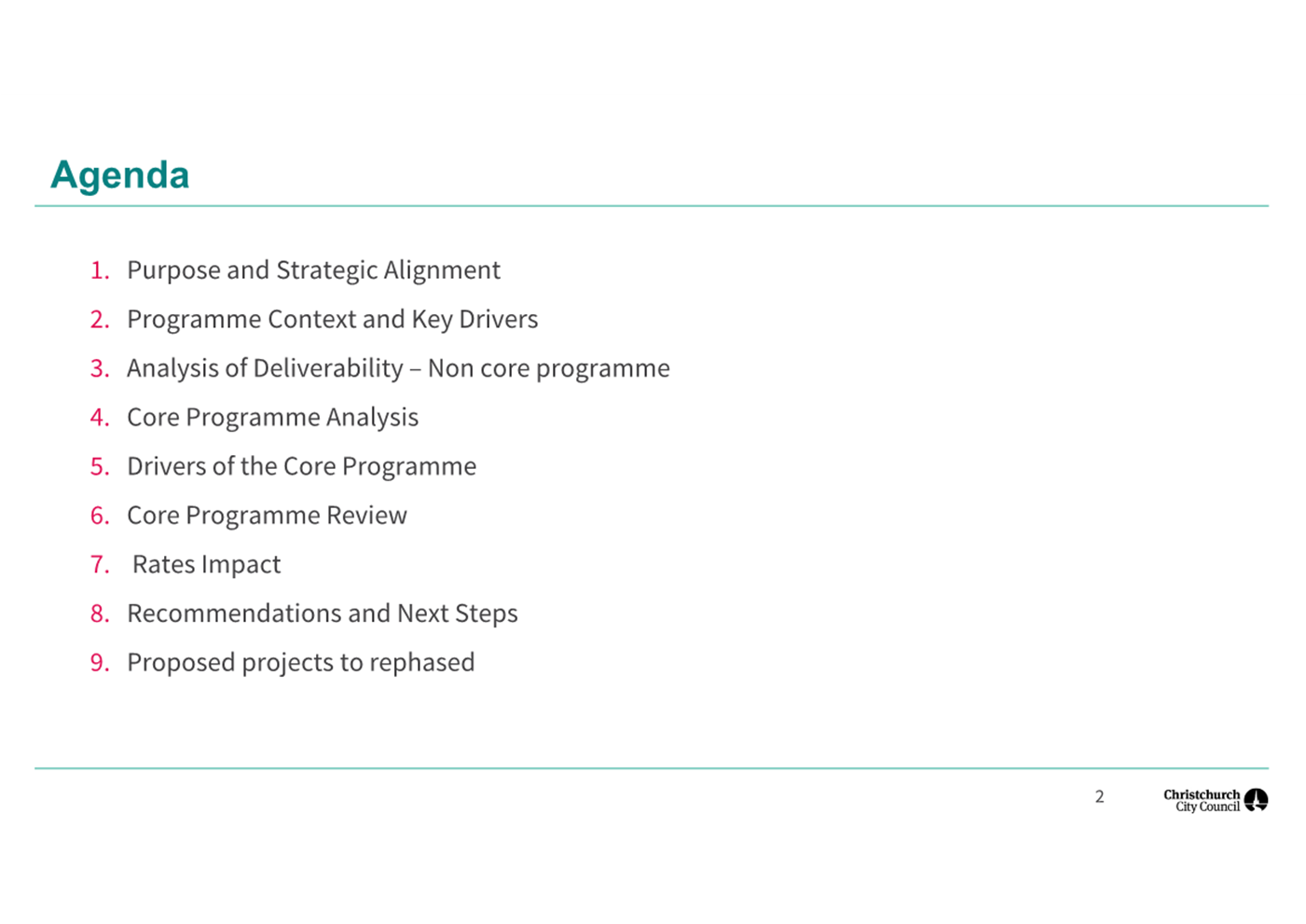

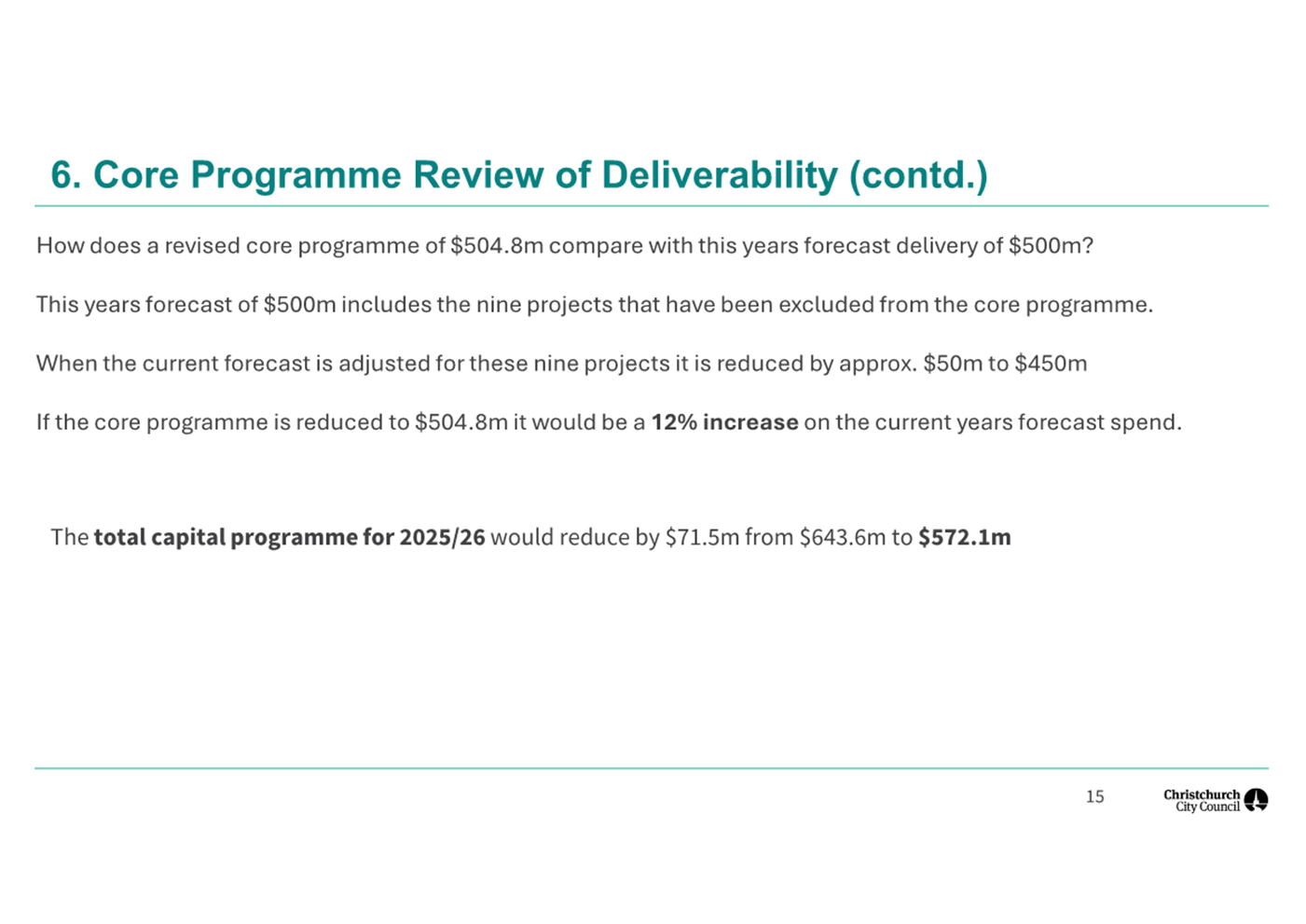

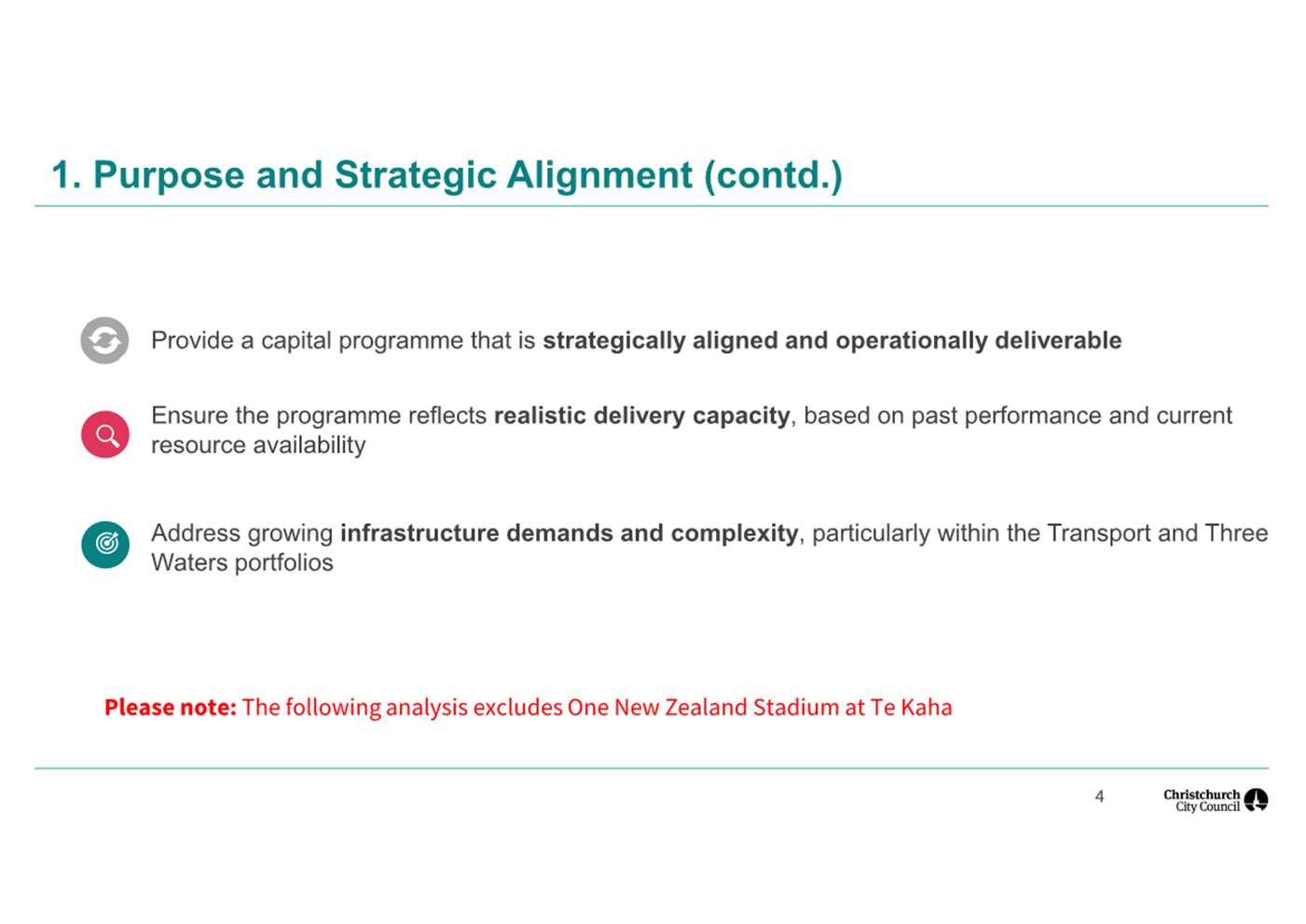

4. Capex Deliverability............................................... 9
1.15 pm – 2.15 pm
Presenter: Paul Dadson - Senior Cap. Prog. Advisor Parks & Fac
5. Local Water Done Well: Consultation Summary and Next Steps............................................................ 31
2.15 pm – 3.15 pm
Presenter: Luke Adams - Principal Advisor Strategic Policy
6. Items Closed to the Public..................................... 33
2. Mass rapid transit update |
|
Reference Te Tohutoro: |
25/585405 |
Presenter(s) Te Kaipāhō : |
Jane
Cameron, Team Leader, Strategic Transport; |
1. Detail Te Whakamahuki
Purpose and Origin |
· Leadership of the mass rapid transit (MRT) project transitioned from NZ Transport Agency Waka Kotahi (NZTA) to CCC in December 2024. · The purpose of this Information Session is to provide Councillors with an MRT project update, including its inter-relationship with the wider Greater Christchurch public transport improvement programme. |
Timing |
The Information Session is expected to last for 30 minutes. |
Outcome Sought |
Councillors have up to date information on MRT project implementation progress. |
ELT Consideration |
The ELT project sponsor, GM Strategy, Planning and Regulatory Services has endorsed the provision of this project update. |
Next Steps |
Further progress updates will be provided to Councillors following completion of more detailed project planning. |
Key points / Background |
· Mass rapid is a key move of the Greater Christchurch Spatial Plan, and is the next step once improvements to the existing public transport system have been fully implemented. · Planning for mass rapid transit has now been transferred from NZTA to CCC. Councillors last received a project status update in a memo circulated on 11 December 2024. · The focus of the next stage of the project is on route protection for the agreed corridor between Hornby and Belfast. Detailed scoping of this phase is progressing and will initially involve technical design work around stations and key intersections to confirm land requirements. · On some parts of the corridor, this work will be more complex than others due to interdependencies with other planning work underway, such as, NZTA’s upcoming Hornby and Airport Surrounds State Highway scoping study. · This work will feed into a Route Protection Detailed Business Case and then a Notice of Requirement for designation. · While CCC is now responsible for delivering this stage of the work, NZTA and ECan will continue to be closely involved. Other Greater Christchurch Partners will also be kept informed and given opportunities for input. · On 7 March 2025 the Greater Christchurch Partnership Committee was given an update on the project and its inter-relationship with the wider public transport improvement programme. This information session builds on that progress update.
|
Useful Links |
· Agenda pack,
recording, and notes from the update to the Greater Christchurch Partnership
committee meeting on 7 March 2025. |
Attachments Ngā Tāpirihanga
There are no attachments to this coversheet.
Signatories Ngā Kaiwaitohu
Authors |
Chris Morahan - Principal Advisor Strategic Transport Jane Cameron - Team Leader Transport |
Approved By |
Mark Stevenson - Acting Head of Planning & Consents John Higgins - General Manager Strategy, Planning & Regulatory Services |
3. Subdivision Approval Process |
|
Reference Te Tohutoro: |
25/668800 |
Presenter(s) Te Kaipāhō : |
Mark
Stevenson – Head of Planning and Consents |
1. Detail Te Whakamahuki
Purpose and Origin |
· Council has a rigorous process for the consenting and development of subdivisions in the district. This includes undertaking engineering approvals and safety audits. · Staff have become aware of a gap in the approval process for subdivisions which has resulted in further work. · This information session will outline the subdivision approval process, next steps for approvals for existing subdivisions and changes to the future process for subdivision approvals. |
Timing |
This information session is expected to last for 60 minutes. |
Outcome Sought |
· Awareness of the subdivision process and the requirements of the regulatory process. · Understanding of the approvals gap that has been identified. · Understanding of next steps that will be undertaken with the Community Boards. |
ELT Consideration |
ELT members have not briefed. |
Next Steps |
Following this briefing, staff will begin the process of presenting reports to Community Boards. This will cover: · Legalisation of the signs and lines within the completed subdivision. · Approval of the changes to the existing road network. · Recommendations to Council for any Part A decisions. Staff are also reviewing and updating the process required to gain all appropriate approvals for subdivisions. This will be updated with developers moving forward. |
Key points / Background |
· When land is being developed, the District Plan includes rules for new roads while also seeking to ensure existing roads that road or property access is provided to are of an appropriate standard. This may involve adding footpaths, creating access points, safety improvements and planning where new roads connect to existing ones. · Decisions on subdivision applications are generally decided without public notification, as outlined in the District Plan and are made under staff delegations. · The conditions associated with a resource consent for a subdivision requires the developer to construct roads and roading infrastructure inside the new development that will later be vested with the Council, as well as providing appropriate connections to existing Council-owned infrastructure. · As part of the consenting process for a subdivision, there are roading standards and specifications that developers must meet. This includes ensuring that all engineering approvals and safety audits are undertaken. · Staff recently discovered that some work in current subdivisions, including new road infrastructure such as signage and road markings, intersection upgrades and connections to existing roads, were carried out without community board approval. · This issue has been most prominent in areas where there has been high demand for the development of rural land, such as Halswell. |
Useful Links |
· Subdivision consent activities : Christchurch City Council |
Attachments Ngā Tāpirihanga
There are no attachments to this coversheet.
Signatories Ngā Kaiwaitohu
Authors |
Jacob Bradbury - Manager Planning & Delivery Transport Lynette Ellis - Head of Transport & Waste Management |
Approved By |
Mark Stevenson - Acting Head of Planning & Consents John Higgins - General Manager Strategy, Planning & Regulatory Services |
4. Capex Deliverability |
|
Reference Te Tohutoro: |
25/715890 |
Presenter(s) Te Kaipāhō : |
Paul Dadson, Senior Cap. Prog. Advisor Parks & Fac. |
1. Detail Te Whakamahuki
Purpose and Origin of the Workshop |
The purpose of this workshop is to provide Councillors with an update on the deliverability of the capital programme included in the 2025/26 draft Annual Plan. |
Timing |
This workshop is expected to last for 60 minutes. |
Outcome Sought |
Councillors consider the information provided in this workshop and include the recommendations in the adoption of the 2025/26 Annual Plan. |
ELT Consideration |
The information included in this workshop was presented to ELT on 27 March 2025. The comments and feedback received at this meeting has been incorporated into this workshop. |
Next Steps |

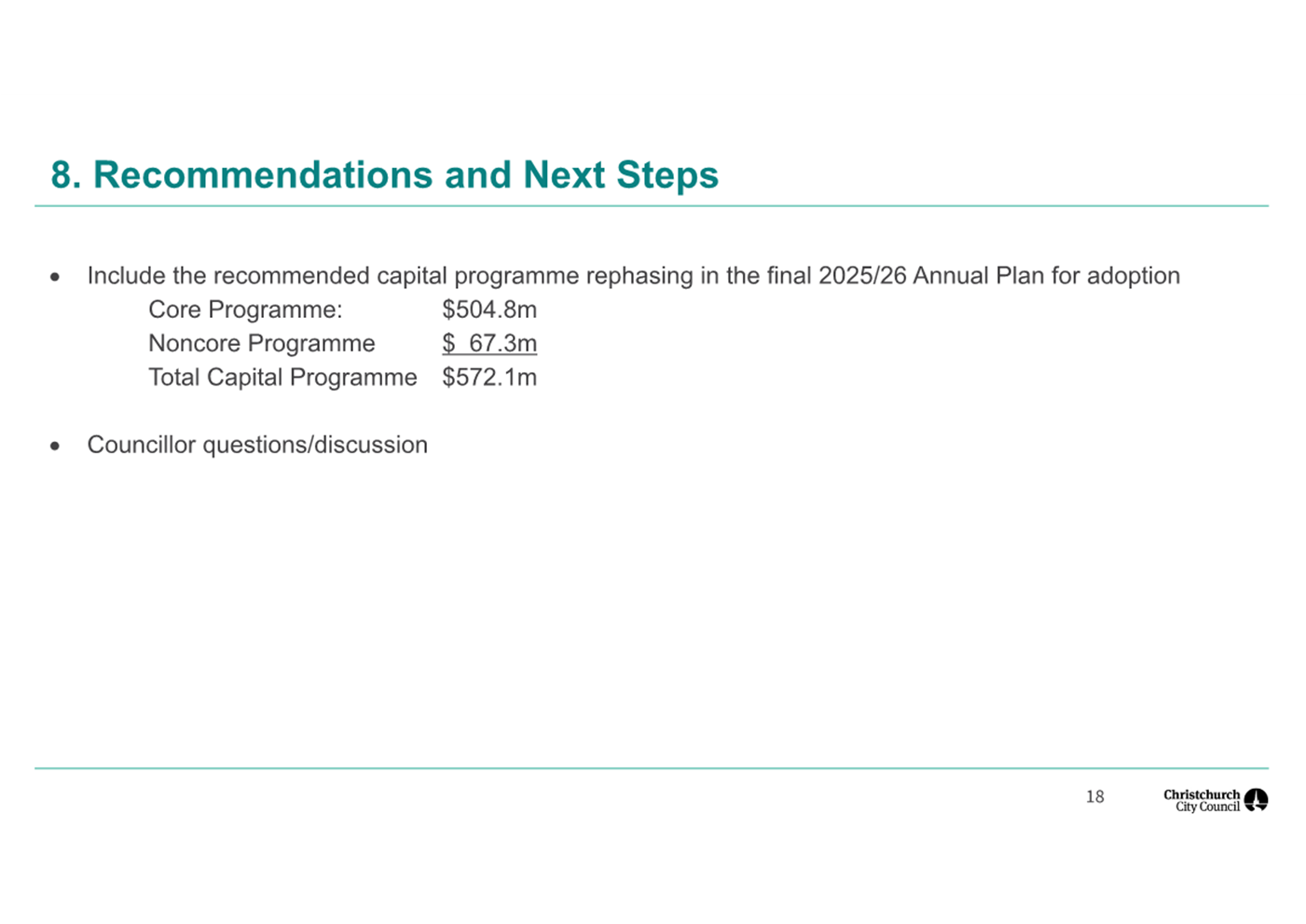

Guidance will be sort at the upcoming 2025/26 Annual Plan workshops on whether the capital programme recommendations outlined in this workshop are included in the final 2025/26 Annual Plan that will be considered for adoption in June 2025. |
Key points / Background |

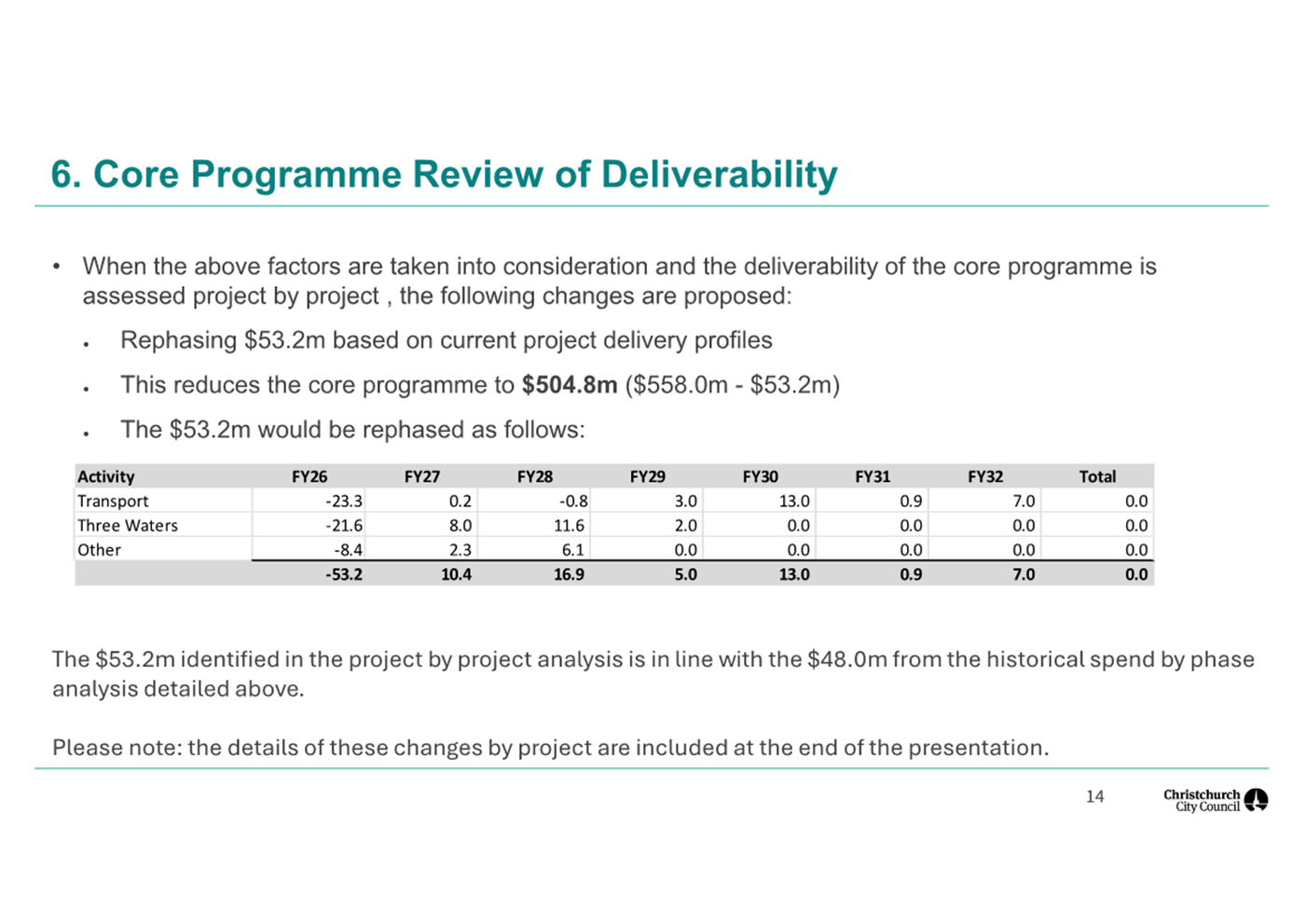

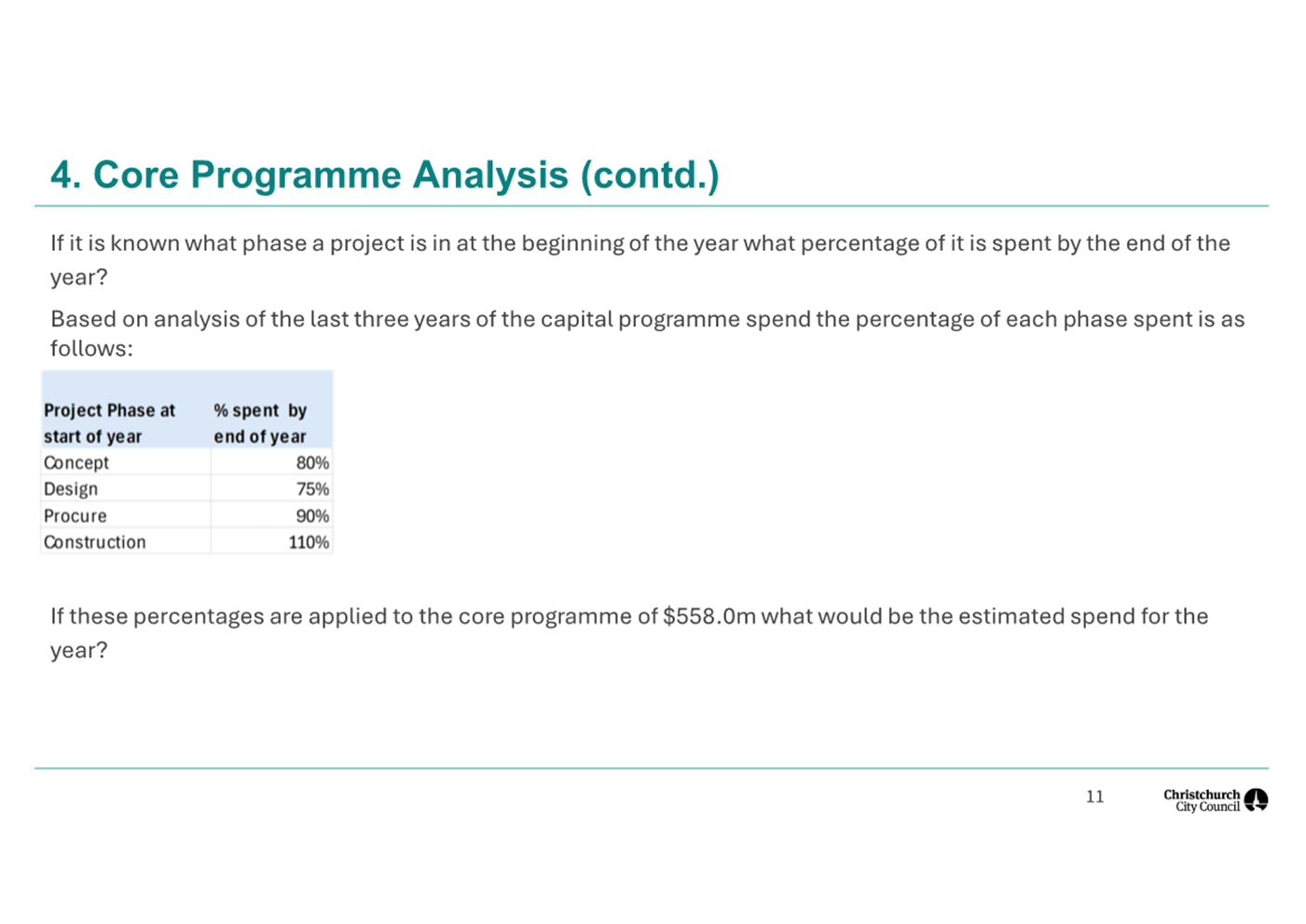

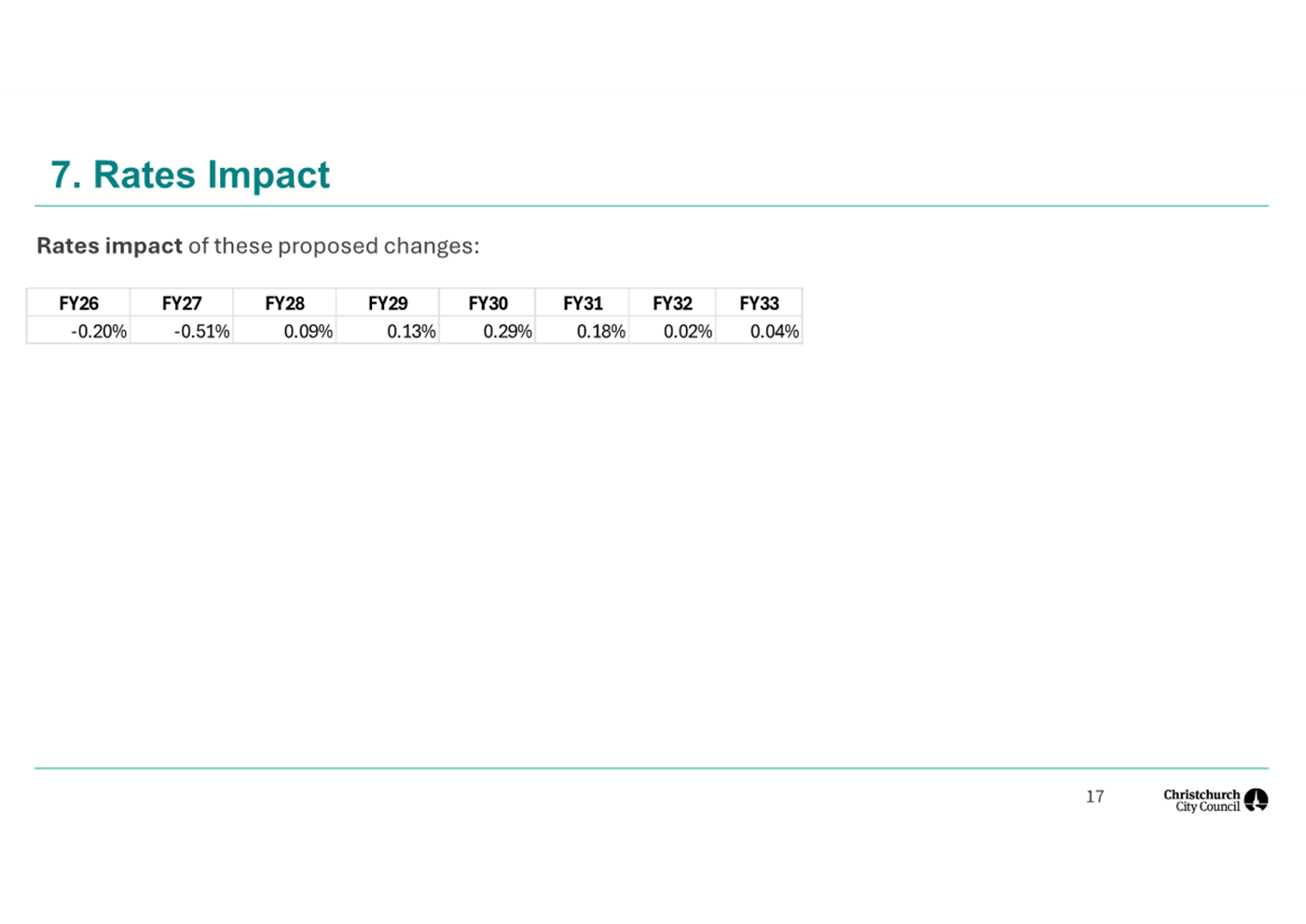

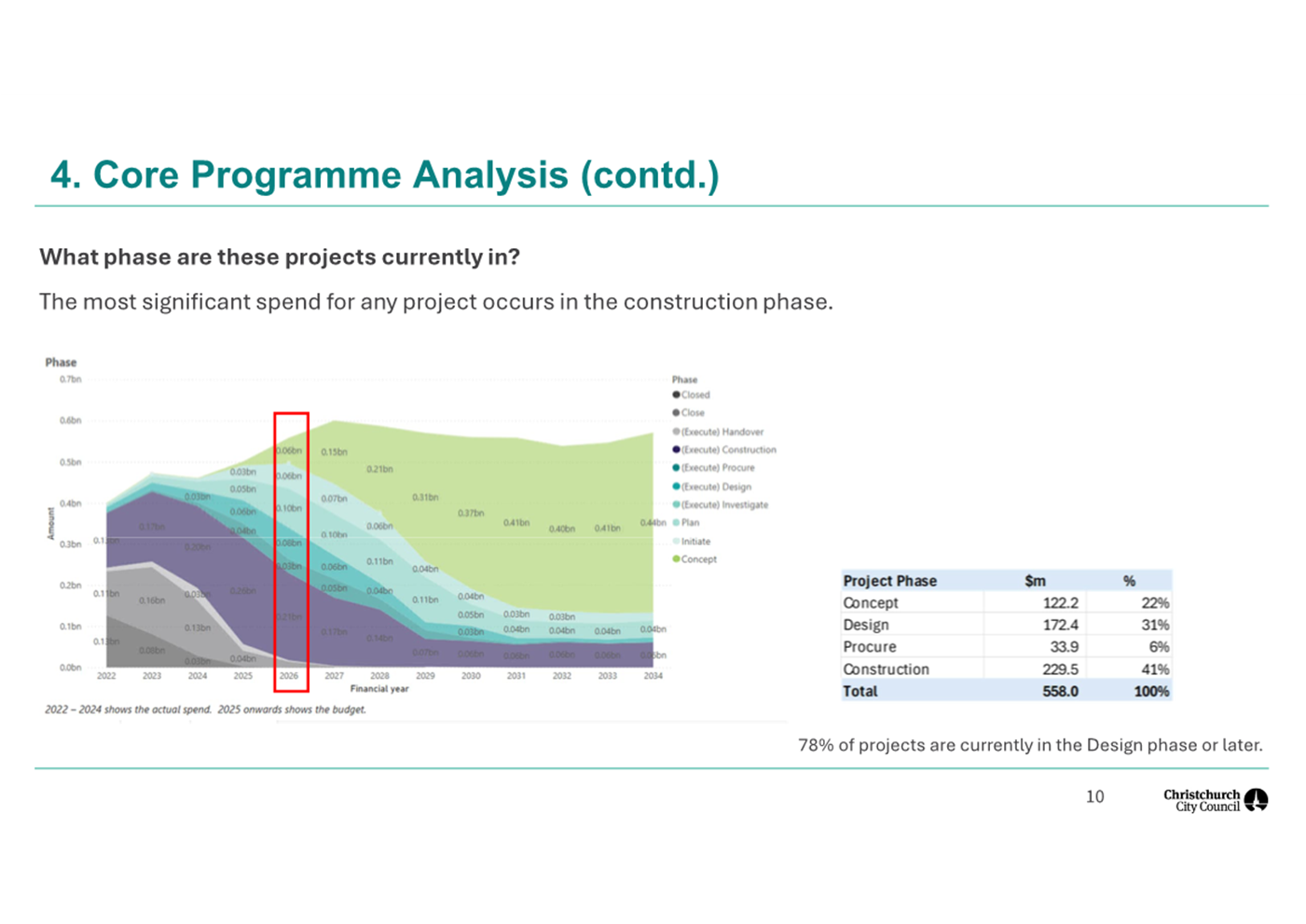

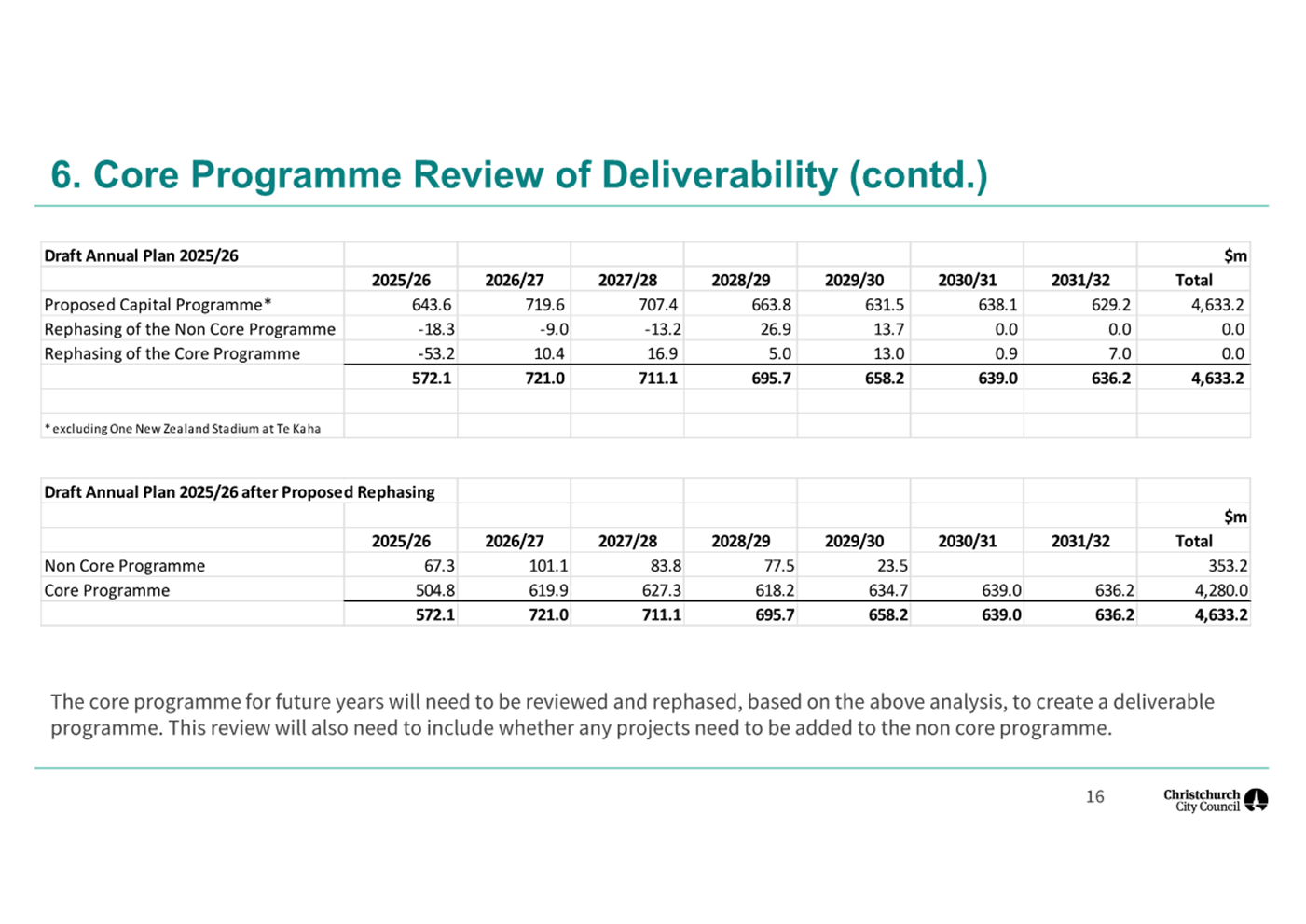

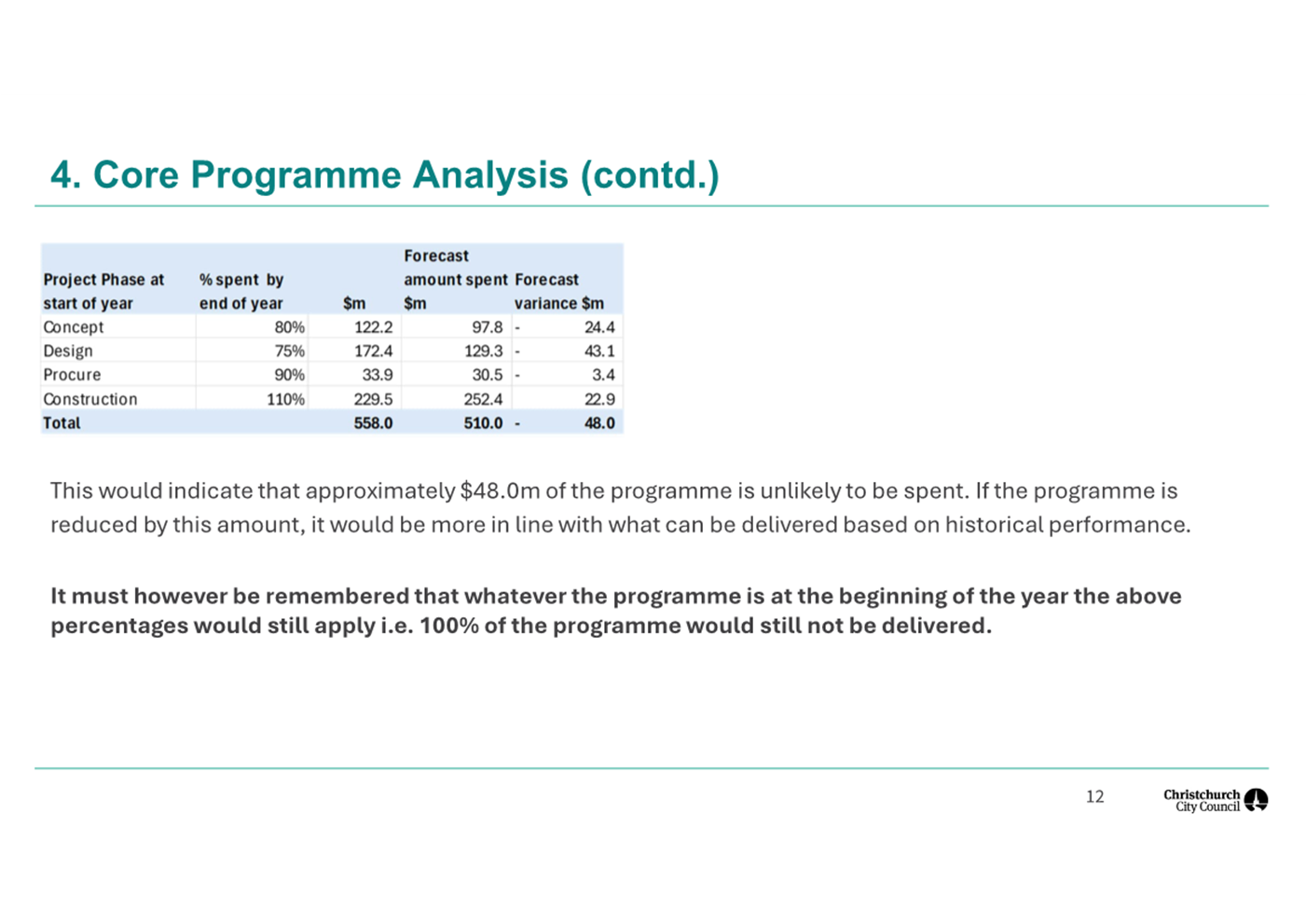

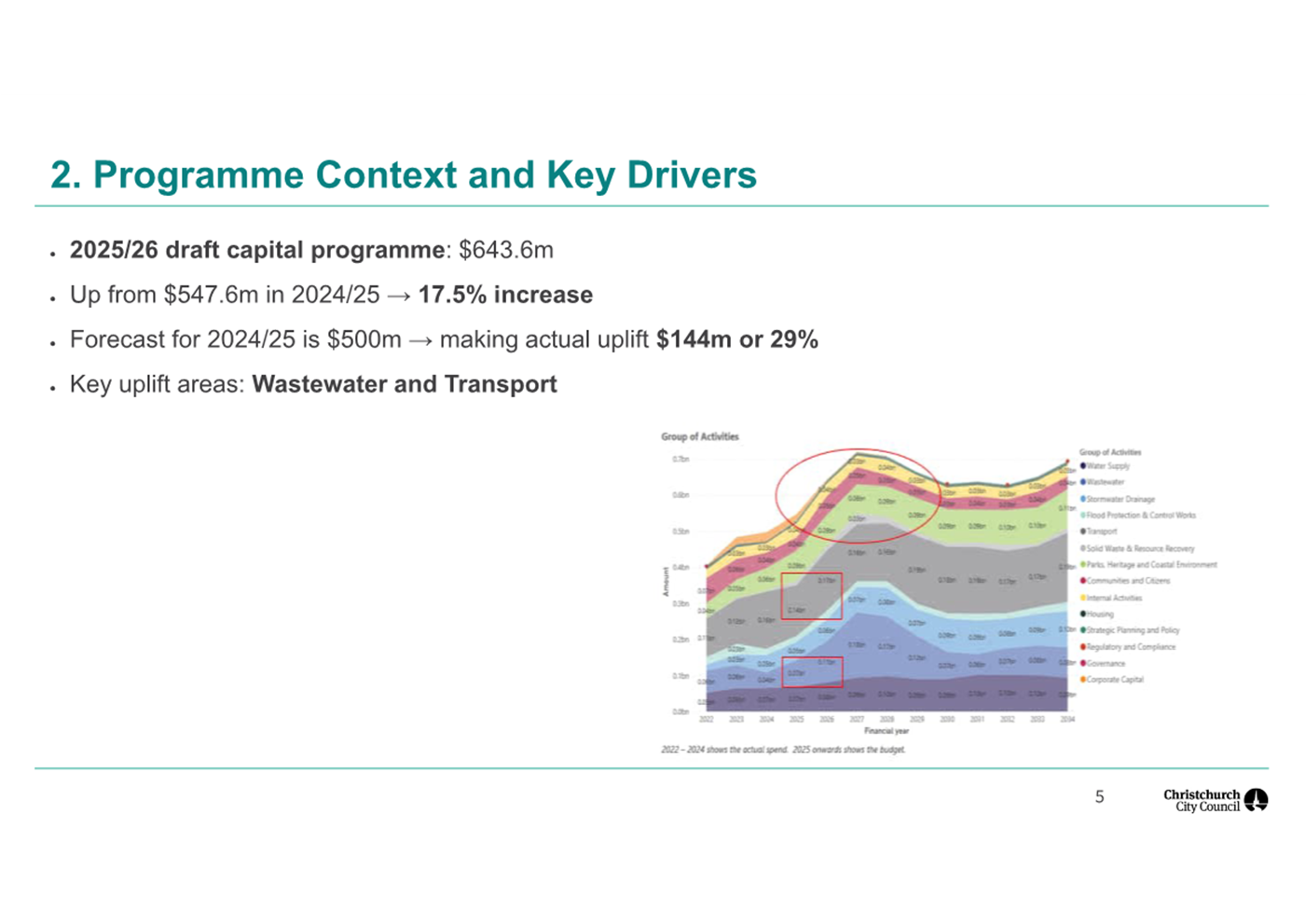

· The capital programme included in the draft 2025/26 Annual Plan is 18% higher than the current budget for 2024/25 and 26% higher than the forecast spend. · This level of increase has raised questions about the deliverability of the draft capital programme |
Useful Links |
Attachments Ngā Tāpirihanga
No. |
Title |
Reference |
Page |
a ⇩ |
2025 26 Draft Capital Programme Deliverability Workshop 29042025 |
25/754974 |
10 |
Signatories Ngā Kaiwaitohu
Author |
Paul Dadson - Senior Capital Programme Advisor Parks & Facilities |
Approved By |
Nicky Palmer - Head of Programme Management Office Brent Smith - General Manager City Infrastructure Bede Carran - General Manager Finance, Risk & Performance / Chief Financial Officer |
5. Local Water Done Well: Consultation Summary and Next Steps |
|
Reference Te Tohutoro: |
25/780407 |
Presenter(s) Te Kaipāhō : |
Luke Adams, Principal Advisor Strategic Policy |
1. Detail Te Whakamahuki
Purpose and Origin |
Purpose: · To provide elected members with an overview of the Local Water Done Well framework, a summary of the water service delivery model options, and the results of consultation to support informed decision-making ahead of the 7 May Council meeting. Key Topics: · Recap of the Local Water Done Well framework and legislative context · Summary of the water service delivery model options that the Council consulted on · Recap on the evaluation findings: strategic and financial assessment · What we heard through consultation and hearings · Next steps toward finalising the Water Services Delivery Plan |
|
Timing |
This information session is expected to last for 60 minutes. |
|
Outcome Sought |
To ensure elected members are well-briefed on the options, public feedback, and implications, ahead of considering the final decision report.Elected members have the opportunity to seek clarification, ask questions, and address any concerns in preparation for the formal Council meeting. |
|
ELT Consideration |
N/A |
|
Next Steps |
· Council decision on proposed delivery model – 7 May 2025 · Finalisation of full Water Services Delivery Plan for submission by 3 September 2025 · Ongoing operational planning and engagement |
|
Key points / Background |
· The Local Water Done Well framework replaces the previous Three Waters Reform Programme. It focuses on delivering safe, reliable, and financially sustainable water services, while retaining local council ownership and governance. · The framework responds to key challenges such as aging infrastructure, historical underinvestment, and inconsistent service levels across New Zealand. · Councils are required to develop and submit a Water Services Delivery Plan to the Department of Internal Affairs by 3 September 2025. This plan must include a proposed service delivery model and demonstrate how the council will meet new regulatory, financial, and operational standards. · Public consultation is a statutory requirement under the LWDW framework. Councils must consult on their preferred model and at least one alternative before confirming the proposed delivery model for inclusion in the WSDP. The Council has completed an indicative business case, evaluated three delivery model options, and consulted with the public. The In-House Delivery Model was presented as the proposed option, alongside two alternatives: a Three-Waters WSCCO and a Two-Waters WSCCO.A total of 681 submissions were received, and hearings were held on 15 April 2025. |
|
Useful Links |
Local Water Done Well: Service Delivery Models for Consultation. Council Resolution CNCL/2025/00151, page 4. https://christchurch.infocouncil.biz/Open/2025/02/CNCL_20250219_MIN_8571_AT.PDF
Local Water Done Well: Service Delivery Models for Consultation. Council Report, page 5. https://christchurch.infocouncil.biz/Open/2025/02/CNCL_20250219_AGN_8571_AT.PDF |
|
Attachments Ngā Tāpirihanga
No. |
Title |
Reference |
Page |
Indicative Business Case - Water Services Delivery Models (Under Separate Cover) |
25/780409 |
|
|
Local Water Done Well Consultation Document (Under Separate Cover) |
25/780412 |
|
|
Local Water Done Well Submissions Analysis (Under Separate Cover) |
25/780413 |
|
Signatories Ngā Kaiwaitohu
Author |
Luke Adams - Principal Advisor Policy |
Approved By |
David Griffiths - Head of Strategic Policy & Resilience Brent Smith - General Manager City Infrastructure |
The information session/workshop items noted from the next page will not be open to the public under the sections of the Local Government Official Information and Meetings Act 1987 (LGOIMA) outlined in the table on the following page. The full wording of the noted LGOIMA sections is found in section 6 or section 7 of the Act.
In the Council's view, these reasons for exclusion are not outweighed by public interest considerations in section 7(1) favouring their release.
The public can ask the Ombudsman to review this decision. Information about how to make a complaint is available at www.ombudsman.parliament.nz or freephone 0800 802 602.
GENERAL SUBJECT OF EACH MATTER TO BE CONSIDERED |
SECTION |
SUBCLAUSE AND REASON UNDER THE ACT |
PUBLIC INTEREST CONSIDERATION |
Potential Release Review Date and Conditions |
|
7. |
Property Update |
s7(2)(b)(ii) |
Prejudice Commercial Position |
This matter refers to a potential commerical activity and disclosure of this information could prejudice that process. |
30 April 2026 After appropriate Council decision |
8. |
Confidential - Update from Innovation and Improvement & Parks Units |
s7(2)(b)(ii), s7(2)(h) |
Prejudice Commercial Position, Commercial Activities |
Commercial and IP confidentiality. Non-disclosure agreements are in place. |
30 April 2028 Details in this briefing are not to be released, but non-confidential information will be made available at a later date. |
