Council Information Session/Workshop
Agenda
Notice of Information Session/Workshop Te Pānui o te Hui:
A Council Information Session/Workshop will be held on:
Date: Tuesday 15 April 2025
Time: 9.30 am – 12.00 pm
Venue: Council Chambers, Civic Offices,
53 Hereford Street, Christchurch
Membership Ngā Mema
|
Chairperson Deputy Chairperson Members |
Mayor Phil Mauger Deputy Mayor Pauline Cotter Councillor Kelly Barber Councillor Melanie Coker Councillor Celeste Donovan Councillor Tyrone Fields Councillor James Gough Councillor Tyla Harrison-Hunt Councillor Victoria Henstock Councillor Yani Johanson Councillor Aaron Keown Councillor Sam MacDonald Councillor Jake McLellan Councillor Andrei Moore Councillor Mark Peters Councillor Tim Scandrett Councillor Sara Templeton |
11 April 2025
|
|
|
Principal Advisor Mary Richardson Chief Executive Tel: 941 8999 |
TABLE OF CONTENTS NGĀ IHIRANGI
1. Apologies Ngā Whakapāha................................................................................. 3
Information Session/Workshop Items
2. Canterbury Museum present its Draft Annual Plan 2025/26..................................... 5
9.30am – 10.15 am
Presenters: Tom Thomson (Acting Chair), Canterbury Museum Trust Board, Anthony Wright, (Director), Canterbury Museum and Nigel Tecofsky (Financial Controller), Canterbury Museum
3. Venues Ōtautahi - Draft Statement of Intent 2025/26............................................ 35
10.15 am – 10.45 am
Presenters: Gill Cox (Chair), Caroline Harvie-Teare (CE) and Jamie Mountier (CFO)
Break: 10.45 am – 11.00 am
4. Items Closed to the Public................................................................................ 79
|
2. Canterbury Museum present its Draft Annual Plan 2025/26 |
|
|
Reference Te Tohutoro: |
25/565616 |
|
Presenter(s) Te Kaipāhō : |
Tom
Thomson, Acting Chair, Canterbury Museum Trust Board |
1. Detail Te Whakamahuki
|
Purpose and Origin |

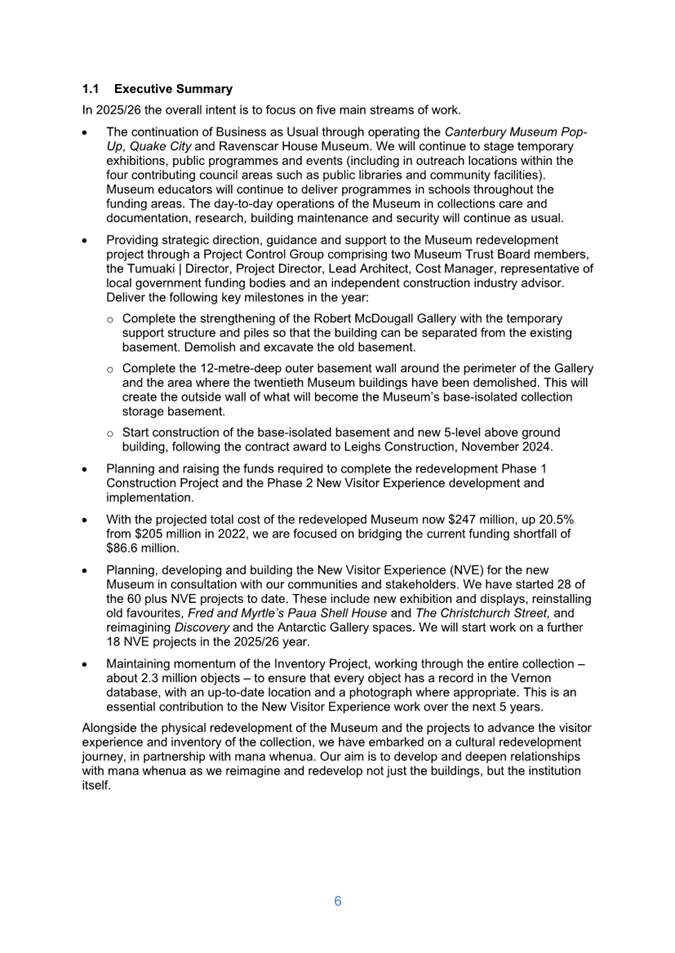

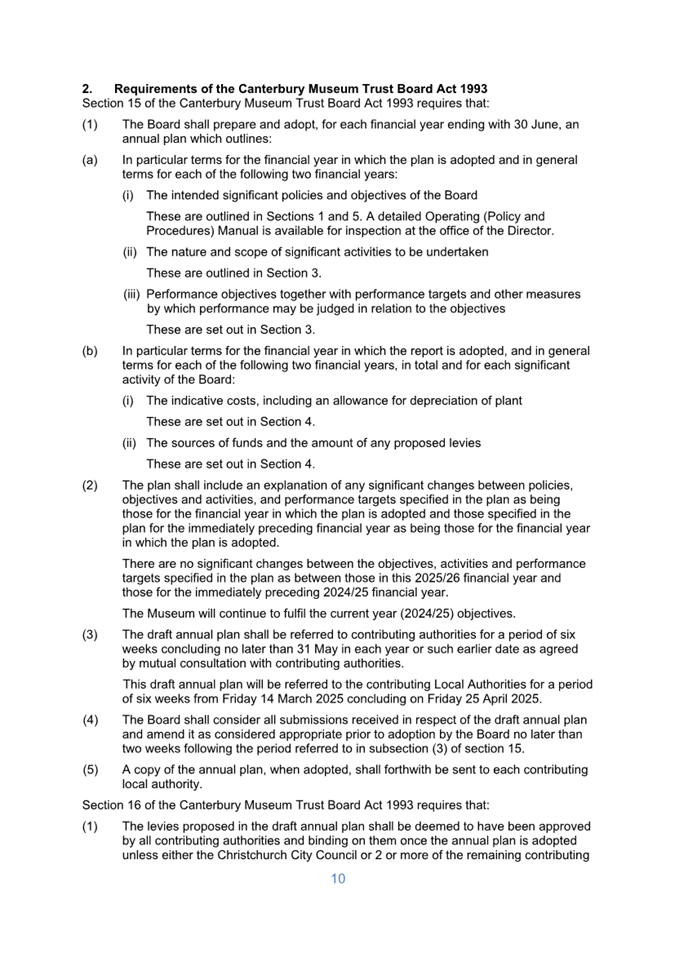

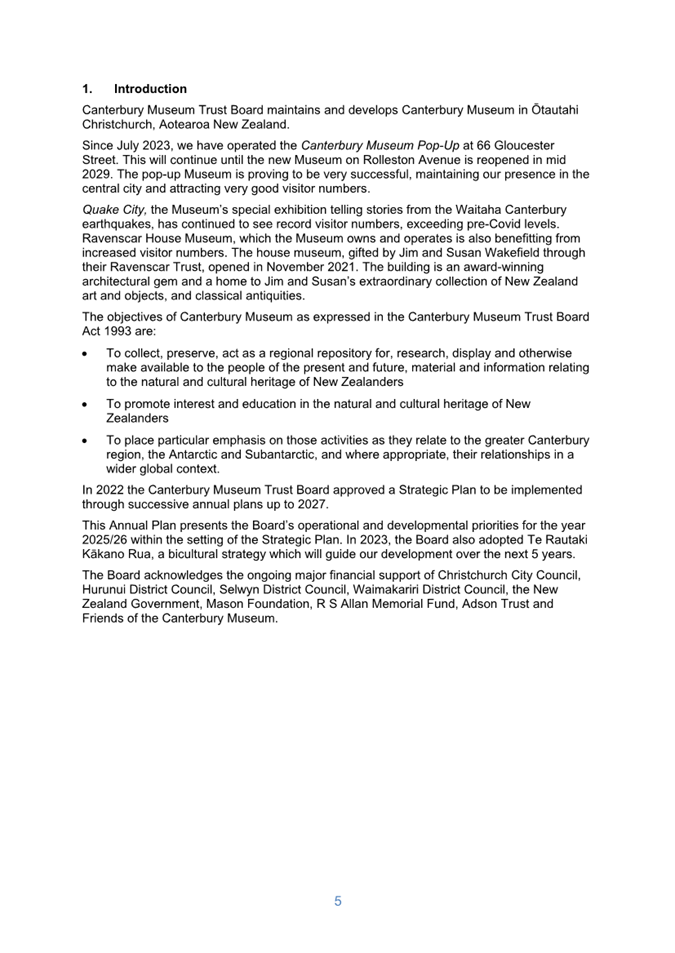

The purpose of the briefing is to allow the Museum to present its Draft 2025/26 Annual Plan as part of its consultation with Contributing Local Authorities (CLAs). This briefing comes at the request of the Museum and is consistent with previous years. The Museum's statutory 6-week referral period runs from 14 March 2025 to 25 April 2025. · Under the Canterbury Museum Trust Board Act 1993, Council (or at least two of the other CLAs) has until the end of the referral period to formally object to the proposed increase or else it is deemed to be agreed to by the CLAs. Note that under s16(3) '......The Christchurch City Council or not less than 3 other contributing authorities may resolve that the total levy be reduced to an amount being not less than the total levy made in respect of the previous year". |
|
Timing |
This information session is expected to last for 45 minutes. |
|
Outcome Sought |

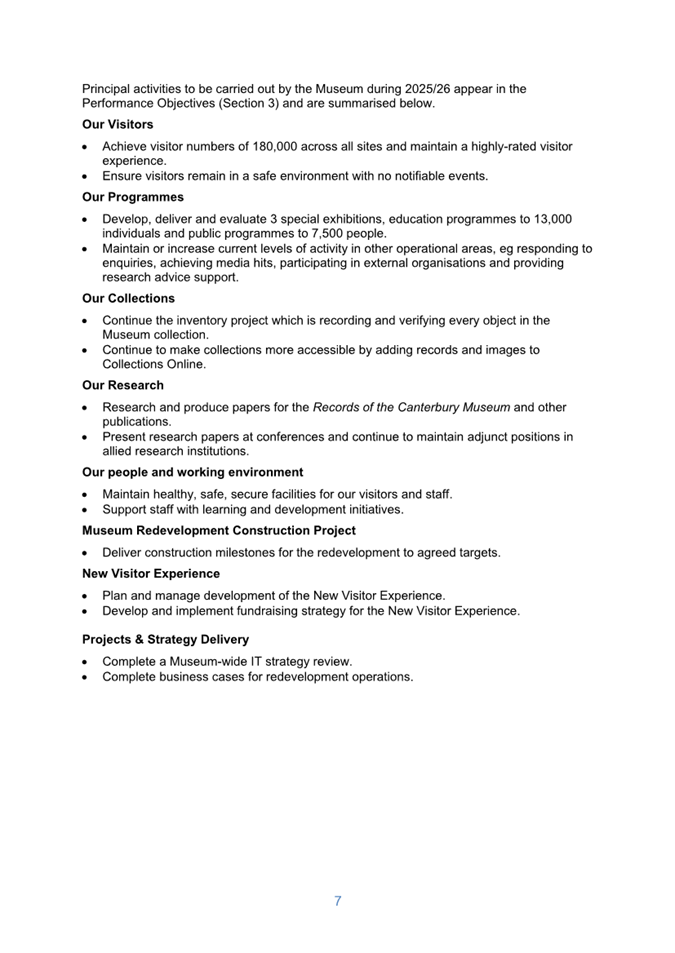

Note that the Museum’s planned 3.1% increase in the operating levy is consistent with our Draft 2025/26 Annual Plan and year 2 of our 2024/34 Long Term Plan. The Museum has informed the Council of an estimated $86.6 million funding shortfall for the balance of its redevelopment project. They are requesting an additional $25.0 million from contributing Councils ($21.1 million for Christchurch) with the balance from central government and their own fundraising. This increased funding has not been included in our Draft 2025/26 Annual Plan. A decision paper has been included in the Council agenda of 16 April to ensure Council’s feedback to the Museum can meet their deadline of 25 April 2025.
|
|
ELT Consideration |
N/A
|
|
Next Steps |
Council will consider its response at the Council meeting on 16 April 2025 to provide direction to staff on whether to exercise the right of objection and if so, advise the Museum what levy increase can be committed to. This needs to be formally advised by the Museum’s deadline of 25 April 2025. |
|
Key points / Background |

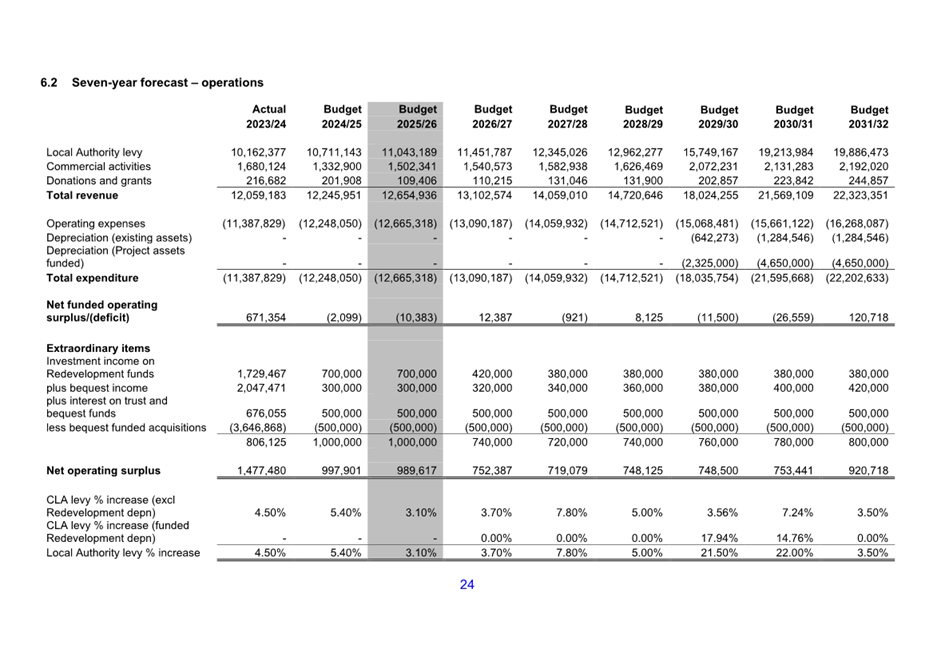

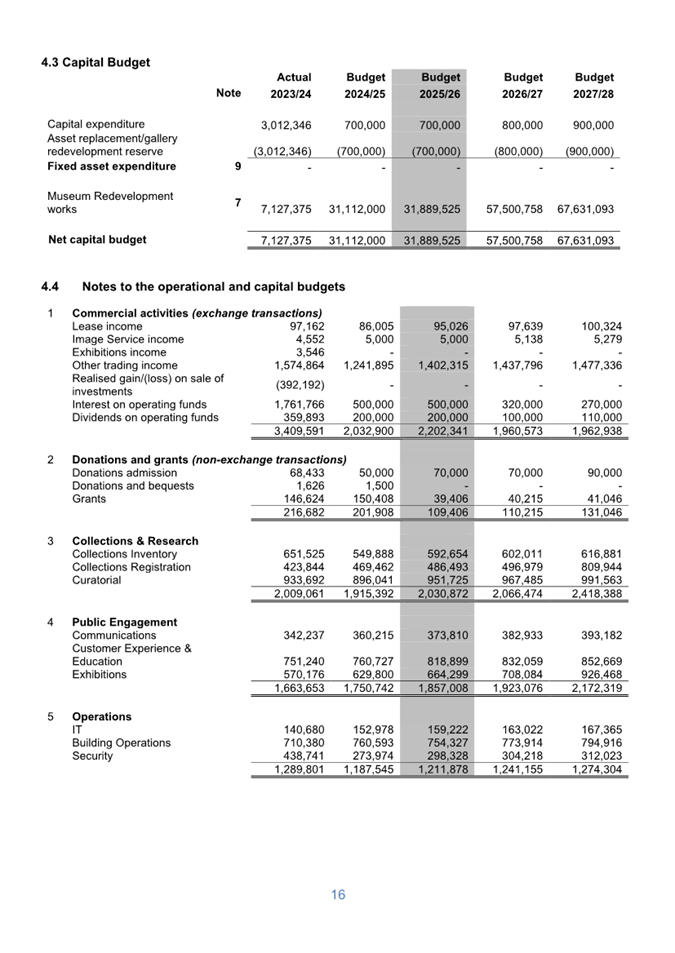

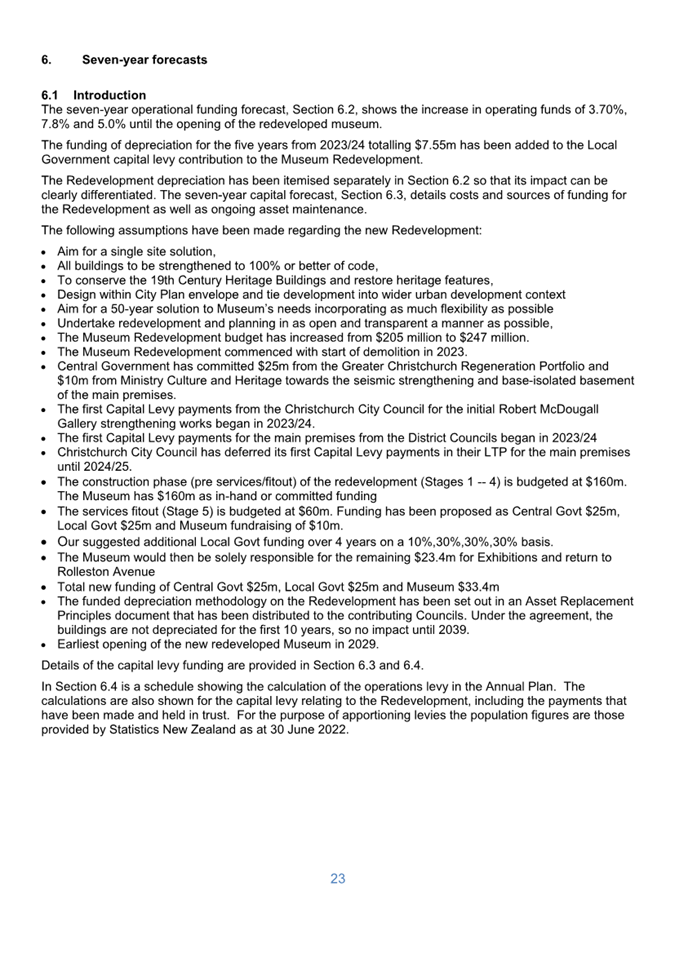

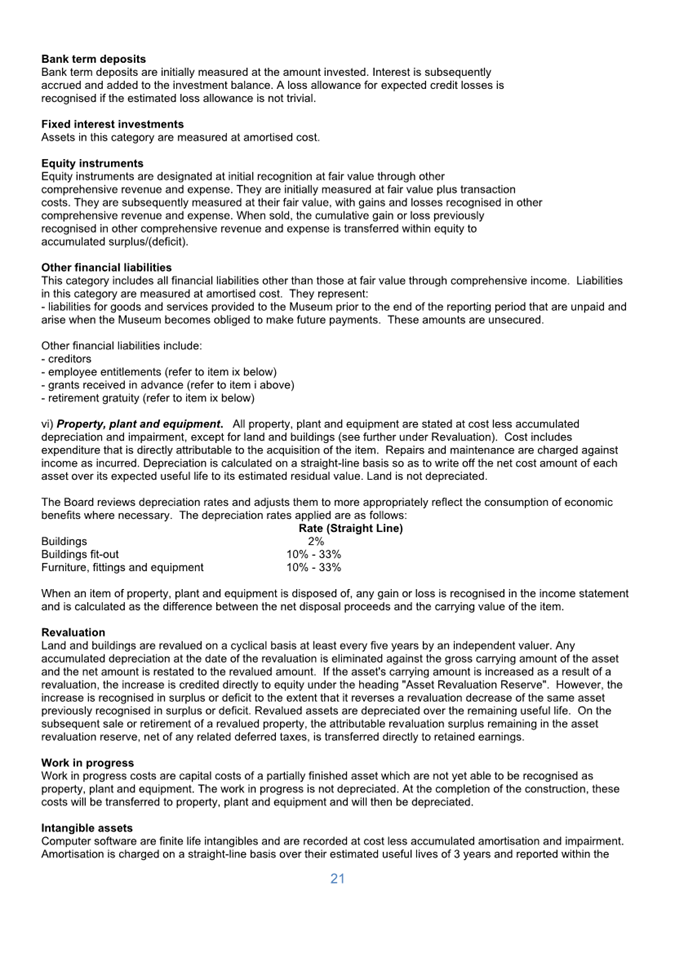

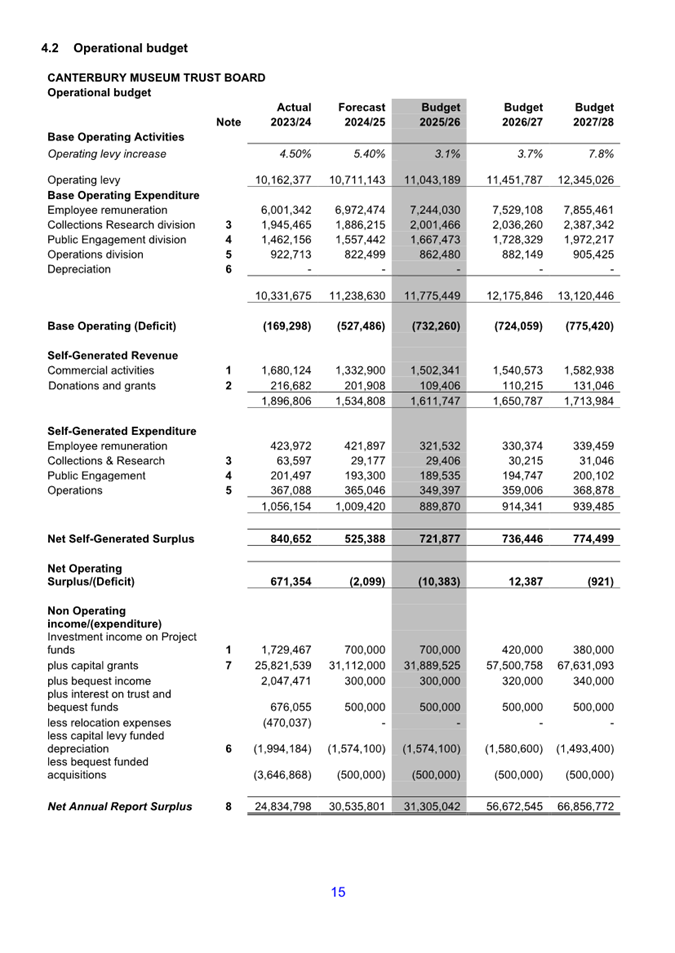

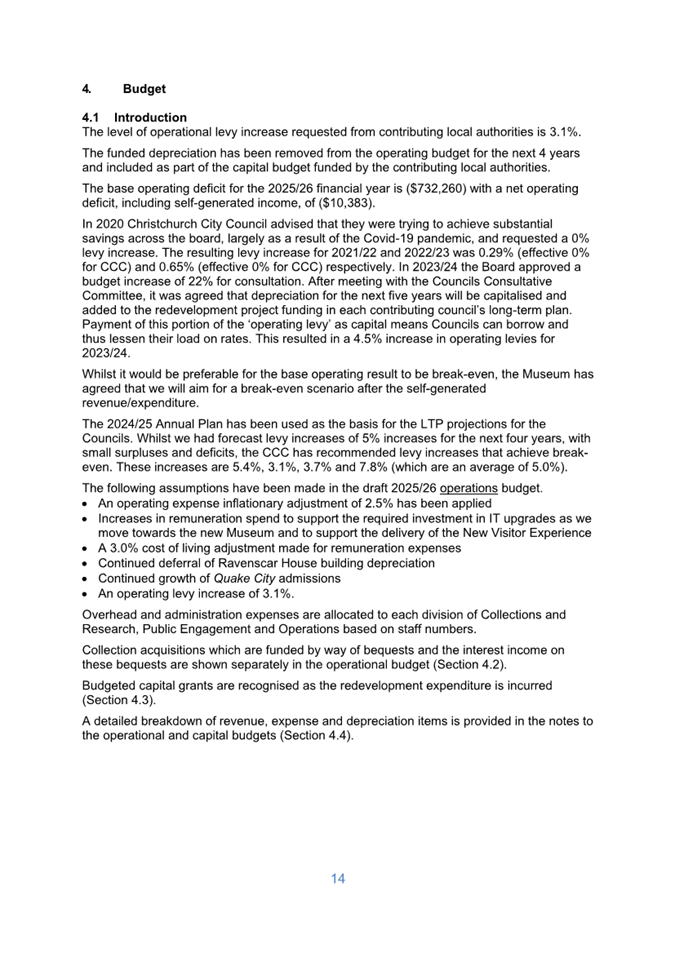

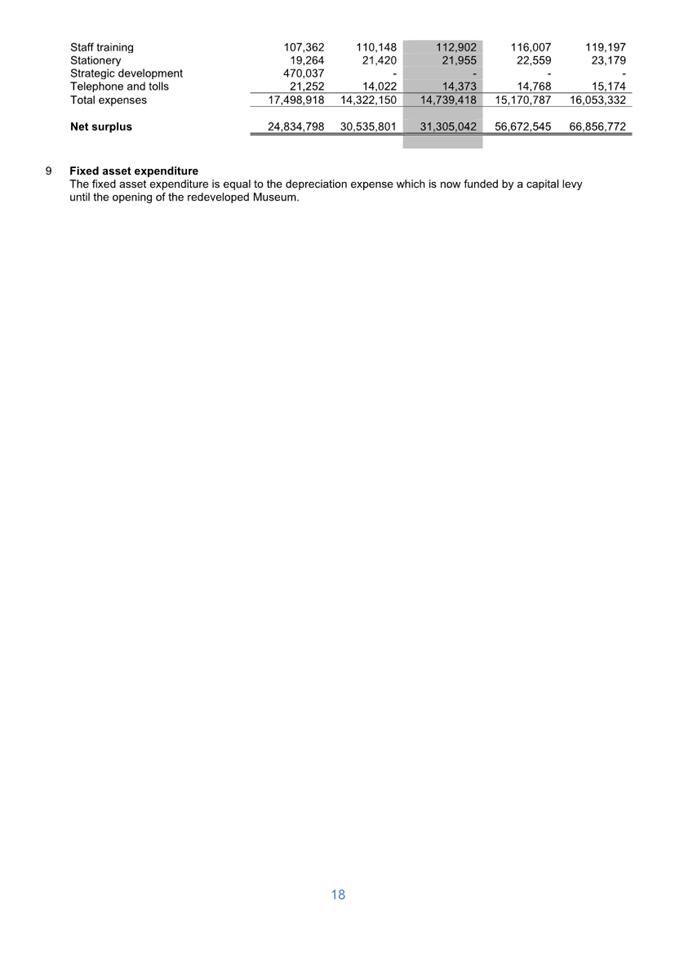

· Operating Levy Section 4.1 of the Museum's plan (Attachment A) includes a concise summary of the levy funding decisions over recent years. “The level of operational levy increase requested from contributing local authorities is 3.1%. The funded depreciation has been
removed from the operating budget for the next 4 years and included as part
of the capital budget funded by the contributing local authorities. In 2020 Christchurch City Council advised that they were trying to achieve substantial savings across the board, largely as a result of the Covid-19 pandemic, and requested a 0% levy increase. The resulting levy increase for 2021/22 and 2022/23 was 0.29% (effective 0% for CCC) and 0.65% (effective 0% for CCC) respectively. In 2023/24 the Board approved a budget increase of 22% for consultation. After meeting with the Councils Consultative Committee, it was agreed that depreciation for the next five years will be capitalised and added to the redevelopment project funding in each contributing council’s long-term plan. Payment of this portion of the ‘operating levy’ as capital means Councils can borrow and thus lessen their load on rates. This resulted in a 4.5% increase in operating levies for 2023/24. Whilst it would be preferable for the base operating result to be break-even, the Museum has agreed that we will aim for a break-even scenario after the self-generated revenue/expenditure. The 2024/25 Annual Plan has been used as the basis for the LTP projections for the Councils. Whilst we had forecast levy increases of 5% increases for the next four years, with small surpluses and deficits, the CCC has recommended levy increases that achieve break-even. These increases are 5.4%, 3.1%, 3.7% and 7.8% (which are an average of 5.0%). The following assumptions have been made in the draft 2025/26 operations budget. · An operating expense inflationary adjustment of 2.5% has been applied. · Increases in remuneration spend to support the required investment in IT upgrades as we move towards the new Museum and to support the delivery of the New Visitor Experience. · A 3.0% cost of living adjustment made for remuneration expenses · Continued deferral of Ravenscar House building depreciation · Continued growth of Quake City admissions · An operating levy increase of 3.1%. Overhead and administration expenses are allocated to each division of Collections and Research, Public Engagement and Operations based on staff numbers. Collection acquisitions which are funded by way of bequests and the interest income on these bequests are shown separately in the operational budget (Section 4.2). Budgeted capital grants are recognised as the redevelopment expenditure is incurred (Section 4.3). A detailed breakdown of revenue, expense and depreciation items is provided in the notes to the operational and capital budgets (Section 4.4).”

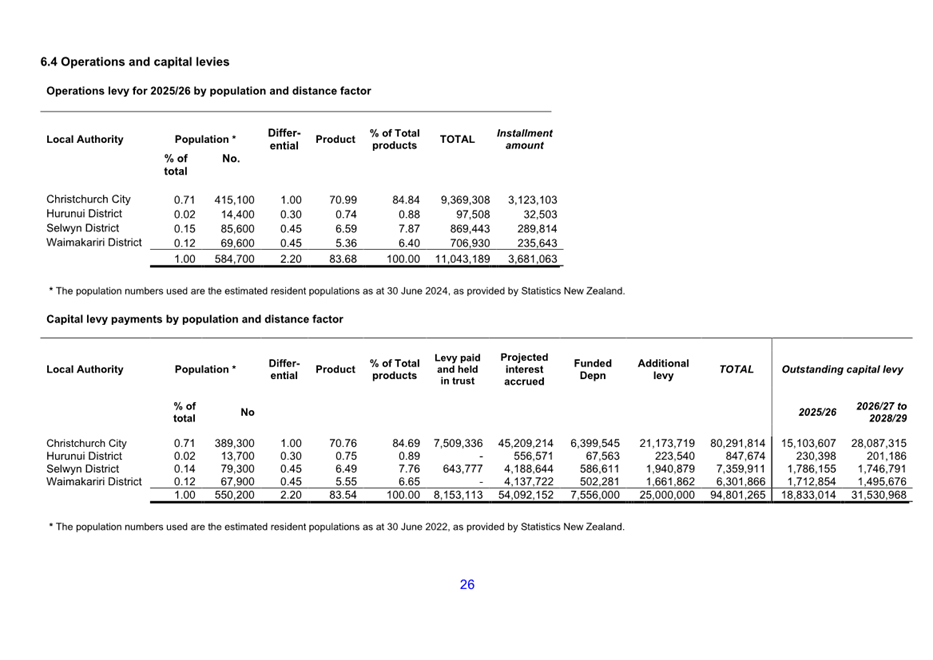

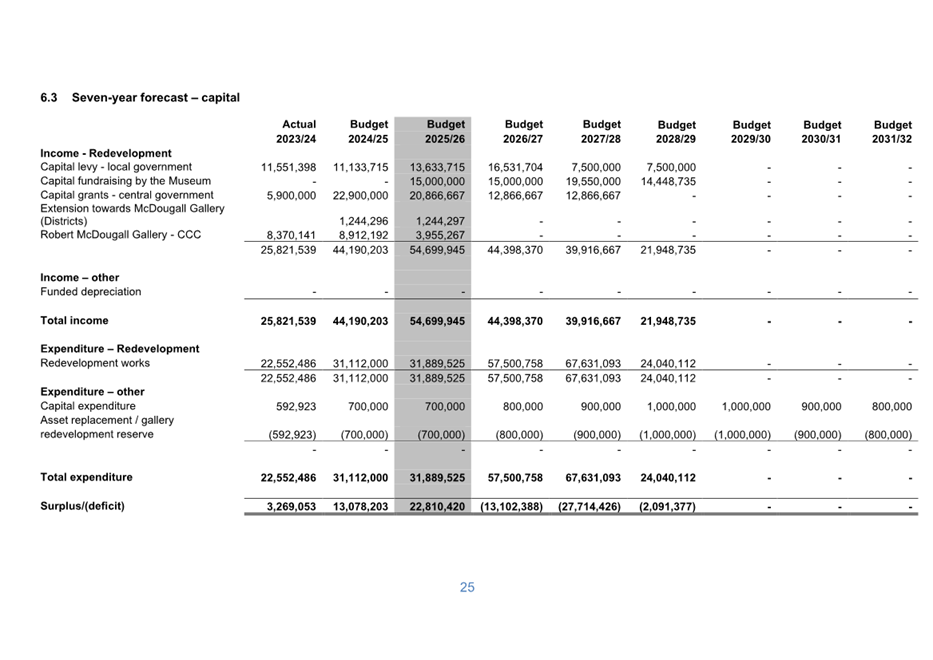

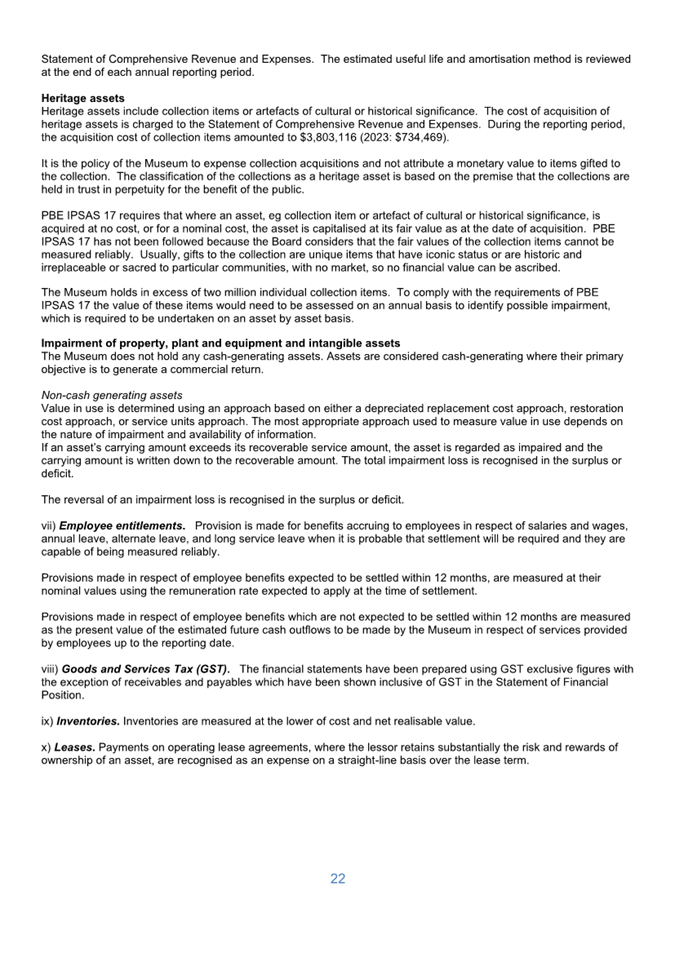

· Capital Levy The Museum is seeking $25 million of additional capital levies from Councils over the next four years: · “We have included the additional Local Government funding over 4 years, from 2025/26, on a 10%,30%,30%,30% basis (being $2,117,372 and $6,352,116 x 3 for Christchurch City Council). Our Project Manager has advised that a commitment to this funding will be required by January 2026 to enable placing the Stage 5 contract, maintaining the target programme and hence avoiding further escalation in project cost, currently estimated to be in the order of $2.4m per annum.”
The following table summarises the proposed funding change for the remaining $86.6 million funding gap.
|
|
Useful Links |
· None.
|
Attachments Ngā Tāpirihanga
|
No. |
Title |
Reference |
Page |
|
a ⇩ |
2025-26 Canterbury Museum Draft Annual Plan |
25/565587 |
9 |
Signatories Ngā Kaiwaitohu
|
Authors |
Peter Langbein - Finance Business Partner John Filsell - Head of Community Support and Partnerships |
|
Approved By |
John Filsell - Head of Community Support and Partnerships |
|
3. Venues Ōtautahi - Draft Statement of Intent 2025/26 |
|
|
Reference Te Tohutoro: |
25/691478 |
|
Presenter(s) Te Kaipāhō : |
Gill Cox, Chair, Caroline Harvie-Teare (CE) and Jamie Mountier (CFO). |
1. Detail Te Whakamahuki
|

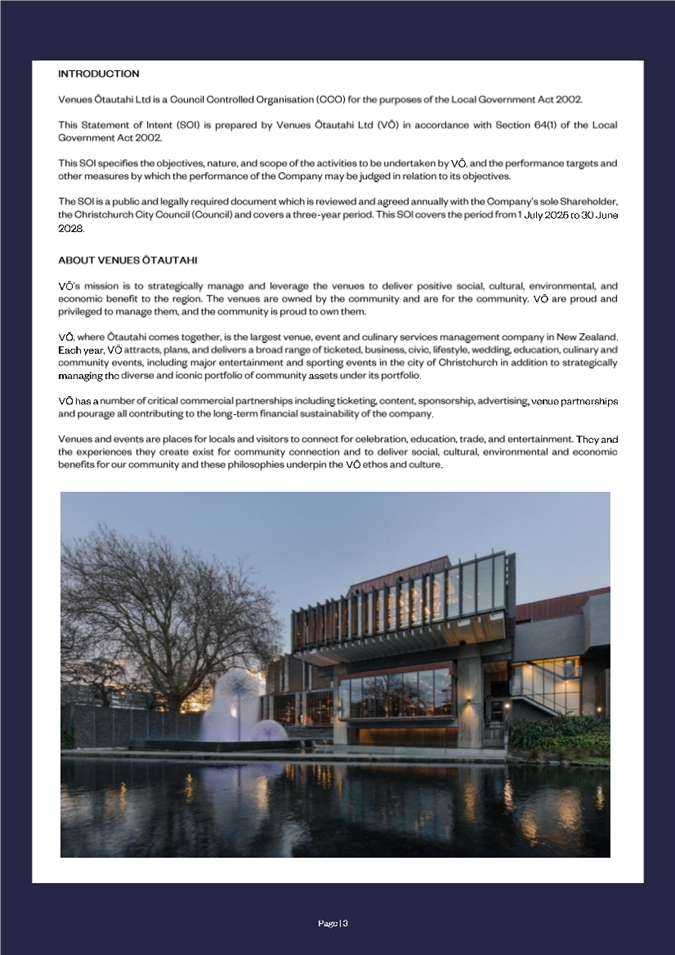

Purpose and Origin |

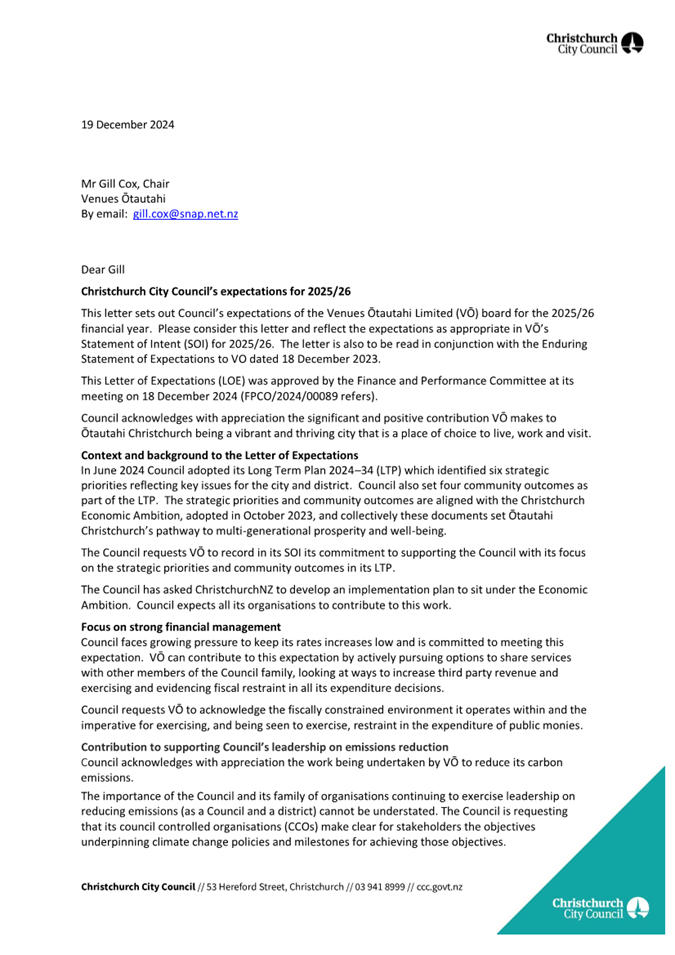

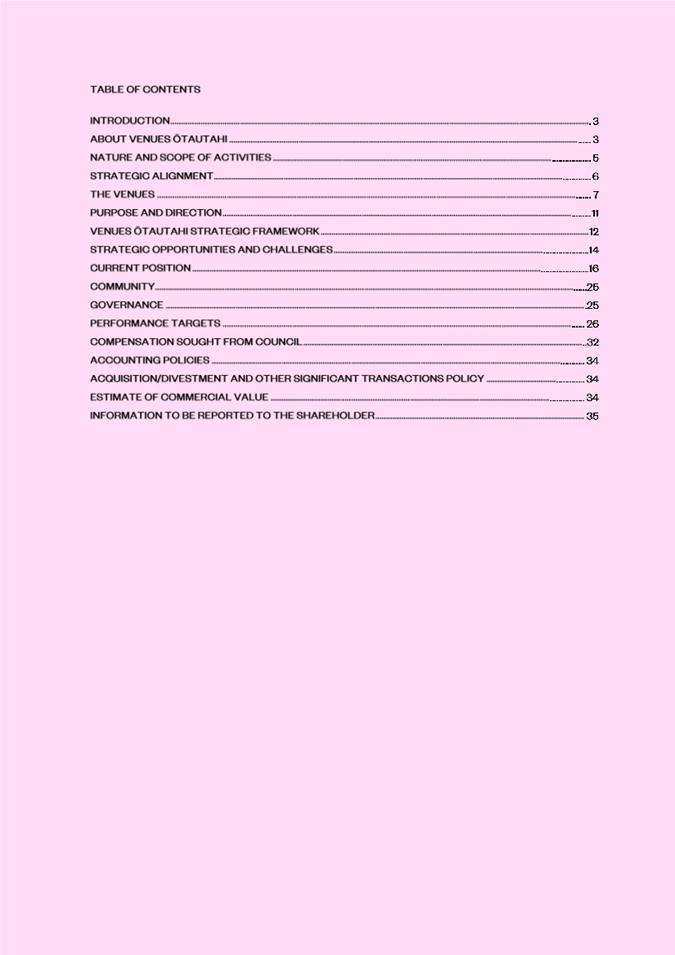

· To provide an overview of Venues Ōtautahi’s (VŌ’s) draft Statement of Intent (SOI) for the three years 2025/26, 2026/27 and 2027/28 (refer Attachment A). The Council’s Letter of Expectations (LOE) dated 19 December 2024 is at Attachment B. |
||||||||||||||||||||||||||||||||||||
|
Timing |
· This workshop is expected to last for 30 minutes. |
||||||||||||||||||||||||||||||||||||
|
Outcome Sought |

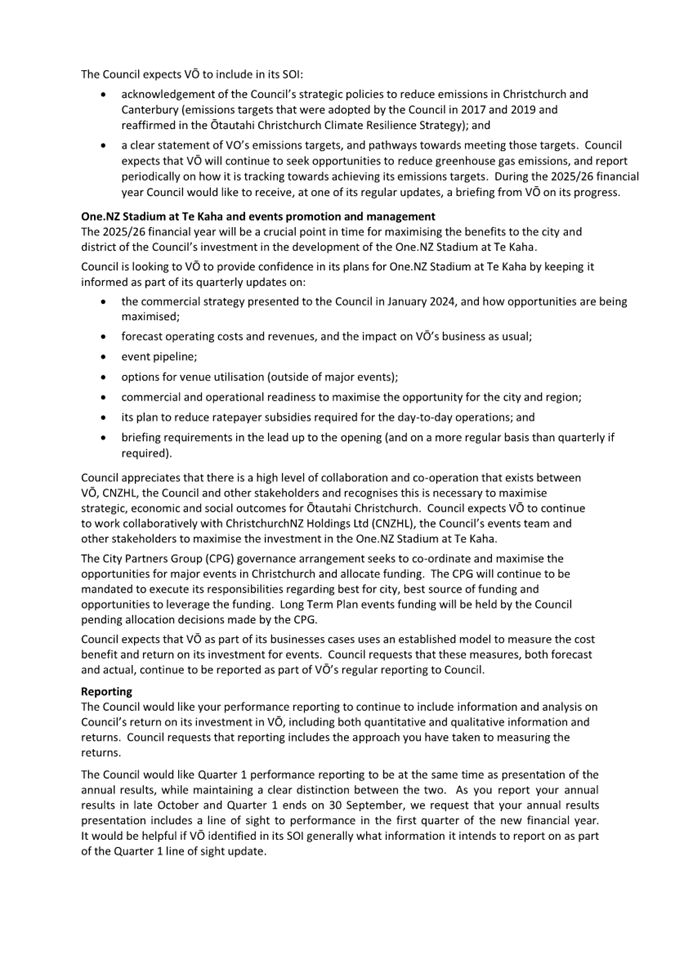

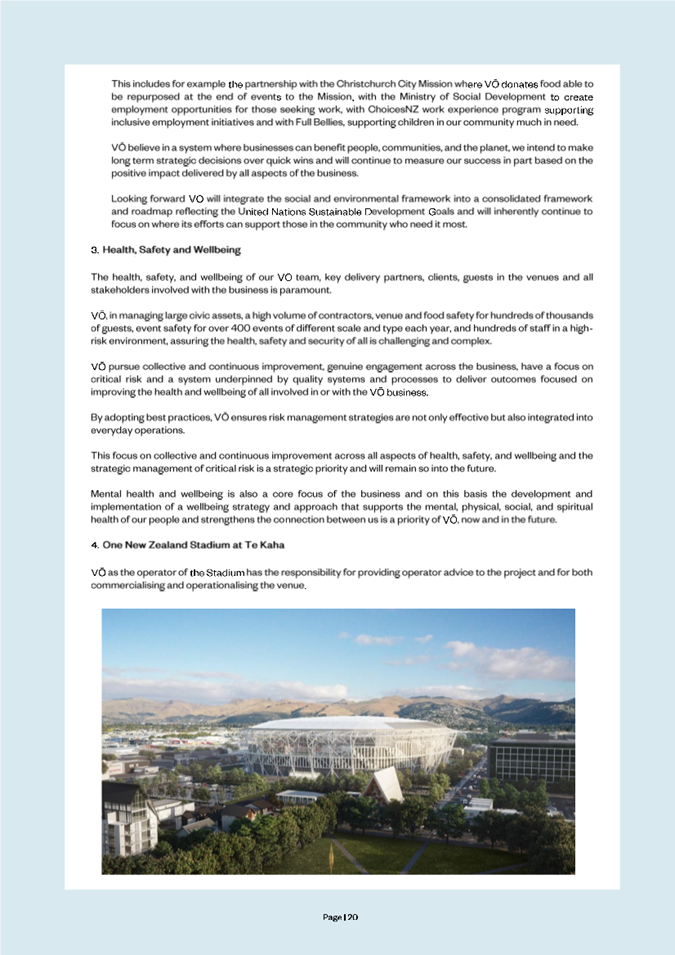

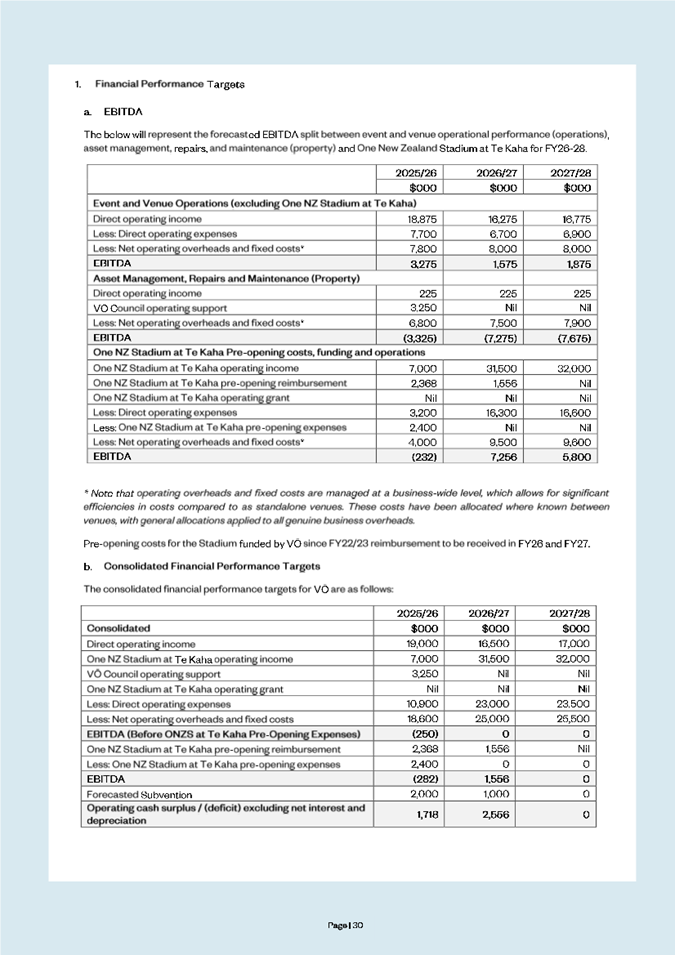

· An understanding of VŌ’s strategic objectives, performance metrics and in particular the projections for the One.NZ Stadium at Te Kaha, noting it is expected to be operating from April 2026. · Clarity that work remains ongoing between Council and VŌ staff to enable reasonable assurance to be provided to the Council that the forecast financial metrics are reasonable. In particular, to ensure that the assumptions underpinning the financial forecasts are robust. |
||||||||||||||||||||||||||||||||||||
|
ELT Consideration |
N/A. |
||||||||||||||||||||||||||||||||||||
|
Next Steps |

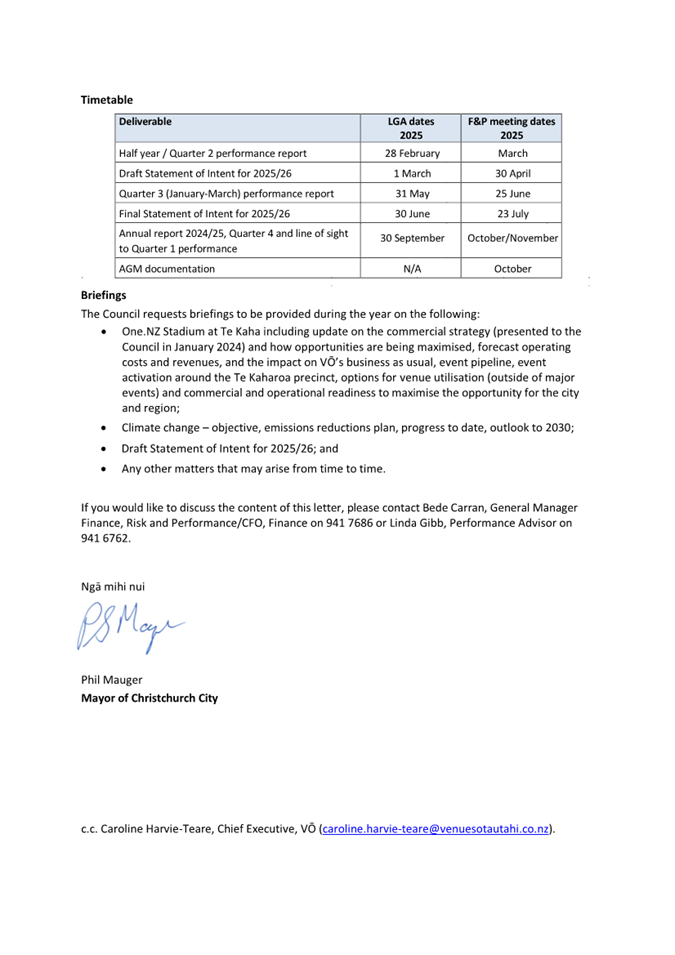

· A staff report with VŌ’s draft SOI will be presented to the Finance and Performance Committee at its meeting on 30 April 2025 with a view to the Council formally commenting on the draft SOI (if it wishes) by 1 May (pursuant to clause 2, part 1 of schedule 8 of the Local Government Act 2002). · Final SOIs are due to be adopted by CCOs by 30 June 2025. · Council staff working with VŌ staff to provide assurance on the reasonableness of the One.NZ Stadium at Te Kaha financial projections (and their impact on the wider VŌ business) for the final SOI. |
||||||||||||||||||||||||||||||||||||
|
Key points / Background |

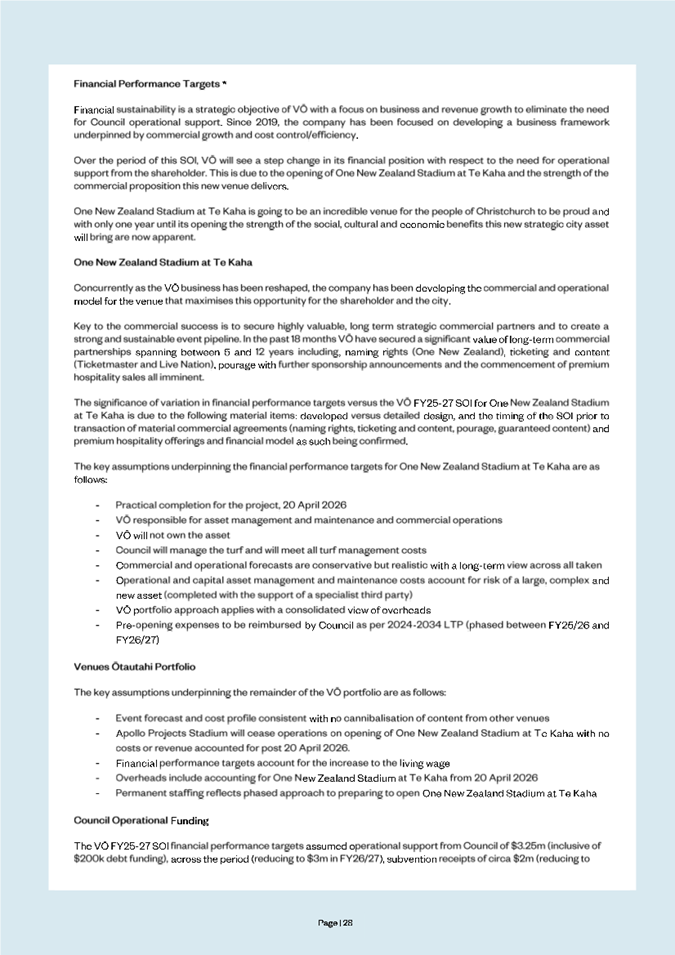

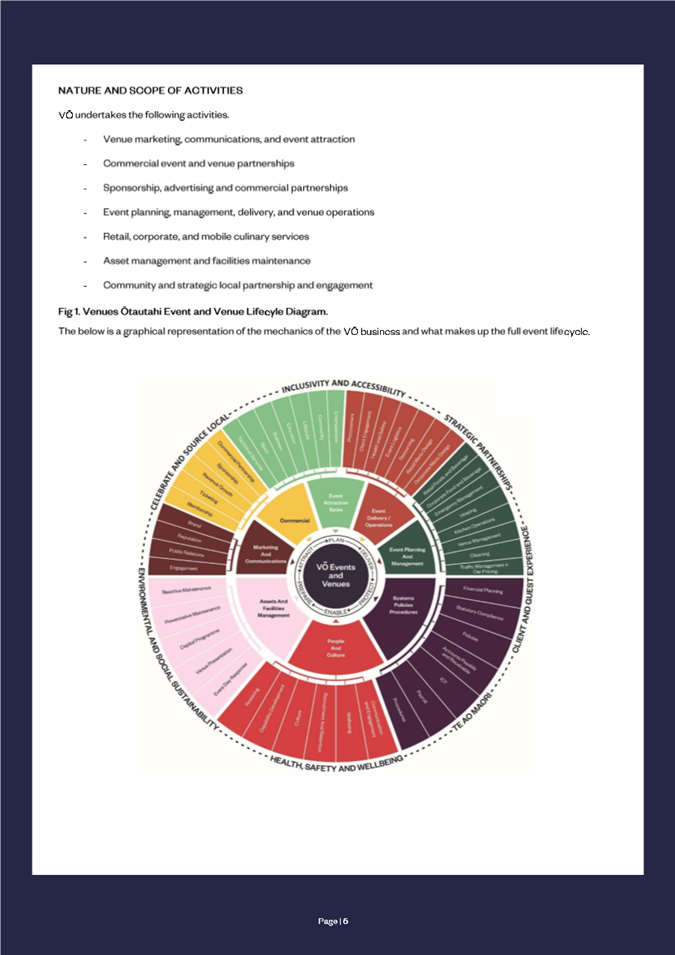

· The draft SOI does not include any potential implications from the section 17A (Local Government Act 2002) review of economic development which is yet to report back. · VŌ’s draft SOI and projected financial metrics include the forecast impact of One.NZ Stadium at Te Kaha opening in April 2026 and operating for a period of around 10 weeks in the 2025/26 year and the contemporaneous removal of the current Apollo Projects Stadium from the portfolio of venues. · The financial performance targets (both including and excluding One.NZ Stadium at Te Kaha contribution) are on page 30 of the draft SOI. VŌ will present its draft financial forecasts at the workshop including advice on material variances with the One.NZ Stadium at Te Kaha business case, forecast upside and risks associated with the forecasts and key issues still being resolved. · The following table shows the operating and capital grants that VŌ is seeking from the Council over the SOI period (including ONZS impacts) compared with the Annual Plan 2025/26 (A/P):

· VŌ advises that bringing One.NZ Stadium at Te Kaha into VŌ’s operations is expected to provide operating efficiencies and improved revenues to VŌ relative to the business case that has reduced the need for Council operating grants of around $3 million in 2026/27 and 2027/28. · Provision is made for VŌ to recover One.NZ Stadium at Te Kaha pre-opening costs of $2.4 million in 2025/26 and $1.6 million in 2026/27 from its operating cashflows, provided for in the Long-Term Plan 2024-34 and the draft A/P 2025/26. · The capital grant is approximately 2% of VŌ’s total asset value (as at 30 June 2024), a significant part of which services the Wolfbrook Arena which is 27 years old and in need of renewal and improvement. · There are other financial implications for the SOI period which require testing prior to being confirmed in the final SOI. These include bid incentive funding through the City Partners Group (indicated in the draft SOI as not being required from 2025/26) and reduction of subvention receipts from 2026/27. · The forward events’ profile projected by VŌ is shown below:

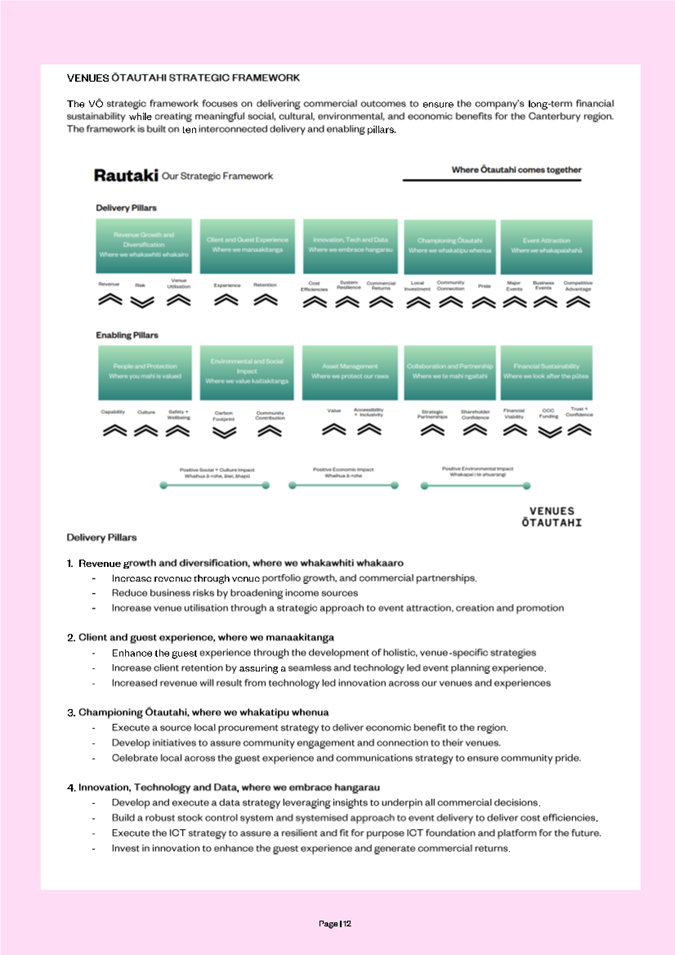

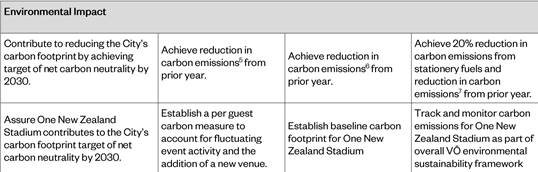

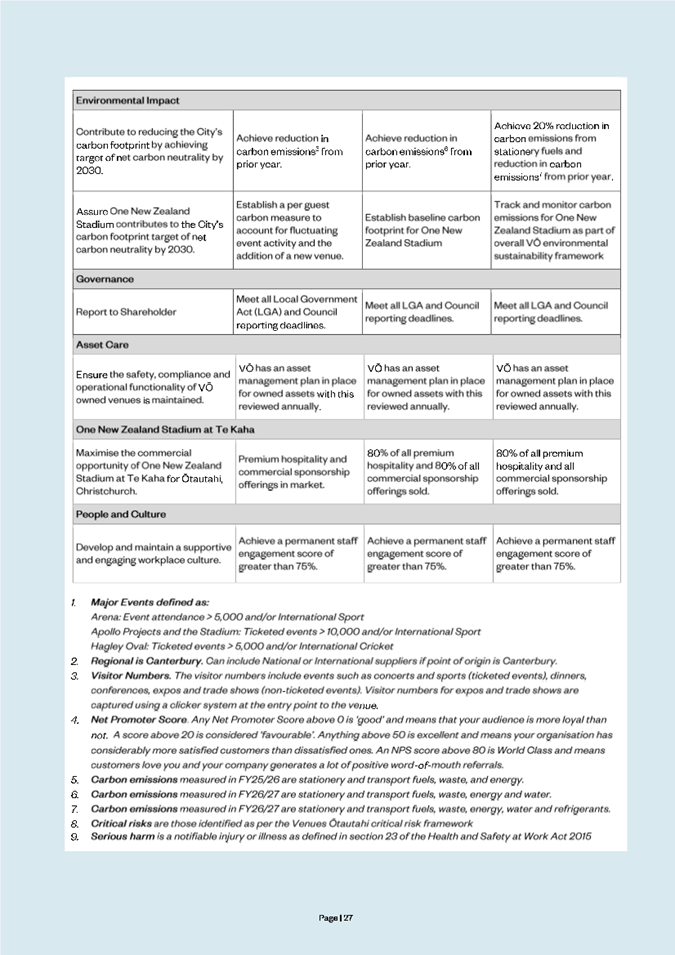

Climate change · VŌ’s climate change commitments have been reviewed by the Council’s Climate Resilience team, which has commented that VŌ’s draft SOI provides a clear emissions target to “achieve carbon neutrality for all VŌ venues by 2030”. The draft SOI includes VŌ’s carbon reduction roadmap developed in 2023 which identifies VŌ‘s major emissions sources with explicit reduction targets for each.
|
||||||||||||||||||||||||||||||||||||
|
Useful Links |
N/A. |
Attachments Ngā Tāpirihanga
|
No. |
Title |
Reference |
Page |
|
a ⇩ |
Venues Ōtautahi - Draft Statement of Intent 2025/26 |
25/509771 |
38 |
|
b ⇩ |
Vemues Ōtautahi - Letter of Expectations 2025/26 |
24/2332302 |
74 |
Signatories Ngā Kaiwaitohu
|
Author |
Linda Gibb - Performance Monitoring Advisor CCO |
|
Approved By |
Russell Holden - Head of Finance Bede Carran - General Manager Finance, Risk & Performance / Chief Financial Officer |
The information session/workshop items noted from the next page will not be open to the public under the sections of the Local Government Official Information and Meetings Act 1987 (LGOIMA) outlined in the table on the following page. The full wording of the noted LGOIMA sections is found in section 6 or section 7 of the Act.
In the Council's view, these reasons for exclusion are not outweighed by public interest considerations in section 7(1) favouring their release.
The public can ask the Ombudsman to review this decision. Information about how to make a complaint is available at www.ombudsman.parliament.nz or freephone 0800 802 602.
|
GENERAL SUBJECT OF EACH MATTER TO BE CONSIDERED |
SECTION |
SUBCLAUSE AND REASON UNDER THE ACT |
PUBLIC INTEREST CONSIDERATION |
Potential Release Review Date and Conditions |
|
|
5. |
Christchurch City Holdings Ltd - Draft Statement of Intent 2025/26 |
s7(2)(b)(ii), s7(2)(h) |
Prejudice Commercial Position, Commercial Activities |
Information to be discussed includes commercially sensitive information that could, if released, publicly adversely impact the CCHL group's profitability. |
5 May 2025 After the CCHL group's draft SOIs have been reviewed by the Finance and Performance Committee at its meeting on 30 April 2025. |
|
6. |
International Relations Update |
s7(2)(b)(ii) |
Prejudice Commercial Position |
Disclosure could jeOPARDISE Christchurch's FUTURE INTERNATIONAL RELATIONS opPortunitIES. |
27 March 2026 Report may be released with appropriate redactions. |
