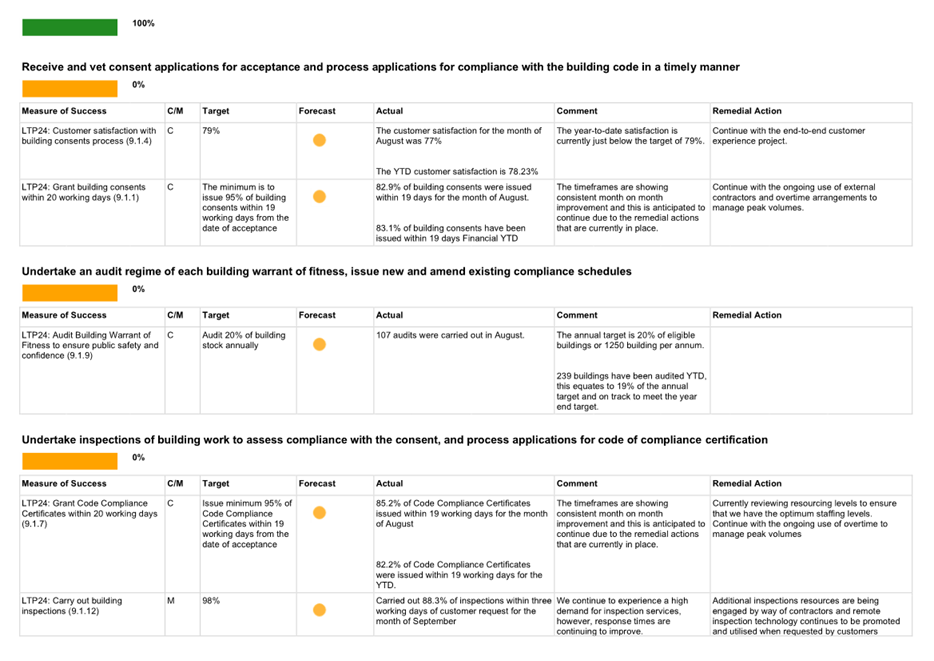

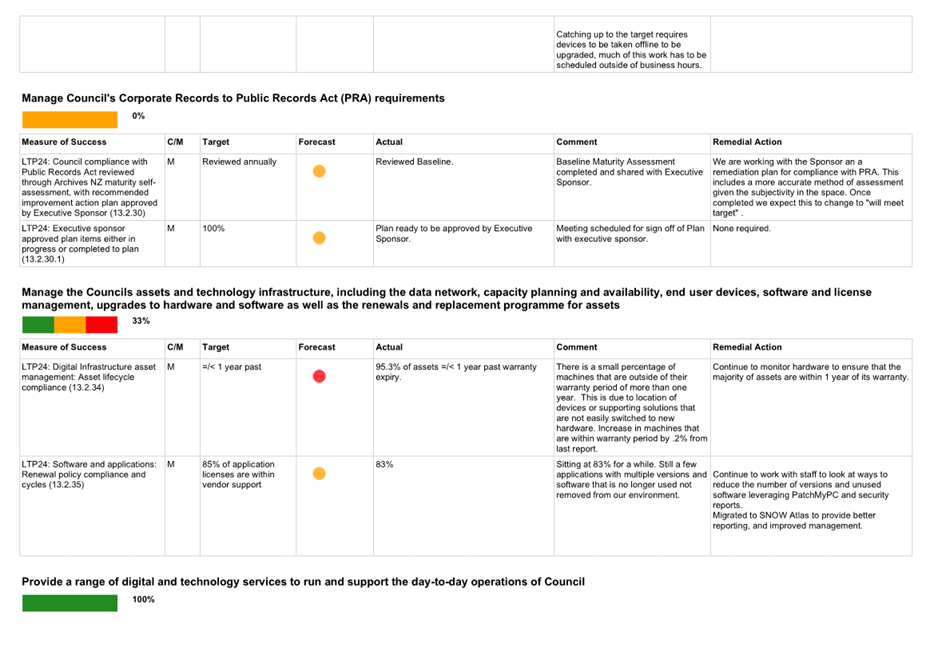

1. Purpose and Origin of the Report Te Pūtake Pūrongo
1.1 To provide Council with an overview of performance towards delivering year one of our Long-term Plan 2024-34 (LTP), our contract with the community.
2. Officer Recommendations Ngā Tūtohu
That the Finance and Performance Committee:
1. Receives the information in the Key Organisational Performance Results - August 2024 Report.
3. Background/Context Te Horopaki
3.1 This is a regular report focused on a suite of the ‘vital few’ organisational performance targets and forms a key component of the Performance Framework and its reporting.

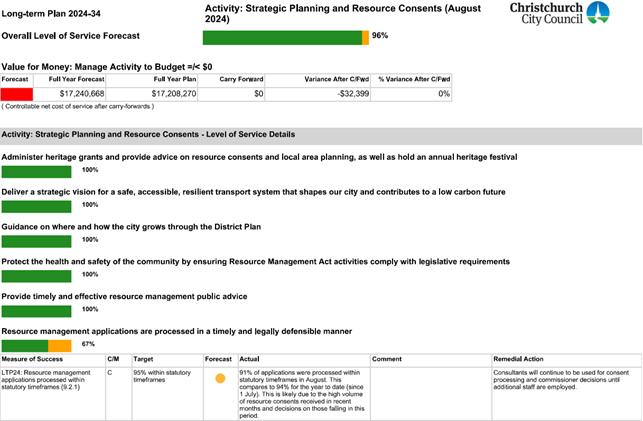

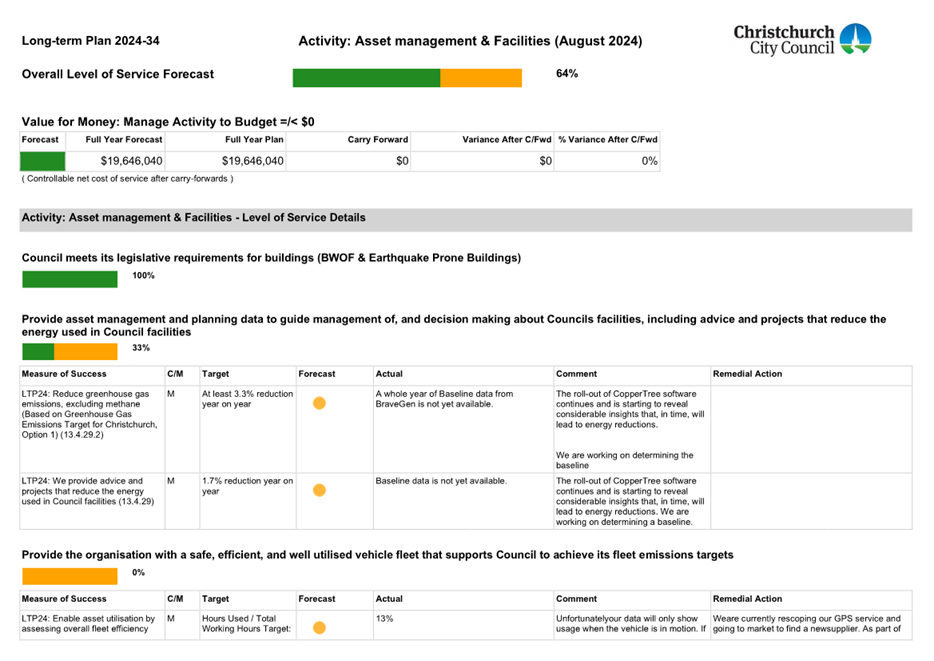

3.2 Levels of service (LOS) are now presented in consolidated format, which means that exceptions are put in perspective against those performance measures that are on track. This report, as well as all supporting activity reports, have been extensively reworked to achieve this.
4. Considerations Ngā Whai Whakaaro

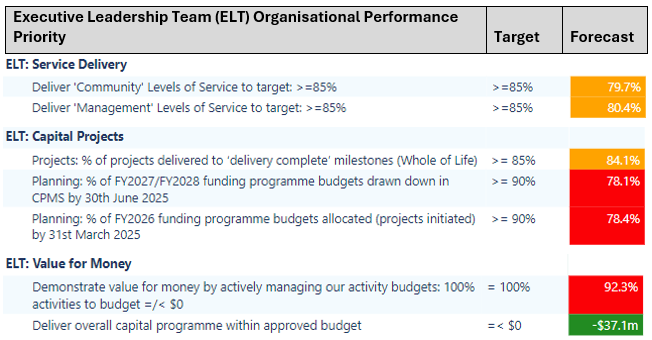

4.1 The key organisational performance targets include:
· Service Delivery (levels of service)
· Capital Projects (both delivery and planning)
· Value for Money (finance – activity budgets and capex)
4.2 Throughout 2023 and the first half of 2024 the LTP 2024-34 was developed. The draft LTP was adopted on 11 March 2024. Following consultation, and hearing and considering the submissions Council adopted the final LTP 2024-34 on 27 June 2024.
4.3 Following adoption council systems were updated with the approved content to enable reporting against the adopted LTP.
4.4 In early August, the Executive Leadership Team outlined their, “priorities and focus areas for the 2024/25 year. Our foremost priority is to fulfil the promises outlined in our Long-Term Plan. This plan is our contract with the community, detailing the services we will provide and the projects we will deliver. It sets clear expectations for service levels.” ELTs Organisational Performance Priorities and targets provide the basis for performance reporting ELT and Finance & Performance Committee.

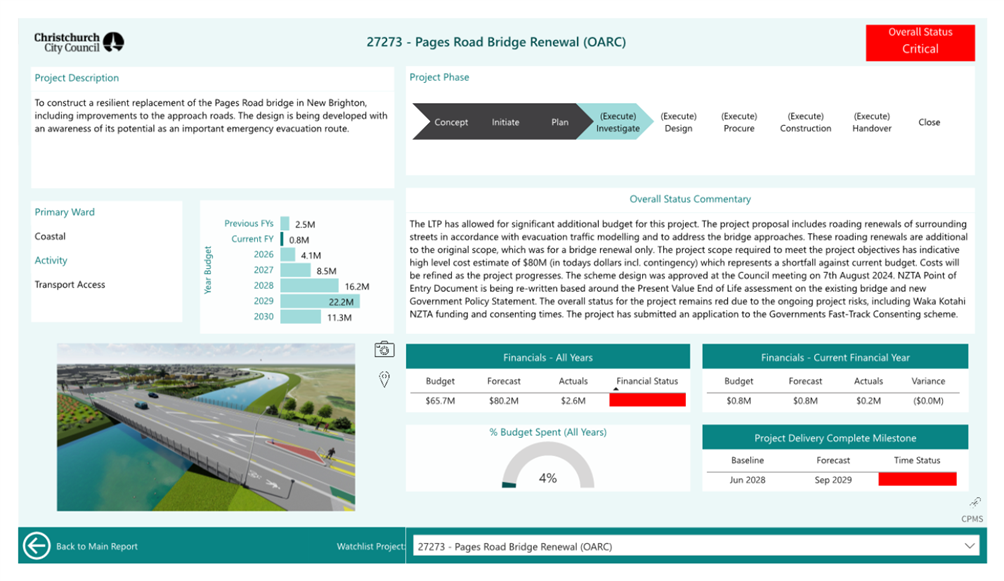

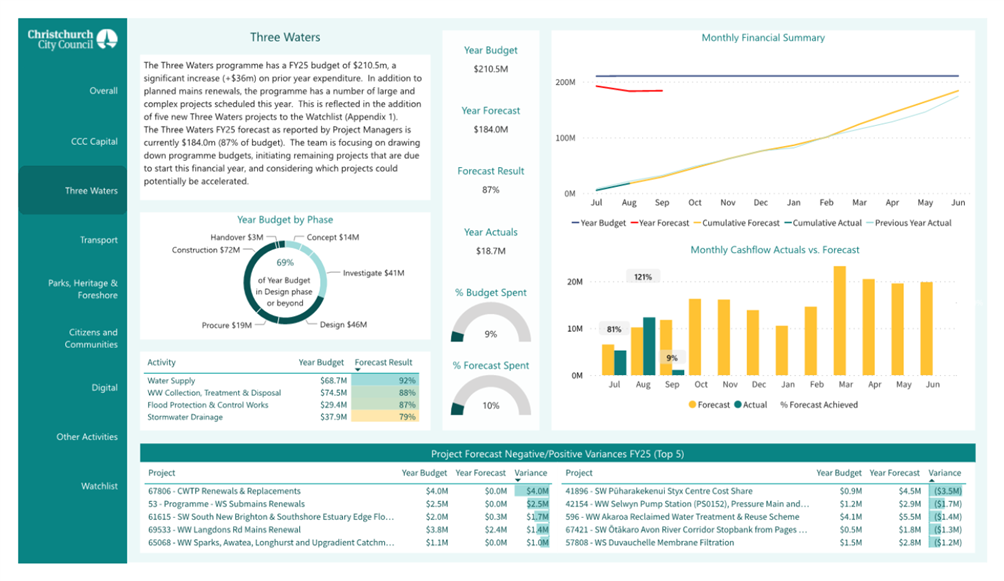

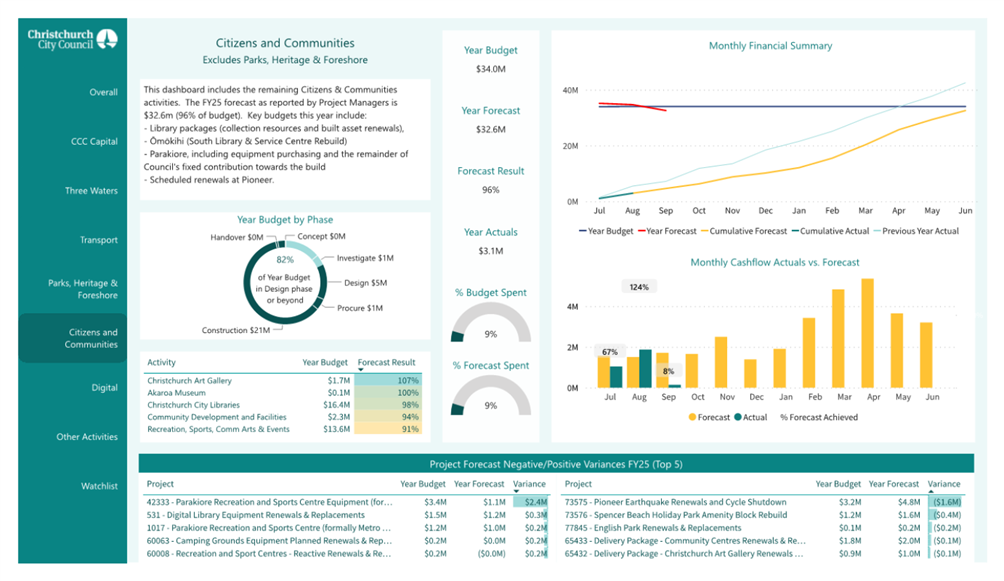

4.5 Over the last month work has been undertaken to re-orientate performance reporting systems and processes to meet ELT priorities.
4.6 This report provides the first monthly performance forecasts to ELT for the LTP 2024-34.
4.7 Overall organisational performance priority forecasts are mixed.
4.8 Community level of service delivery (79.7%) (LOS) performance forecasts start the year conservatively, below the ELT performance target (85%) and forecasting below the YE pre-audit result for 2023/24 (82.2%).
4.9 Management LOS delivery (80.4%) also begins the year conservatively, below the ELT performance target (85%) and forecasting below the YE pre-audit result for 2023/24 (84.8%). Through implementation of recommended management actions, it is most likely both LOS forecasts will see good improvement in September (next month) reporting.
4.10 Capital project milestone delivery performance is forecasting 84.1% against the updated ELT target of 85%. This target now reports both key and non-key projects combined, which ended the previous year achieving 88% and 86% respectively.
4.11 Capital planning performance forecasts both show good progress for this time of year, against the revised ELT targets of 90%.
· Funding programme budgets allocated for FY2026 by 31st March 2025 reported at 78.4%.
· Budget drawdowns for FY2027 and 2028 by 30th June 2025 is reported at 78.1%.
4.12 Activity budgets, actively managed to budget = / < $0, the first forecasts report that 92.3% of activities are being managed to budget, against the new ELT target of 100%.
4.13 Deliver Capital Programme within approved budget is forecast to meet target, -$37.1m against the new ELT target of = / < $0. This is forecast to meet target.

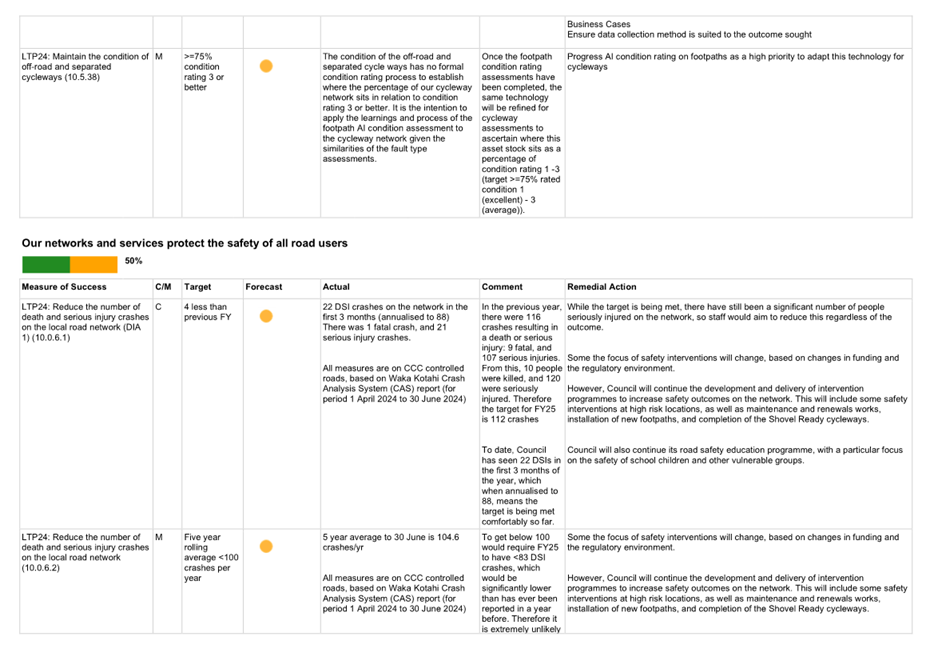

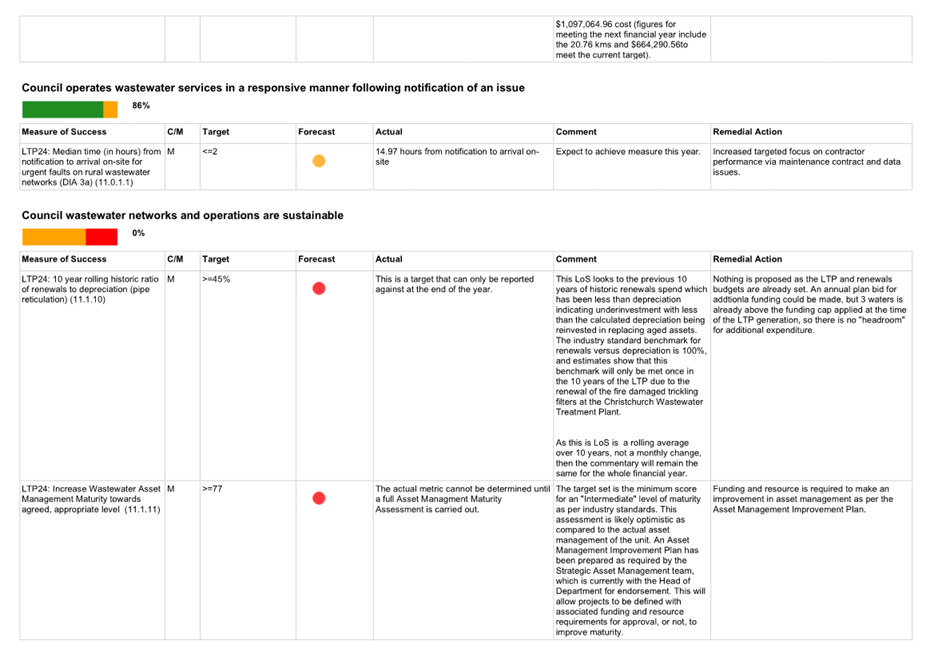

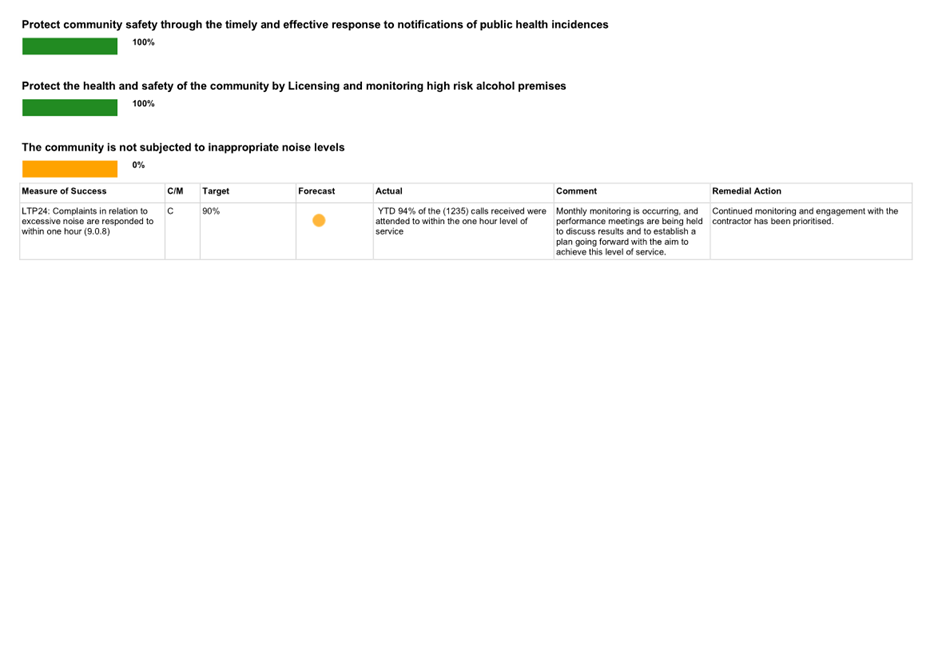

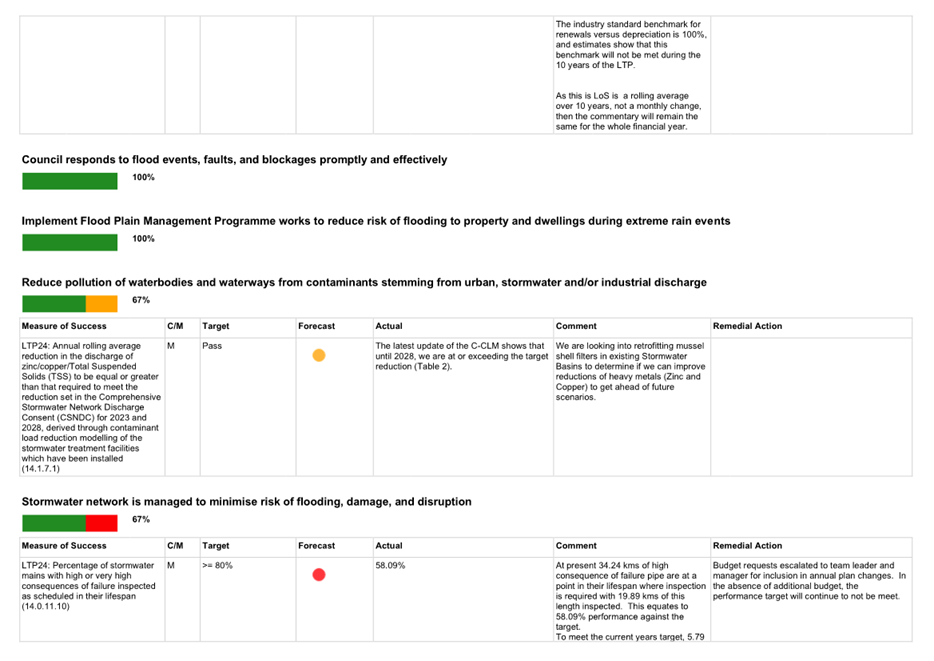

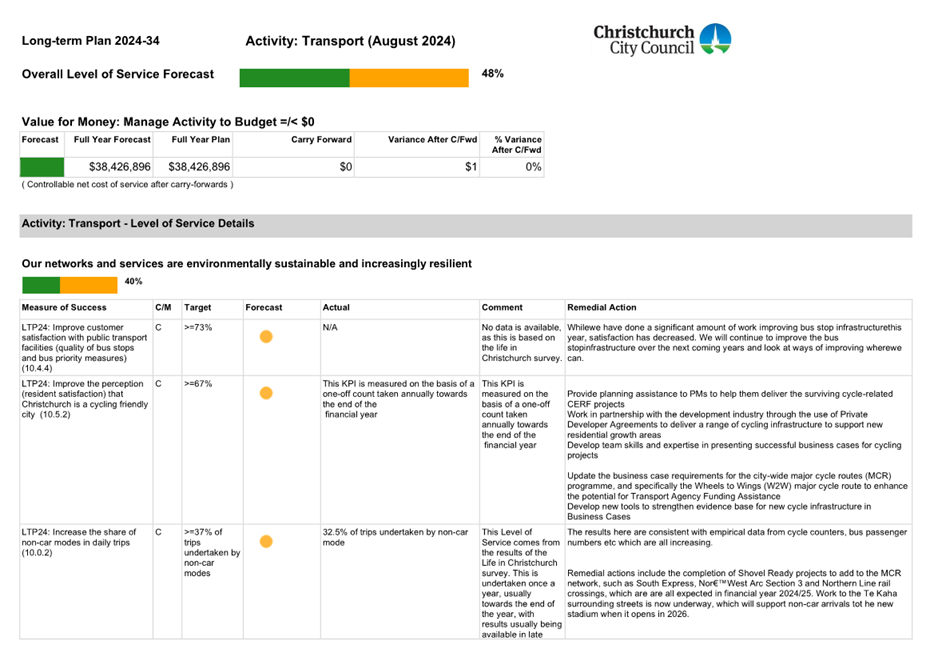

5. Service Delivery

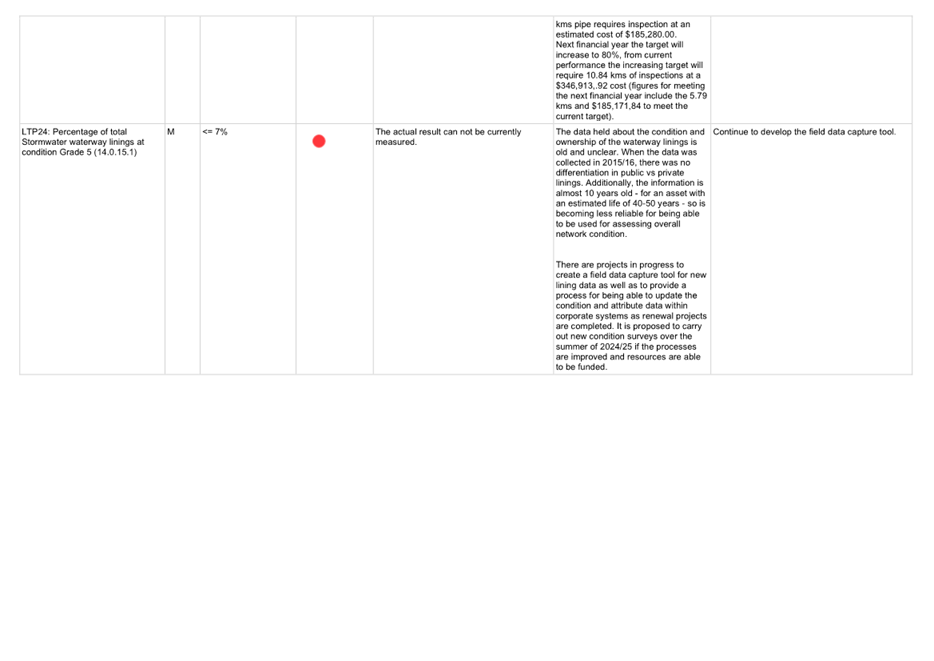

5.1 Community level of service delivery (79.7%) (LOS) performance forecasts start the year conservatively, below the ELT performance target (85%) and forecasting below the YE pre-audit result for 2023/24 (82.2%). In line with the standing Audit and Risk Management Committee (ARMC) request all LOS that did not meet the previous year will continue to be reported as an amber exception until evidence is provided that the target will or has been met. With implementation of recommended management actions, it is anticipated this forecast will see improvement in the September (next month) reporting.

5.2 Management LOS delivery (80.4%) also begins the year conservatively, below the ELT performance target (85%) and forecasting below the YE pre-audit result for 2023/24 (84.8%).

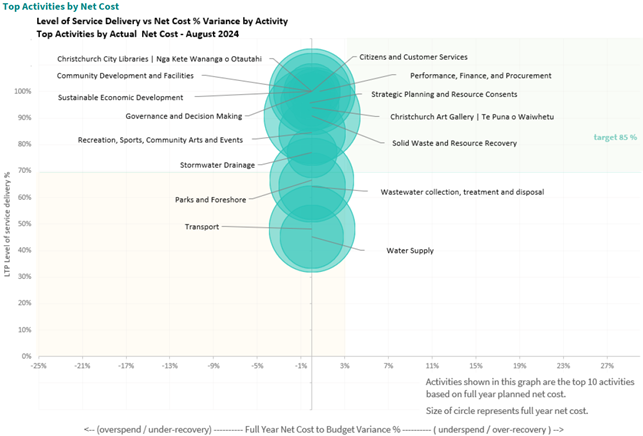

5.3 The scatter-diagram below (Attachment A) shows activity LOS delivery performance (Community and Management LOS), against activity budget performance (over- or under-spend).

· Activities variously report level of service delivery forecasts ranging from 45% to 100% achievement, while almost all activities are presently forecast on budget.

· The vertical y-axis shows forecast service delivery (LOS) performance.
· The horizontal x-axis shows forecast budget over/underspend (scaled to relative budget).
5.4 An updated view of LOS exceptions is attached to this report (Attachment B) - example:
· visual summary of activity overall service delivery and activity budget performance,
· underpinned by a more granular LOS summary across the activity, before
· listing specific exceptions detail and commentary.

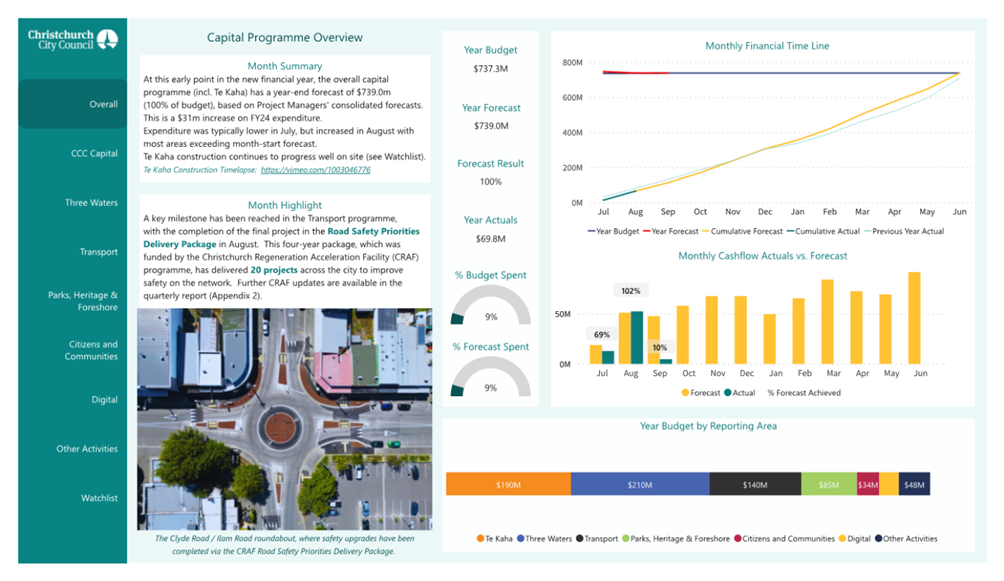

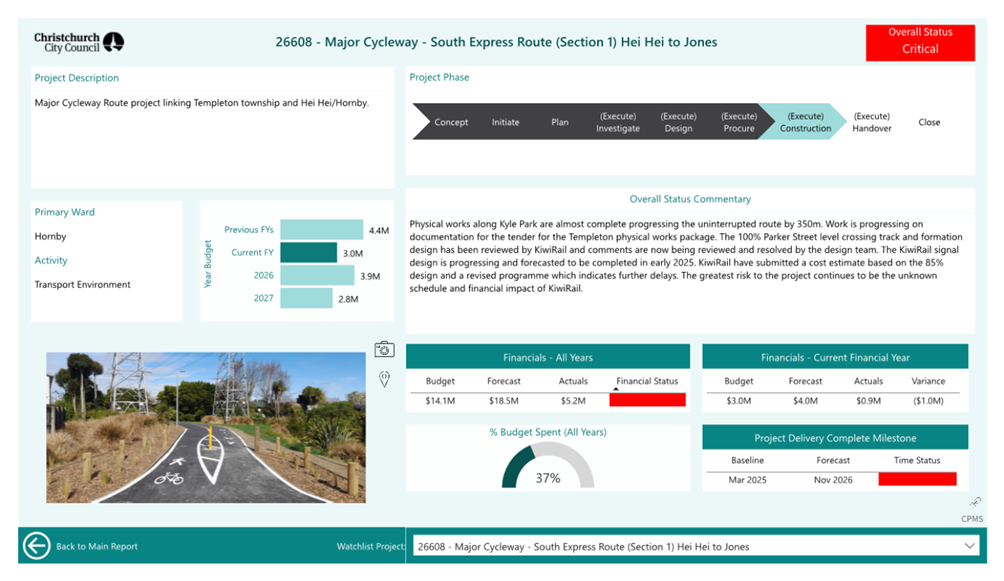

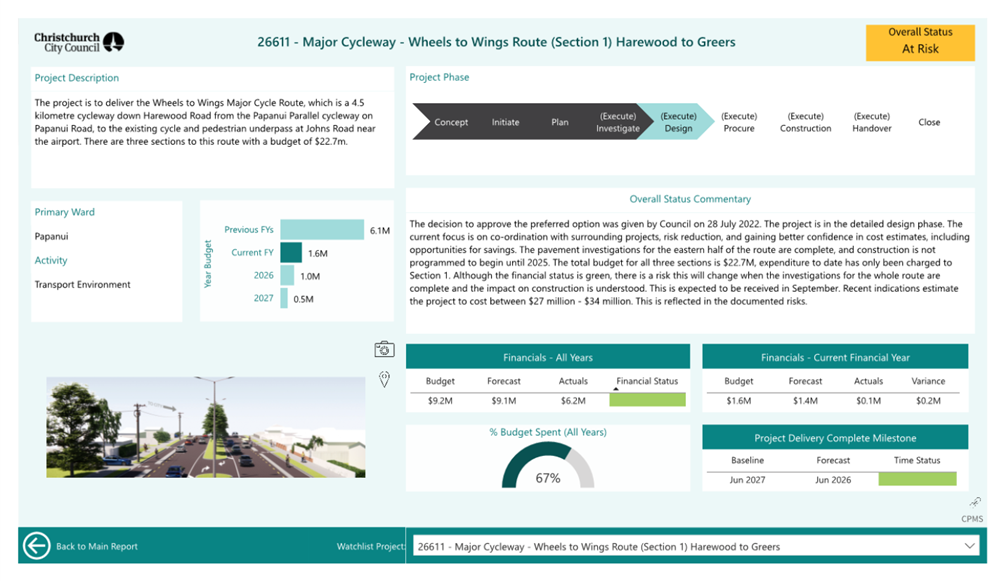

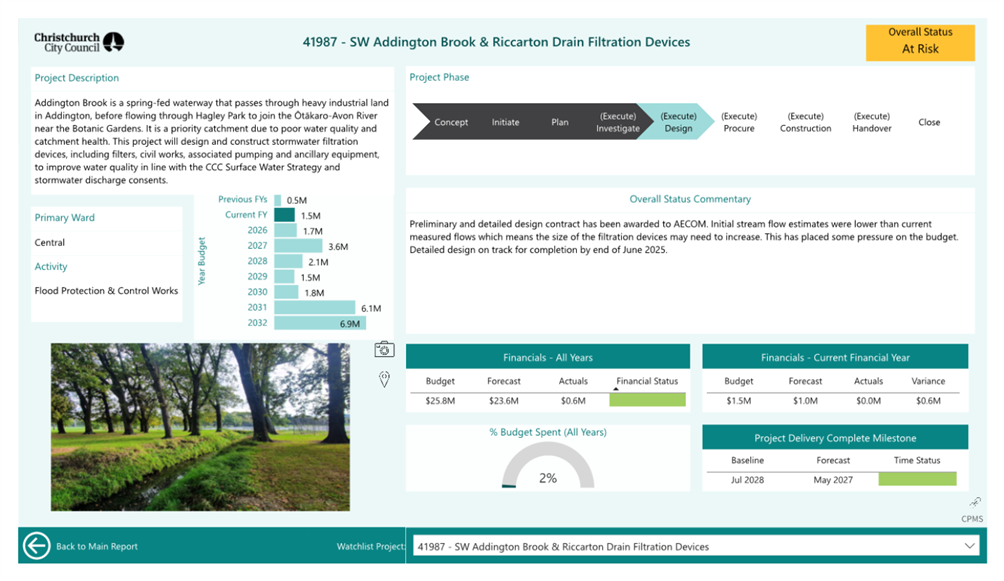

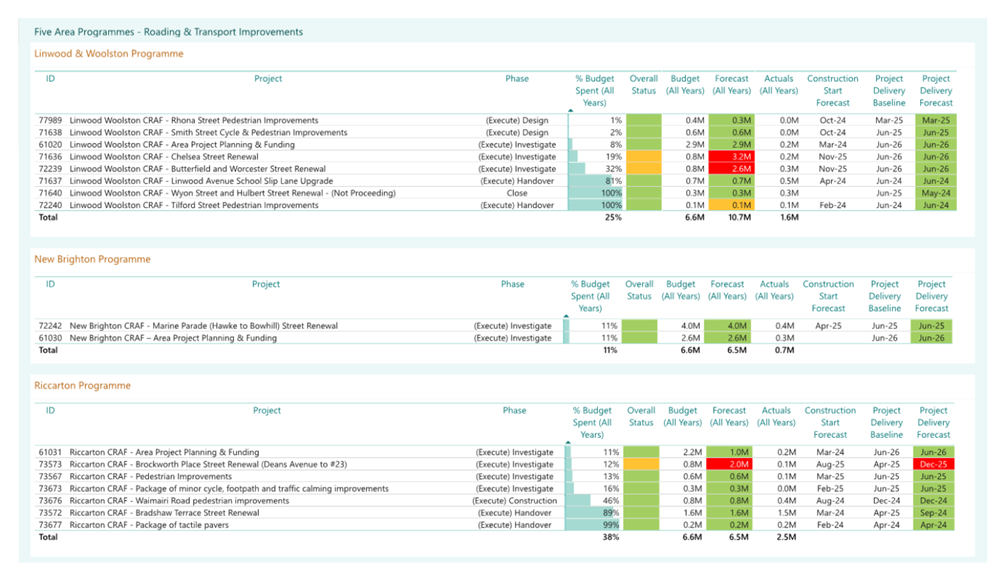

6. Capital Projects – Delivery and Planning

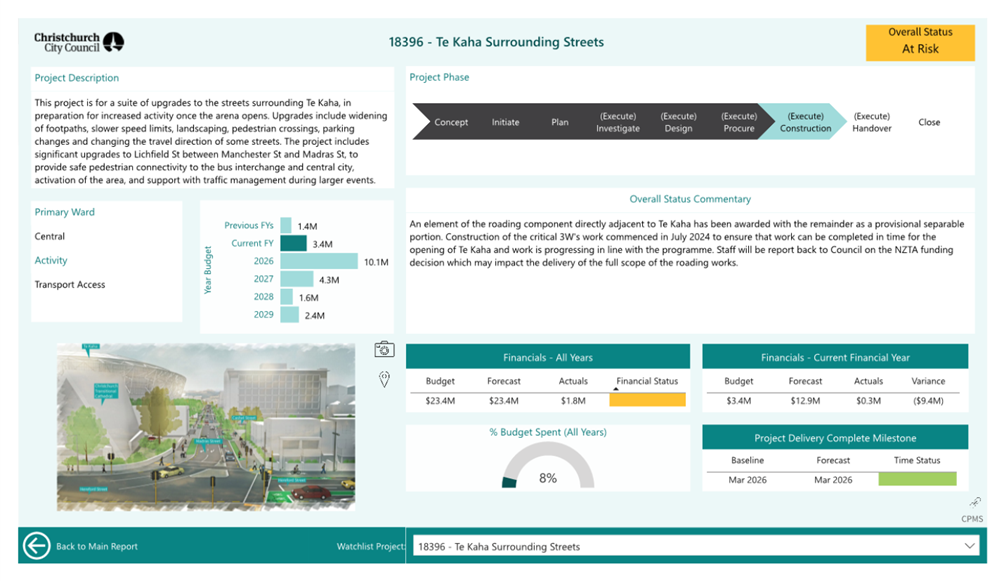

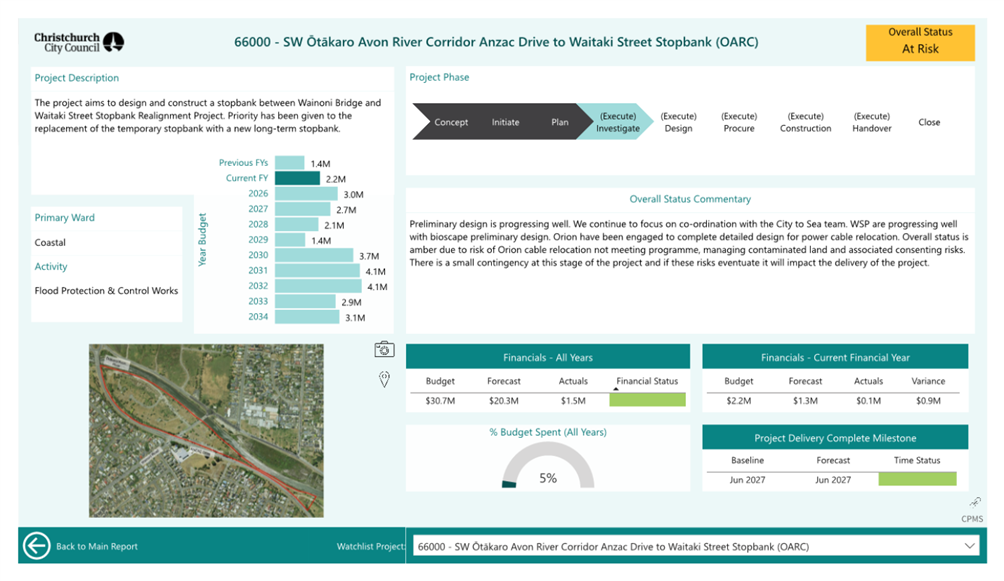

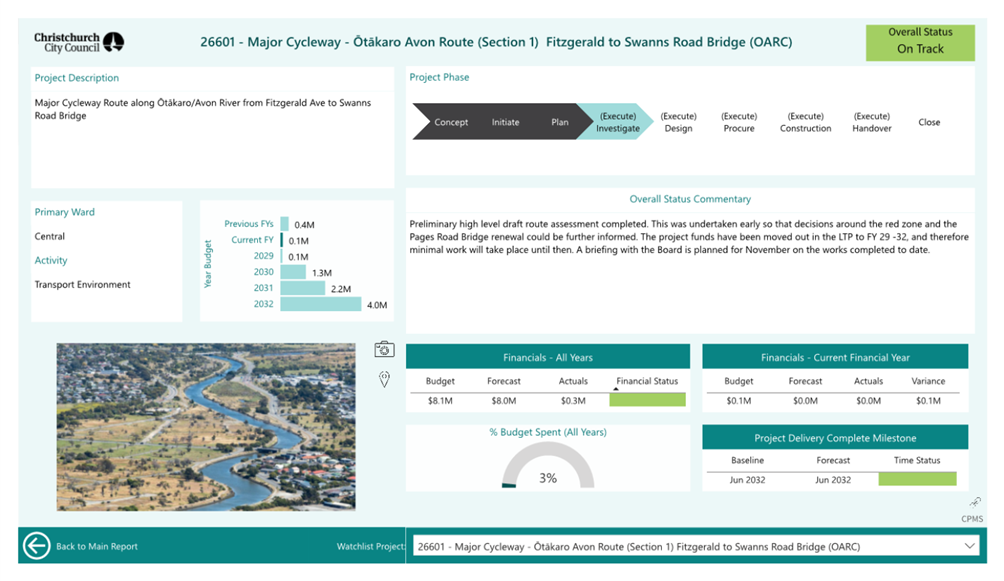

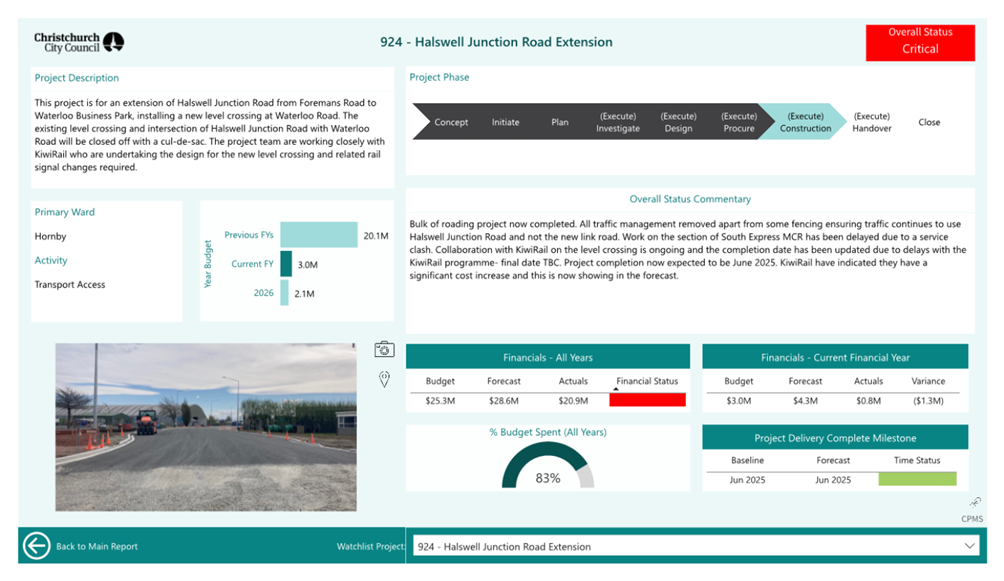

6.1 Capital project milestone delivery performance is forecasting 84.1% against the updated ELT target of 85%. This target now reports both key and non-key projects combined, which ended the previous year achieving 88% and 86% respectively.
6.2 The capital delivery target relates to projects Council is responsible for delivering, including Council-funded and externally funded projects.
6.3 Capital planning performance forecasts both show good progress for this time of year, against the revised ELT targets of 90%.

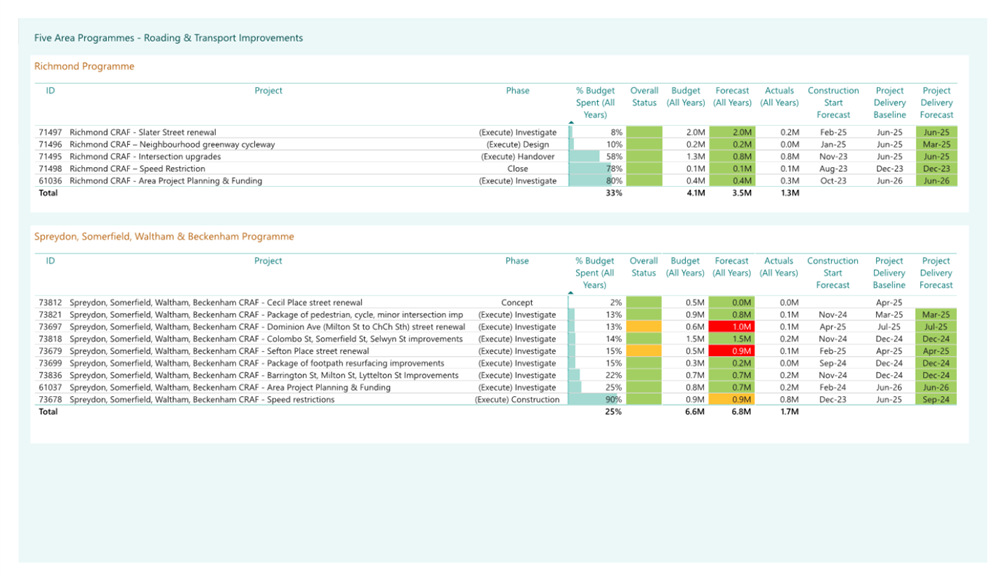

· Funding programme budgets allocated for FY2026 by 31st March 2025 reported at 78.4%.

· Budget drawdowns for FY2027 and 2028 by 30th June 2025 is reported at 78.1%.
6.4 For further information and underlying project detail, refer to the Capital Programme Performance Report.
7. Value for Money
7.1 92.3% of activities are forecast to meet budget (nett controllable cost, after carry-forwards), against the ELT target 100%. To align with changes to the performance target definition, management processes and systems are being refined to enable inclusion of relevant activity manager financial comments.
7.2 For more information refer to Attachment B (LOS Exceptions) and to the Financial Performance Report.
7.3 Overall capital programme budget expenditure is forecast at -$37.1m, against ELT’s target of within approved budget (= < $0). This is the first forecast for the new performance priority target and applies a PMO forecast of $510m against the current programme of $547.1m, approx. -7%. The forecast includes core and externally funded work but excludes Te Kaha.
7.4 More detailed information is available in the Capital Programme Performance Report.
7.5 The forward view of capital delivery performance (financial) looks at commitments for the first three years of the LTP 2024-34, accompanied by confirmed capital delivery in preceding LTP-cycles against plan.
7.6 This view takes into account revised year-end budget delivery figures for 2023/24, and the adopted capital programme from the LTP 2024-34 (approved future years planned expenditure for 2024/25, 2025/26 and 2026/27).
7.7 The extended black line is the full planned delivery budget including Te Kaha.

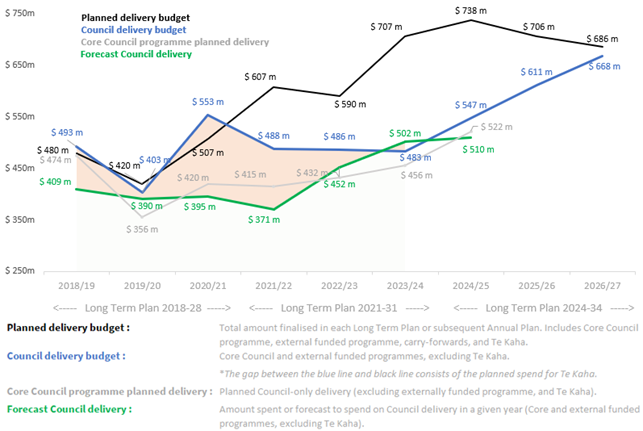

7.8 The extended blue line shows the full Council planned delivery budget (excluding Te Kaha, and before any confirmed carry-forwards) - a considerable lift in Council planned delivery:
· from a consistent $488m to $483m planned budget for the three years (2021-24);
· to between $547m to $668m planned budget for the future three years (2024-27).
7.9 It is accepted these future planned delivery budgets for capital meet Council’s expectations as being both deliverable and affordable.
7.11 This forecast delivery value is in line with the year-end actual value for 2023/24, $502m.
7.12 The ELT performance goal for capital delivery is based on all delivery CCC is accountable for (excluding Te Kaha), regardless of funding source.
7.13 Figures align with the Financial and Capital Programme Performance reports.
Attachments Ngā Tāpirihanga
No. |
Title |
Reference |
Page |
a ⇩ |

Top Activities (service delivery and budget) |
24/1600590 |
22 |
b ⇩ |
Service delivery (level of service) exceptions |
24/1600591 |
24 |
In addition to the attached documents, the following background information is available:
Document Name – Location / File Link |
Not applicable
|
Signatories Ngā Kaiwaitohu
Authors |
Boyd Kedzlie - Senior Corporate Planning & Performance Analyst Amber Tait - Performance Analyst |
Approved By |
Peter Ryan - Head of Corporate Planning & Performance Bede Carran - General Manager Finance, Risk & Performance / Chief Financial Officer |
Reference Te Tohutoro: |
24/1363832 |
Responsible Officer(s) Te Pou Matua: |
Russell Holden, Head of Finance |
Accountable ELT Member Pouwhakarae: |
Bede Carran, General Manager Finance, Risk & Performance / Chief Financial Officer |
1. Purpose and Origin of the Report Te Pūtake Pūrongo
1.1 The purpose of this report is for the Finance and Performance Committee to be updated on Council's financial performance to 31 August 2024 including the current year forecast, and to receive current treasury compliance information.
1.2 This is a regular monthly report that is presented to the Committee.
2. Officer Recommendations Ngā Tūtohu
That the Finance and Performance Committee:
1. Receives the information in the Financial Performance Report - August 2024 Report.
3. Executive Summary
3.1 The year-to-date operational surplus of $17.2m is $11.4m higher than budget year to date. This is primarily due to savings in insurance costs and lower personnel costs due to staff vacancies and timing of any collective salary increase. A surplus of $9.3 million is forecast this year primarily due to savings in insurance costs.
3.2 The total capital programme, before signalled carry forwards, is forecast to be under spent by $39.1 million. This comprises a forecast under spend of $37.3 million on the core/external funded programme and a forecast under spend of $1.8 million on Te Kaha.
3.3 All treasury risk positions are within policy limits.
4. Operating Forecast
4.1 The $9.3 million forecast year end surplus is largely driven by savings in insurance costs following direct staff negotiations with insurance brokers and a higher rates strike, driven by a higher final number/valuation of rating units.
5. Operational Revenue and Expenditure
5.1 This covers day to day spend on staffing, operations and maintenance, and revenues to fund the operational spend.
5.2 Operational revenue exceeds expenditure as it includes rates revenue for capital renewals and debt repayment. This ‘capital’ revenue is referred to below as ‘Funds not available for Opex’ and is removed to show the year to date and forecast operational surplus or deficit.
Year to Date Results |
Forecast Year End Results |
After Carry Forwards |
|||||||||
$m |
Actual |
Budget |
Var |
|
Forecast |
Budget |
Var |
|
Carry Fwd |
Var |
|
Revenues |
(234.6) |
(233.1) |
1.5 |
|
(1,079.8) |
(1.078.6) |
1.3 |
|
- |
1.3 |
|
Expenditure |
147.8 |
166.9 |
19.1 |
|
819.1 |
827.2 |
8.0 |
|
- |
8.0 |
|
Funds not available for Opex |
69.6 |
60.4 |
(9.2) |
|
251.4 |
251.4 |
- |
|
- |
- |
|
Operating (Surplus)/Deficit |
(17.2) |
(5.8) |
11.4 |
|
(9.3) |
- |
9.3 |
|
- |
9.3 |
|

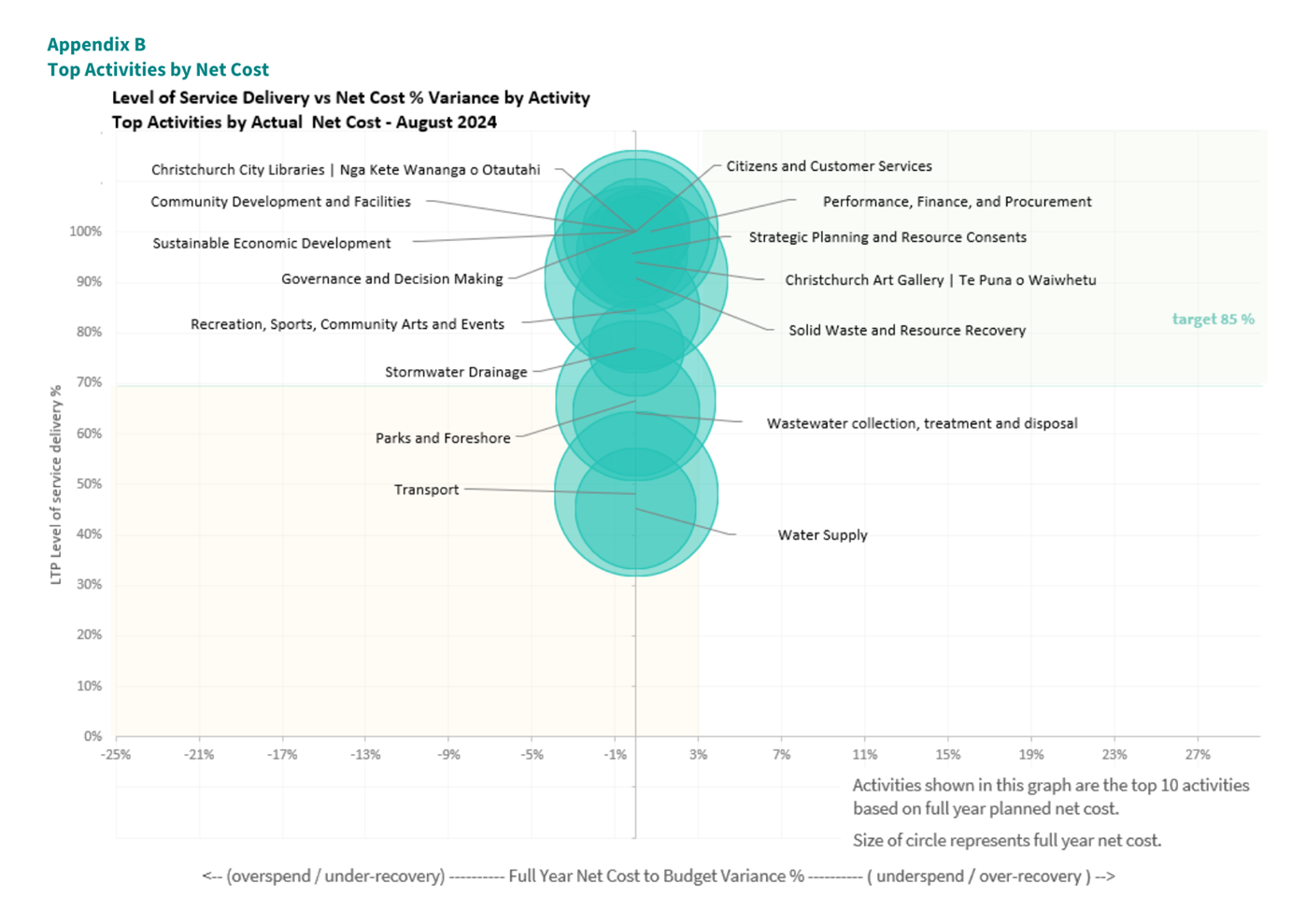

5.3 Brief summaries of material revenue and expenditure variances are highlighted below.
5.4 Revenues are $1.5 million ahead of budget year to date and are forecast to be $1.3 million higher at year end. Key drivers of actual and forecast variances to budget include:
Variance |
YTD |
Forecast (after c/f) |
Rates strike |
(0.2m) |
1.0m |
Transwaste Dividends |
- |
0.4m |
Building consent volumes (31% higher than FY24 same period) |
0.9m |
- |
Timing of Better Off Funding grant funding |
0.5m |
- |
Recreation & Sports pools and fitness centres increased participation |
0.3m |
- |
Hagley Park Parking Fees – installation of new parking metres not yet in place. |
(0.3m) |
- |
Other revenues |
0.3m |
(0.1m) |
Total |
1.5m |
1.3m |
5.5 Expenditure is $19.1 million lower than budget year to date and forecast to be $8.0 million under budget at year end.
Key drivers of actual and forecast variances to budget include:
Variance |
YTD |
Forecast (after c/f) |
Insurance Costs |
7.9m |
7.0m |
Christchurch Cathedral Grant unpaid (due to Council decision / suspension of works on Christchurch Cathedral) |
7.0m |
- |
Personnel Costs (Corporate increases not yet applied, units with vacancies which were planned to be filled e.g. Parks In-house maintenance team) |
3.2m |
1.4m |
Other minor variances |
1.0m |
(0.4m) |
Total |
19.1m |
8.0m |
5.6 Funds not available for Opex – the YTD variance largely relates to the Cathedral grant decision, funding from the special fund has not been drawn.
5.7 Operational revenue and expenditure prior year comparison:
|
FY25 Year to Aug Results |
|
FY24 Prior Year to Aug |
|
Var |
||||
$m |
Actual |
Budget |
Var |
|
Actual |
Budget |
Var |
|
Actual |
Operating revenue |
(31.2) |
(29.3) |
1.9 |
|
(29.5) |
(29.6) |
(0.1) |
|
(1.7) |
Dividends |
(3.0) |
(3.2) |
(0.2) |
|
(2.0) |
(3.1) |
(1.1) |
|
(1.0) |
Interest |
(9.4) |
(9.3) |
0.1 |
|
(8.9) |
(9.0) |
(0.1) |
|
(0.5) |
Rates income |
(191.0) |
(191.3) |
(0.3) |
|
(171.2) |
(169.9) |
1.3 |
|
(19.8) |
Revenue |
(234.6) |
(233.1) |
1.5 |
|
(211.6) |
(211.6) |
(0.0) |
|
(23.0) |
|
|
|
|
|
|
|
|
||
Personnel costs |
41.8 |
45.0 |
3.2 |
|
36.8 |
40.2 |
3.4 |
|
5.0 |
Less recharged to capital |
(8.0) |
(8.6) |
(0.6) |
|
(7.7) |
(8.3) |
(0.6) |
|
(0.3) |
Grants and levies |
9.5 |
15.5 |
6.0 |
|
12.4 |
10.9 |
(1.5) |
|
(2.9) |
Operating costs |
62.8 |
70.6 |
7.8 |
|
65.1 |
66.6 |
1.5 |
|
(2.3) |
Maintenance costs |
17.3 |
19.9 |
2.6 |
|
18.1 |
19.9 |
1.8 |
|
(0.8) |
Debt servicing |
24.4 |
24.5 |
0.1 |
|
21.0 |
21.5 |
0.5 |
|
3.4 |
Expenditure |
147.8 |
166.9 |
19.1 |
|
145.7 |
150.8 |
5.1 |
|
2.1 |
|
|
|
|
|
|
|
|
||
Net Cost |
(86.8) |
(66.2) |
20.6 |
|
(65.9) |
(60.8) |
5.1 |
|
(20.9) |
Other Funding |
|
|
|
|
|
|
|||
Transfers from Special Funds |
0.3 |
(8.9) |
(9.2) |
|
(0.8) |
(1.0) |
(0.2) |
|
1.1 |
Borrowing for opex |
- |
- |
- |
|
- |
(1.2) |
(1.2) |
|
- |
Less Rates for capex and debt repayment |
69.3 |
69.3 |
- |
|
62.6 |
62.6 |
- |
|
6.7 |
Funds not available for Opex |
69.6 |
60.4 |
(9.2) |
|
61.8 |
60.4 |
(1.4) |
|
7.8 |
|
|
|
|
|
|
|
|||
Operating Deficit / (Surplus) |
(17.2) |
(5.8) |
11.4 |
|
(4.1) |
(0.4) |
3.7 |
|
(13.1) |
5.8 Explanations for the actual Revenue & Expenditure prior year differences shown above:
Revenue |
FY-25 |
FY-24 |
Var |
Operating Revenue |
|
|
|
Building Consenting consent volumes |
(5.0m) |
(4.2m) |
(0.8m) |
Three Waters Trade Waste charges |
(1.0m) |
(0.3m) |
(0.7m) |
Dividends |
|
|
|
Higher declared final Transwaste dividend |
(3.0m) |
(2.0m) |
(1.0m) |
Rates Income |
|
|
|
Rates increase – higher overall rates to be collected by council |
(190.5m) |
(170.6m) |
(19.9m) |
|
|
|
|
Expenditure |
FY-25 |
FY-24 |
Var |
Personnel Costs |
|
|
|
Higher personnel costs due to increases in FTE (127) & FY24 payrates |
40.3m |
35.3m |
5.0m |
Grants and Levies |
|
|
|
Events ecosystem & partnership grants payments |
0.2m |
3.2m |
3.0m |
Operating Costs |
|
|
|
Insurance Costs – Negotiations with brokers |
29.6m |
31.1m |
(1.5m) |
Rates on council owned properties – council rates charged increased |
8.9m |
8.1m |
0.8m |
Planning and Consenting – reduced reliance on consultants |
0.3m |
0.8m |
(0.6m) |
Three Waters – Wastewater Pumping & Water Supply Treatment service contracts |
2.4m |
2.9m |
(0.5m) |
Maintenance Costs |
|
|
|
Community Parks operations maintenance |
0.7m |
1.7m |
(1.0m) |
Community Housing maintenance |
0.8m |
0.6m |
0.2m |
Debt Servicing |
|
|
|
Higher debt levels resulting in increased ratepayer debt interest costs |
14.0m |
10.8m |
3.2m |
6. Capital Expenditure and Revenue
6.1 This section covers the capital programme spend and funding relating to it.
Year to Date Results |
Forecast Year End Results |
After Carry Forwards |
|||||||||
$m |
Actual |
Budget |
Var |
|
Forecast |
Budget |
Var |
|
Carry Fwd |
Var |
|
Core Programme |
47.1 |
48.2 |
1.1 |
|
532.1 |
521.5 |
(10.6) |
|
(21.0) |
10.4 |
|
External Funded Programme |
2.3 |
2.4 |
0.1 |
|
26.4 |
25.8 |
(0.6) |
|
0.7 |
(1.3) |
|
Less unidentified Carry Forwards |
0.0 |
0.0 |
0.0 |
|
(48.5) |
0.0 |
48.5 |
|
57.4 |
(8.9) |
|
Core/External Funded Programme |
49.4 |
50.6 |
|
|
510.0 |
547.3 |
37.3 |
|
37.1 |
0.2 |
|
Te Kaha |
15.8 |
17.7 |
1.9 |
|
188.4 |
190.2 |
1.8 |
|
1.8 |
- |
|
Total Capital Programme |
65.2 |
68.3 |
3.1 |
|
698.4 |
737.5 |
39.1 |
|
38.9 |
0.2 |
|
Revenues and Funding |
(60.4) |
(64.6) |
(4.2) |
|
(330.8) |
(330.5) |
0.2 |
|
- |
0.2 |
|
Borrowing required |
4.8 |
3.7 |
|
|
367.6 |
407.0 |
39.3 |
|
38.9 |
0.4 |
|
Capital Expenditure
6.2 Gross capital expenditure of $65.2 million has been incurred against a year-to-date budget of $68.3 million.
6.3 Overall, total capital expenditure of $698.4 million is forecast (based on the PMO forecast of $510 million for CCC Capital-Core/External Funded), to be spent against the annual budget of $737.5 million. Of the $39.1 million variance, the majority is forecast to be requested to be carried forward at year end.
Capital Revenues and Funding
6.5 Capital revenues and funding are a net $4.2 million lower than budget year to date, due to Council having received lower NZTA MCR capital contributions, partially offset by higher development contribution revenues.
6.6 Capital revenues and funding are forecast to be in-line with budget at year end.
7. Treasury
Policy Compliance
7.1 All Treasury risks are within Policy limits, with no breaches projected over the coming year:
Risk Area |
Compliance |
Plain-language meaning |
Liquidity Risk |
Yes |
(cash availability) |
Funding Risk |
Yes |
(spread of debt maturities) |
Interest Rate Risk |
Yes |
(managing interest costs) |
Counterparty Credit Risk |
Yes |
(not all eggs in one basket) |
Borrowing & Advances to Related Parties
7.2 Council’s actual and forecast borrowing and advances are shown below ($ million):
7.3 Advances are primarily to Christchurch City Holdings Ltd (CCHL, currently $681.2 million, unchanged year to date) and to the Local Government Funding Agency for Borrower Notes (currently $59.0 million, up $3.0m year to date).
7.4 By the end of June 2025, Net Debt (excluding cash balances) is projected to increase by $334.5 million, driven by capital expenditure (particularly Te Kaha). Advances are projected to decrease by $29.8 million, driven by CCHL repayments.
Funding & Interest Rates

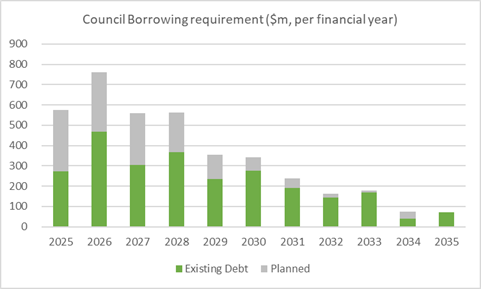

7.5 Council’s projected funding requirements, per financial year, are shown below. These are split between existing debt maturities (green) and expected new borrowing requirements (grey).
7.6 Council’s interest rate risk is managed to reduce the volatility of interest costs from year to year. The interest rate on most existing Council debt has been fixed until at least June 2027, which has limited the impact of rising market interest rates over the past two years; New borrowing requirements over the next two years will be able to take advantage of the more recent and on-going decrease in market interest rates, broadly in line with 2024-34 Long Term Plan projections.
The average for 2023/24 was 5.1%; pre-Covid, in 2018/19, it was 5.2%.
Attachments Ngā Tāpirihanga
There are no attachments for this report.
In addition to the attached documents, the following background information is available:
Document Name – Location / File Link |
Not applicable
|
Signatories Ngā Kaiwaitohu
Authors |
Mitchell Shaw - Reporting Accountant Steve Ballard - Group Treasurer Karthik MG - Reporting Accountant |
Approved By |
Bruce Moher - Manager Corporate Reporting Bede Carran - General Manager Finance, Risk & Performance / Chief Financial Officer |
Reference Te Tohutoro: |
24/1190968 |
Responsible Officer(s) Te Pou Matua: |
Nicky Palmer, Head of Programme Management Office |
Accountable ELT Member Pouwhakarae: |
Brent Smith, Acting General Manager City Infrastructure |
1. Purpose and Origin of the Report Te Pūtake Pūrongo
1.1 The purpose of this report is to present to the Finance and Performance Committee meeting the monthly Capital Programme Performance Report for August 2024. This is the first report of the new Financial Year 2024/25 (FY25).
1.2 This report provides Elected Members with oversight on the performance of the Capital Programme.
2. Officer Recommendations Ngā Tūtohu
That the Finance and Performance Committee:
1. Receives the information in the Capital Programme Performance Report August 2024.
3. Background/Context Te Horopaki
3.2 The year-end forecast for CCC Capital (excl. Te Kaha) as reported by Project Managers is $550.6m (101% of budget). This is within 8% of the PMO year-end forecast of $510m.

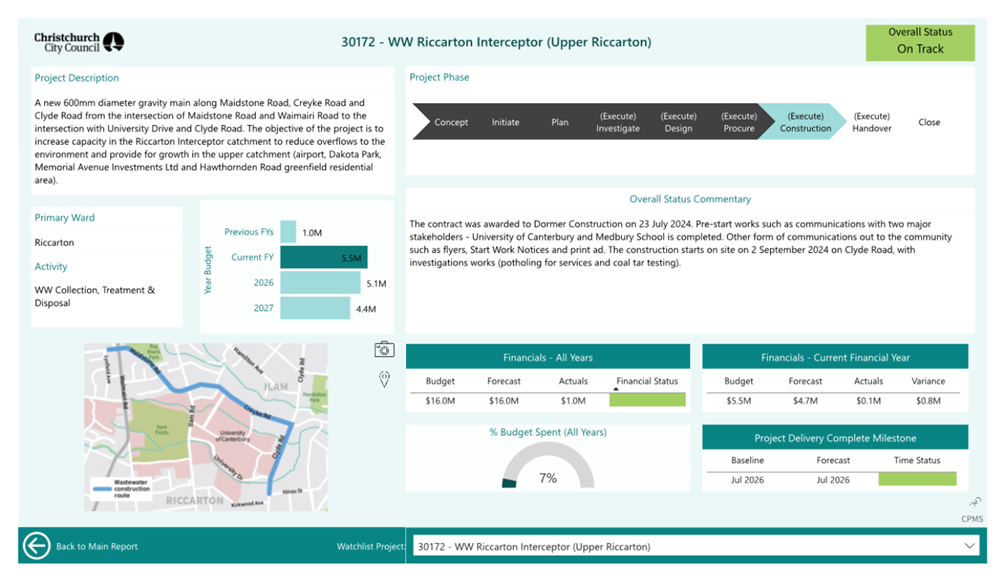

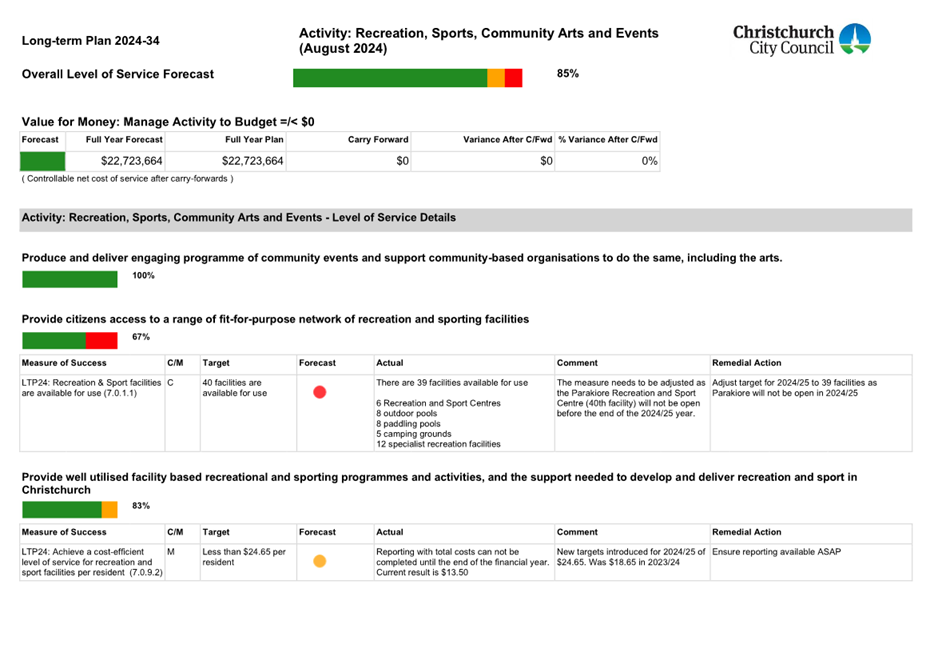

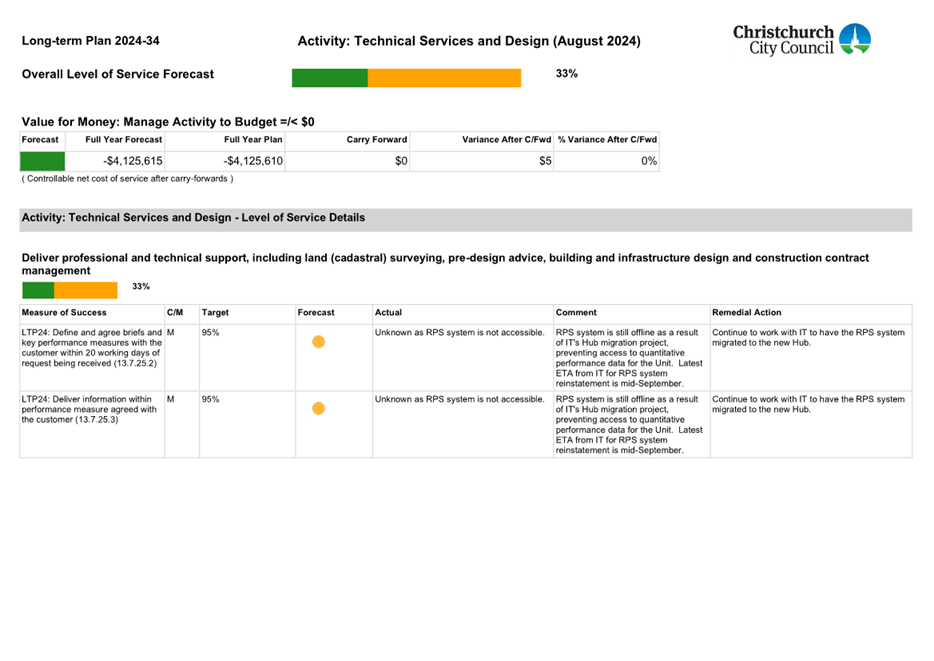

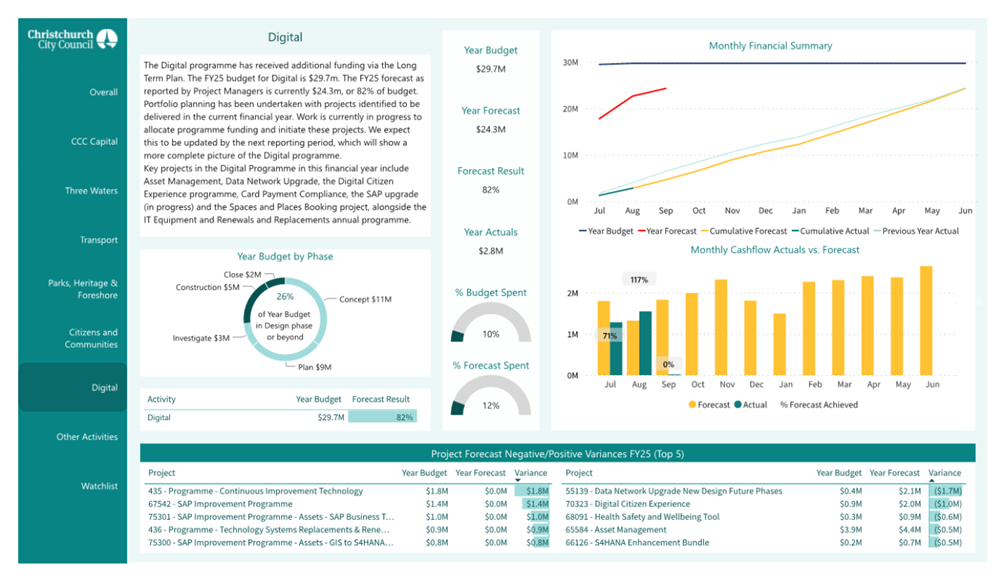

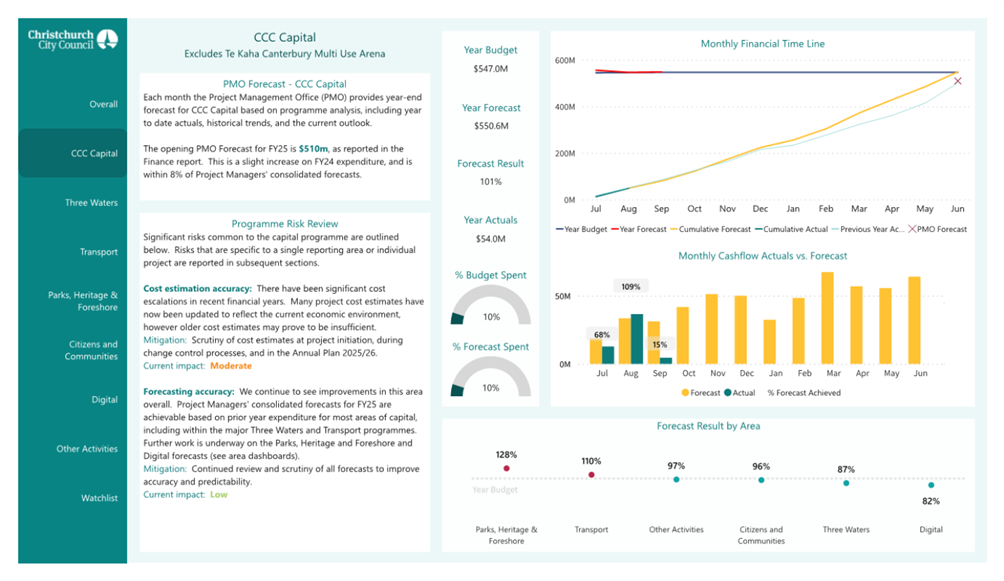

3.3 Full results are provided in the Capital Programme Performance Report (Attachment A). Several updates to this report have been made for FY25:

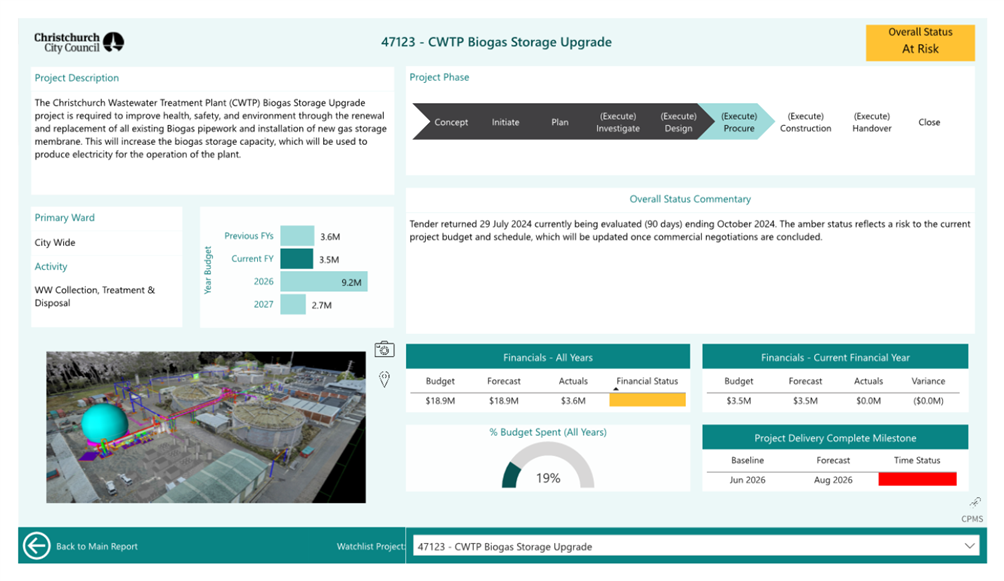

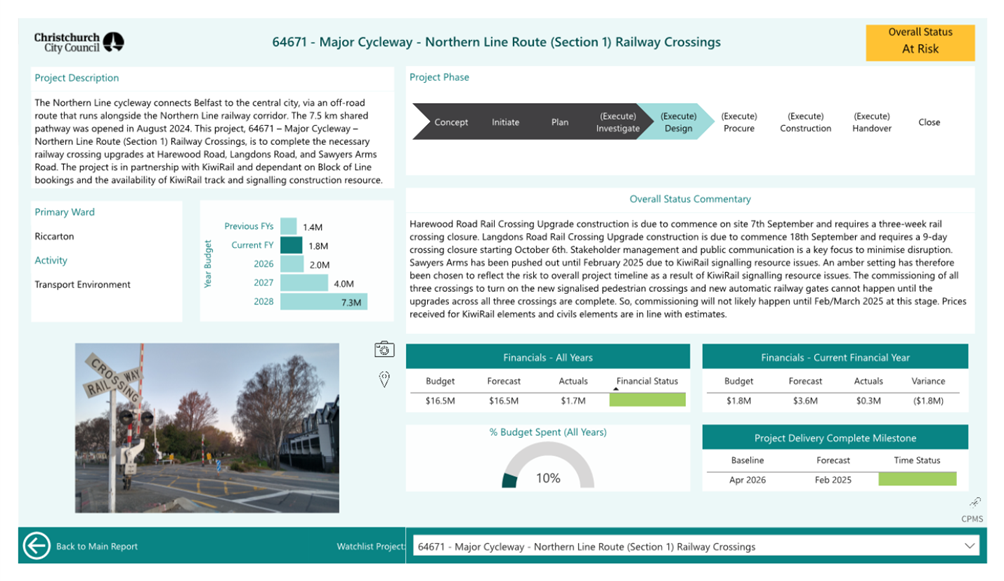

3.3.1 The area dashboards have been re-aligned to Activity for consistency with Long Term Plan / Annual Plan processes and other reporting. This means that OARC projects are now represented in the Three Waters, Transport, and Parks dashboards, where the capital budgets for the individual activities are held. Activities with smaller FY25 capital budgets have also been grouped together in the area dashboards. Recreation, Sports and Events can now be found within the new ‘Citizens & Communities’ dashboard, and Solid Waste & Resource Recovery within the ‘Other Activities’ dashboard.

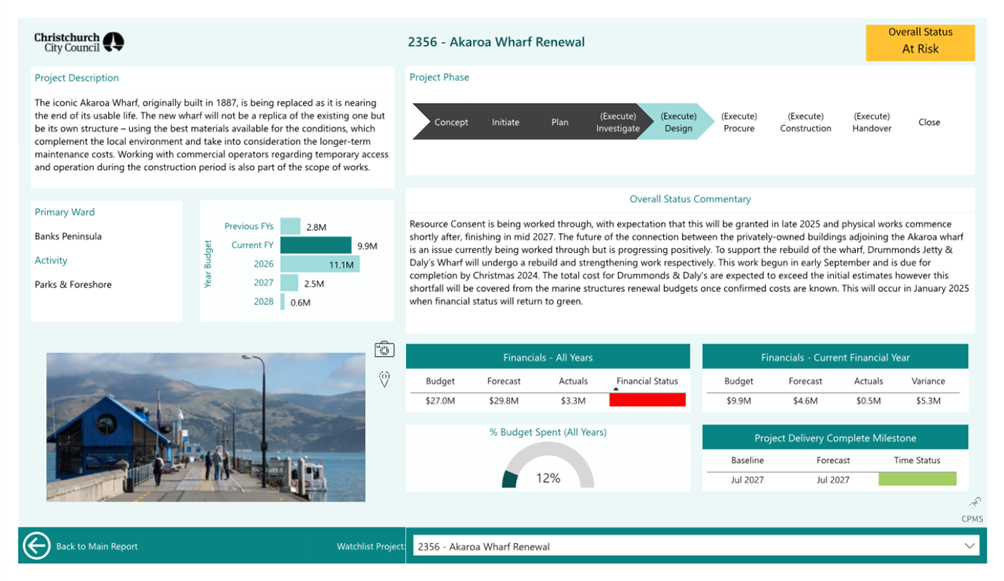

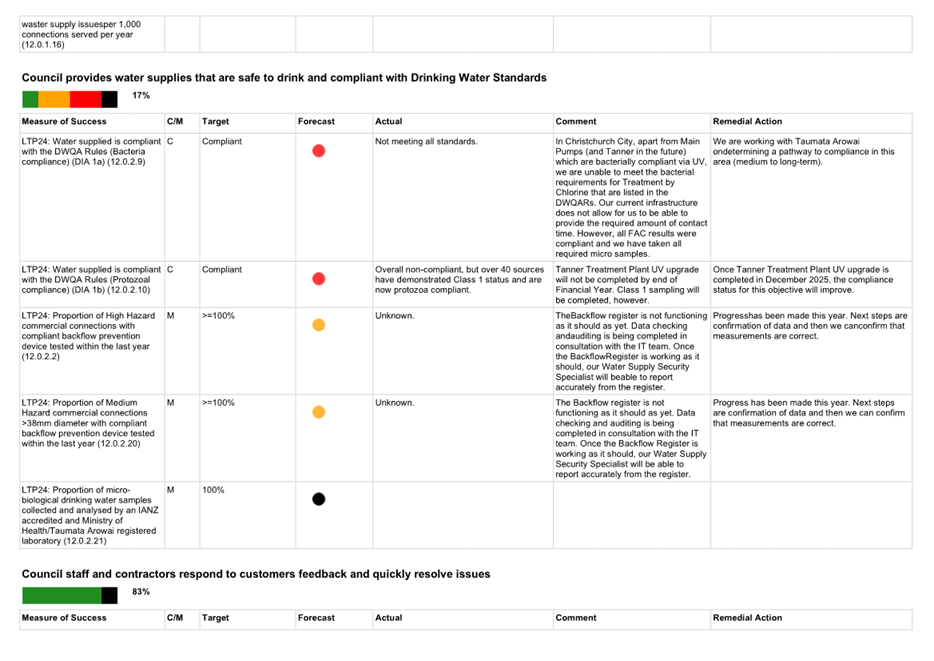

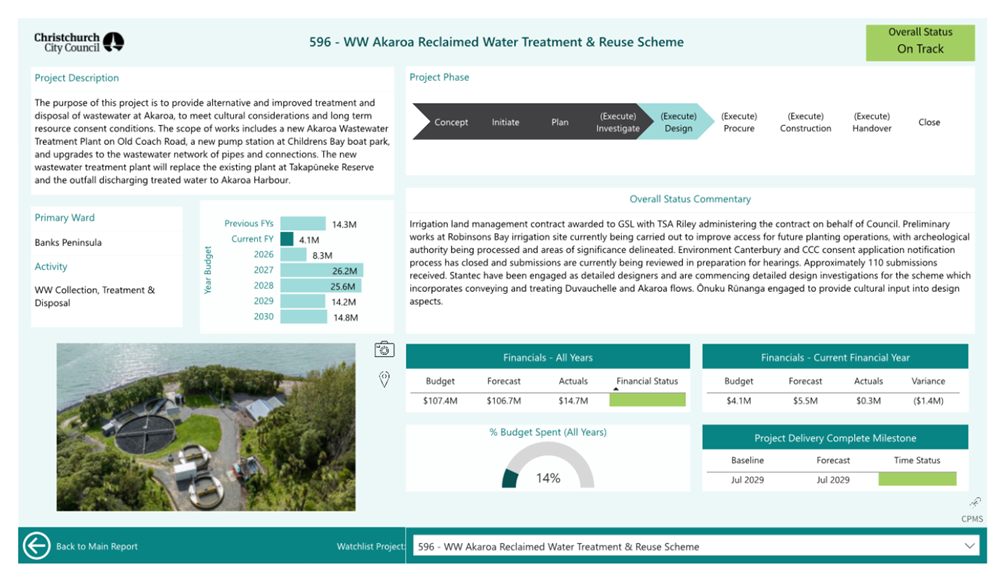

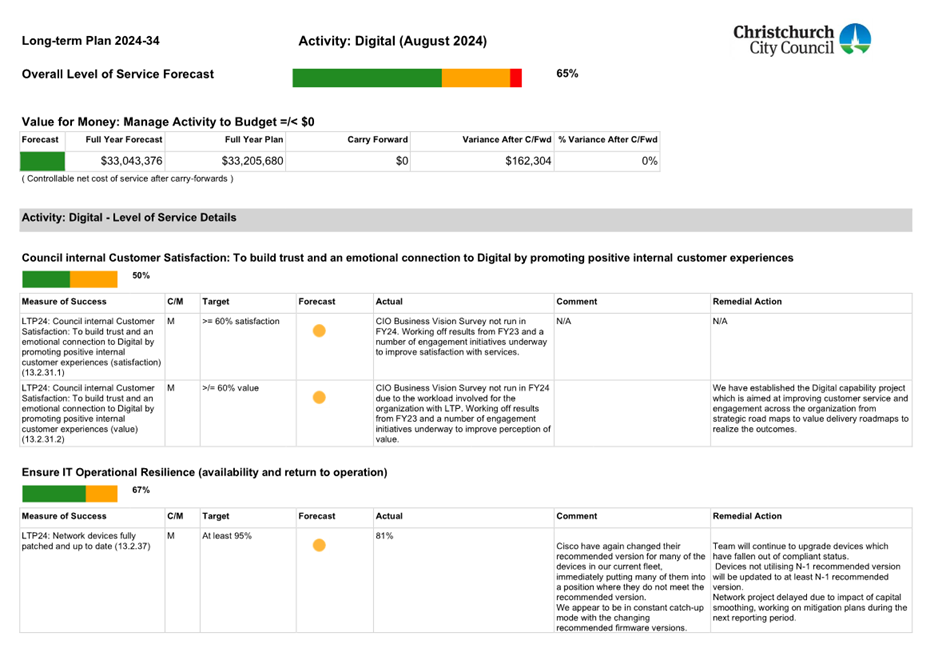

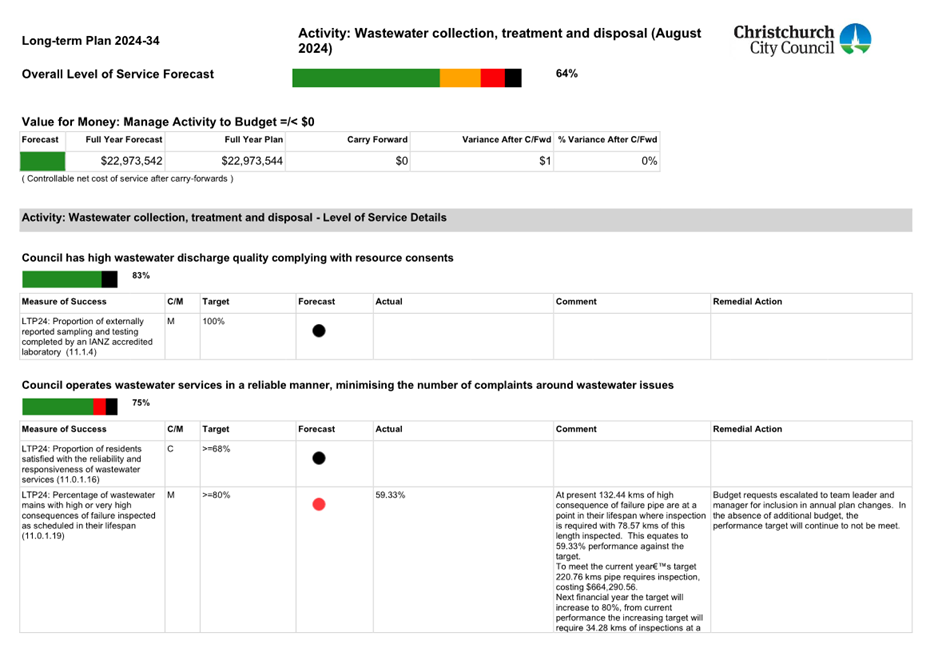

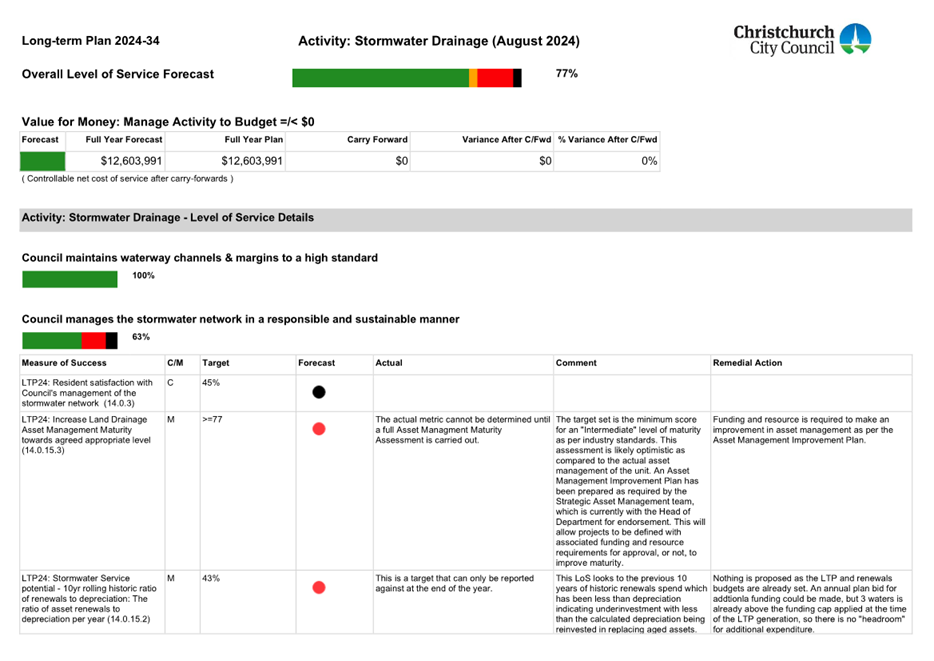

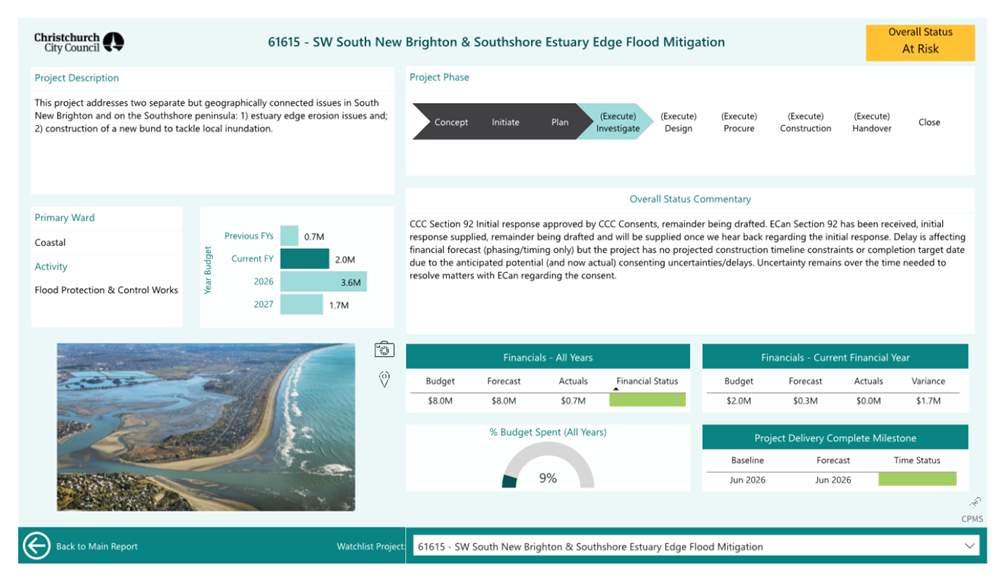

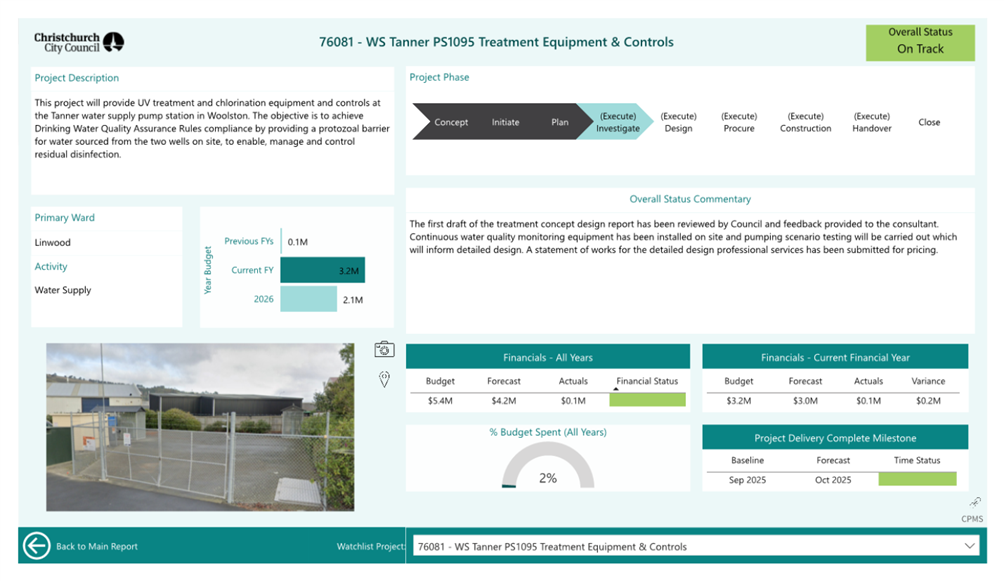

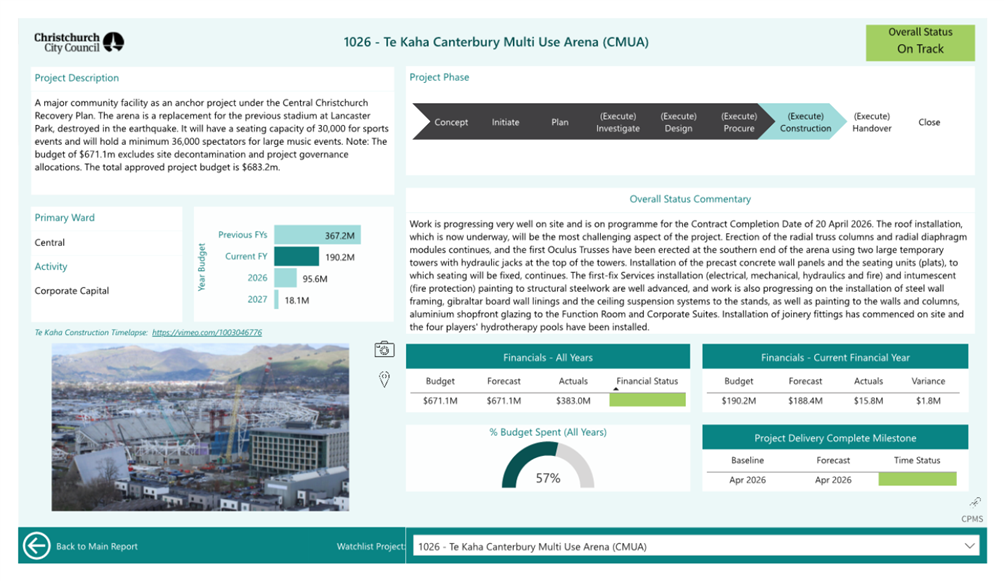

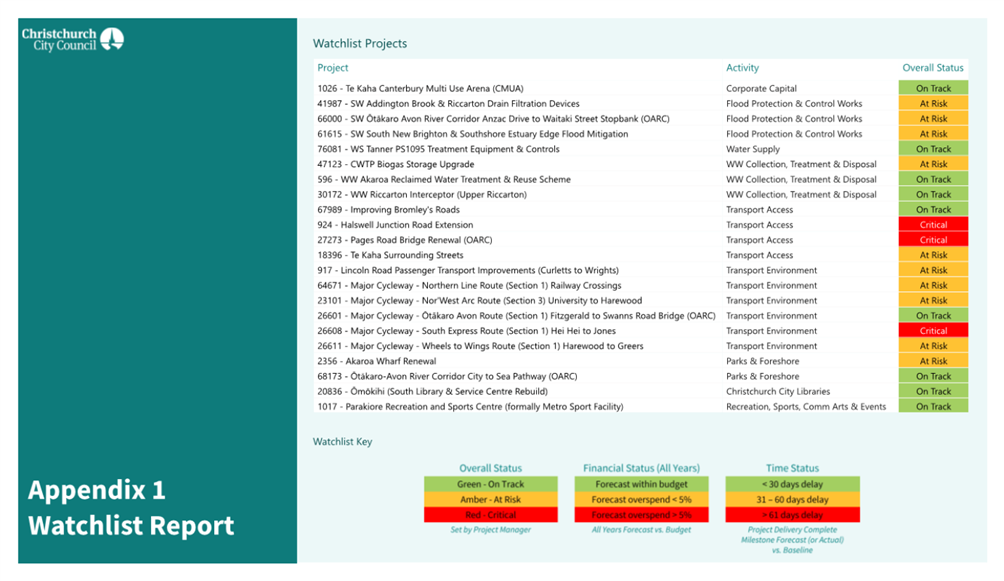

3.3.2 The set of Watchlist projects has been updated for FY25, as confirmed at the Finance & Performance Committee meeting in August 2024. The monthly Watchlist Report is provided as Attachment A - Appendix 1.

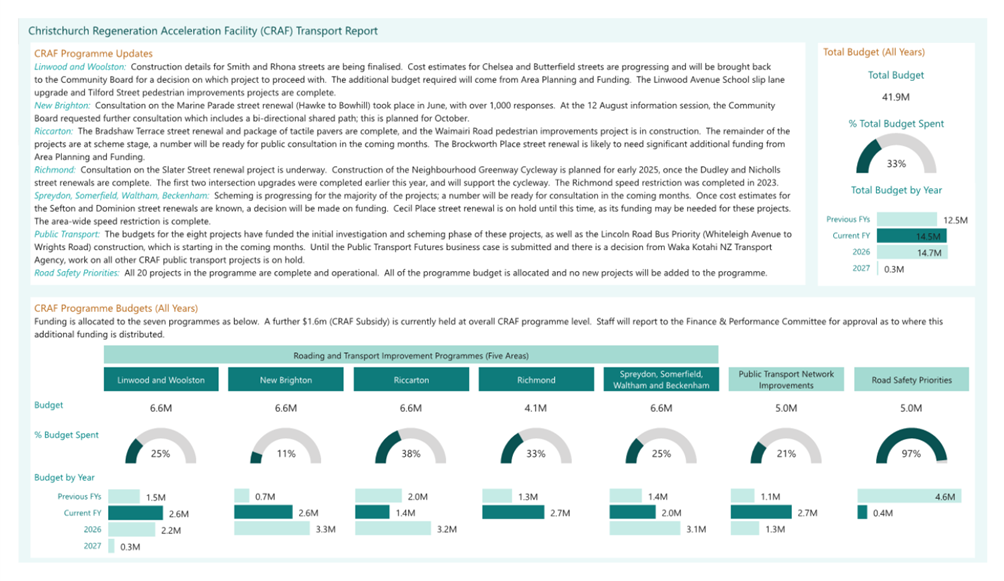

3.3.3 The quarterly Transport Choices Report has been retired for FY25, following the discontinuation of central government funding. The quarterly Transport CRAF Report continues and is provided this month as Attachment A – Appendix 2.
3.4 The Monthly Change Report is included in the public excluded section due to contract commercial sensitivity.
Attachments Ngā Tāpirihanga
No. |
Title |
Reference |
Page |
a ⇩ |
Attachment to report 24/1190895 (Title: Capital Programme Performance Report - August 2024 Final) |
24/1590379 |
73 |
In addition to the attached documents, the following background information is available:
Document Name – Location / File Link |
Not applicable
|
Signatories Ngā Kaiwaitohu
Authors |
Lauren Barry - Senior PMO Business Analyst Greer Hill - Administrator Officer |
Approved By |
Brent Smith - Acting General Manager City Infrastructure |
Section 48, Local Government Official Information and Meetings Act 1987.
I move that the public be excluded from the following parts of the proceedings of this meeting, namely items listed overleaf.
Reason for passing this resolution: good reason to withhold exists under section 7.
Specific grounds under section 48(1) for the passing of this resolution: Section 48(1)(a)
Note
Section 48(4) of the Local Government Official Information and Meetings Act 1987 provides as follows:
“(4) Every resolution to exclude the public shall be put at a time when the meeting is open to the public, and the text of that resolution (or copies thereof):
(a) Shall be available to any member of the public who is present; and
(b) Shall form part of the minutes of the local authority.”
This resolution is made in reliance on Section 48(1)(a) of the Local Government Official Information and Meetings Act 1987 and the particular interest or interests protected by Section 6 or Section 7 of that Act which would be prejudiced by the holding of the whole or relevant part of the proceedings of the meeting in public are as follows:
GENERAL SUBJECT OF EACH MATTER TO BE CONSIDERED |
SECTION |
SUBCLAUSE AND REASON UNDER THE ACT |
PLAIN ENGLISH REASON |
WHEN REPORTS CAN BE REVIEWED FOR POTENTIAL RELEASE |
|
11. |
Public Excluded Finance and Performance Committee Minutes - 28 August 2024 |
|
|
Refer to the previous public excluded reason in the agendas for these meetings. |
|
12. |
Visibility of Capital Project Budget Changes: August 2024 |
s7(2)(h) |
Commercial Activities |
The report contains information on specific projects being tendered in the open market and accordingly it may put Council in a disadvantaged position. |
This report can be released to the public once all commercial negotiations and contracts have been concluded, and subject to the approval of the Head of Procurement and Contracts |
13. |
Banks Peninsula - Roading Maintenance Services Procurement Plan 29370140 |
s7(2)(b)(ii), s7(2)(i) |
Prejudice Commercial Position, Conduct Negotiations |
This report details the strategy and approval prior to tender; commercially senstive information. |
30 April 2025 |
14. |
Changes to Ōtautahi Community Housing Trust Financial Security Agreements |
s7(2)(i) |
Conduct Negotiations |
Council is negotiating changes to security arrangements with the Ōtautahi Community Housing Trust. Publicly releasing details prior to the completion of negotiations may impact on the Council's position. |
On completion of negotiations |
